• Thread starter Suicidal Gingerbread Man
  • Start date

Johnny Au

Senior Member
Member Bio
Joined
Apr 5, 2010
Messages
8,372
Reaction score
12,111
July 6, 2022:



mburrrrr

Senior Member
Member Bio
Joined
Feb 10, 2010
Messages
1,047
Reaction score
14,105
My dates from looking at the pictures from the past few years. .

CIBC phase 1
2017 05 21 demo started
2017 07 17 shoring started - 2 months
2017 09 21 excavation started -4 months
2018 01 27 three cranes at base - 7 months
2018 05 01 excavation complete - 12 months
2018 06 01 part at grade - 13 months

Phase 2
2020 12 01 demo started
2021 02 11 shoring started - 2 months
2021 05 25 excavation started - 5 months
2021 10 29 three cranes at base - 11 months
2022 05 02 core at grade - 17 months
2022 07 31 excavation complete - 20 months

The podium should be quicker without the bus terminal requirements in phase 1

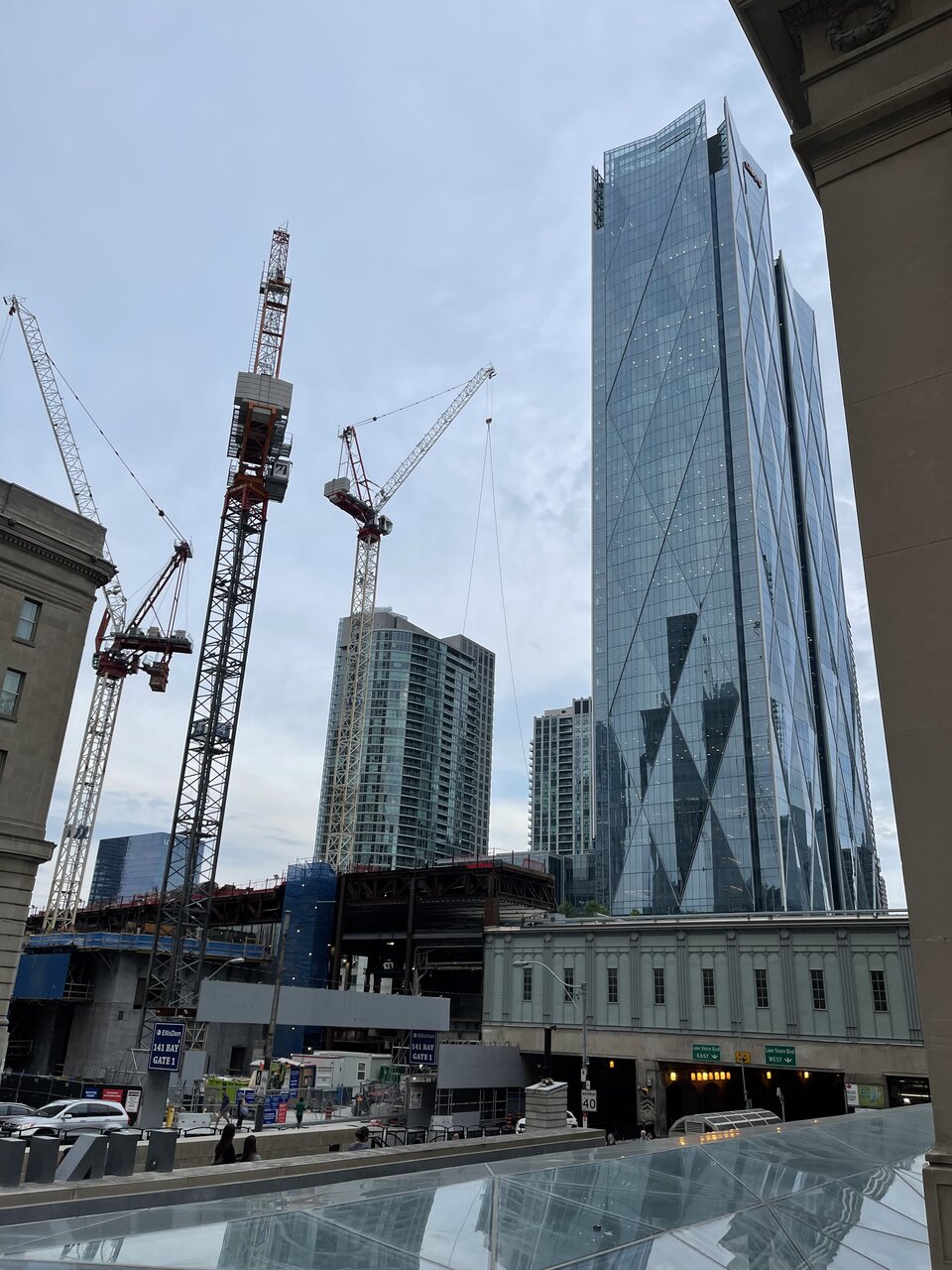

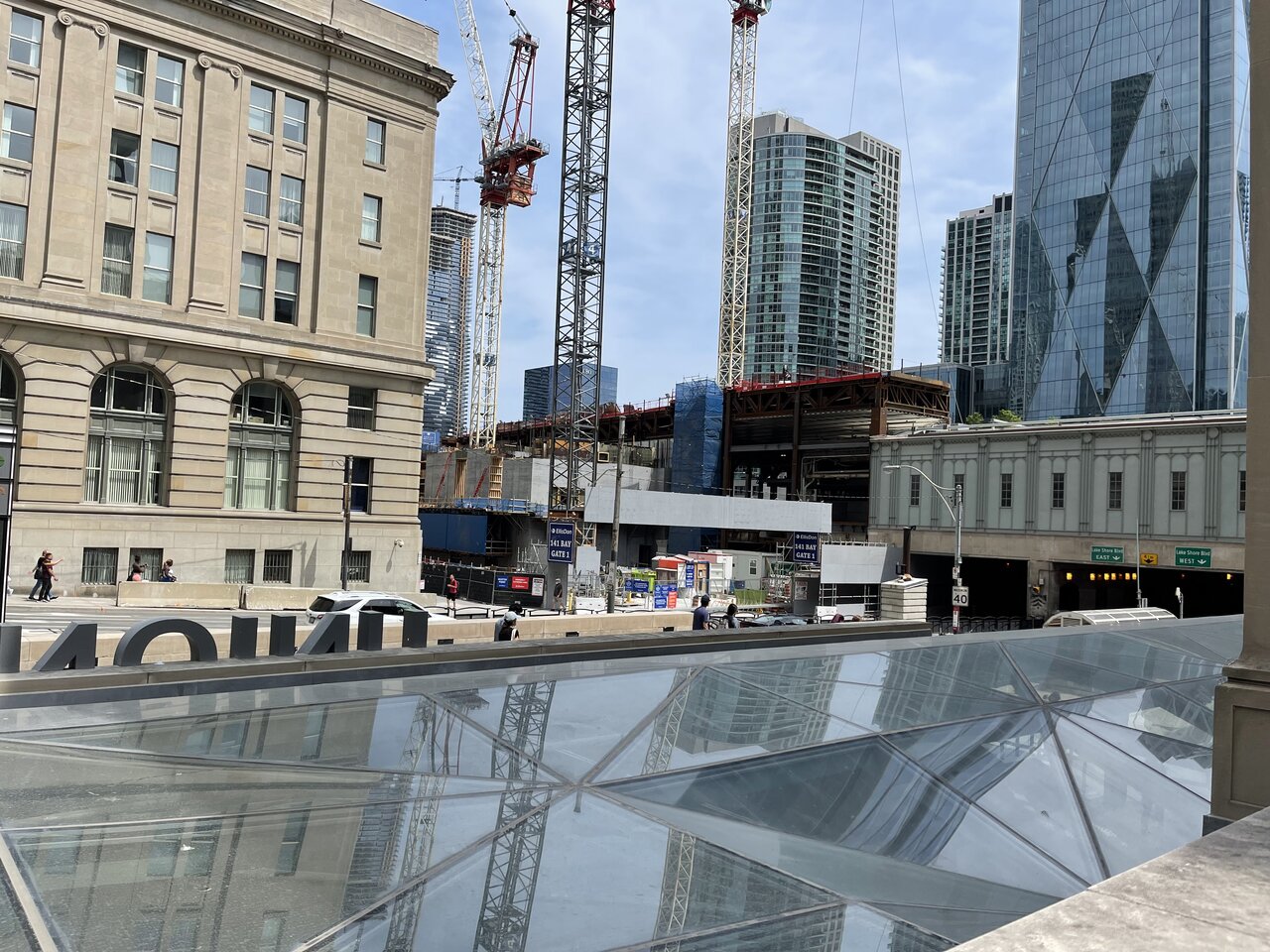

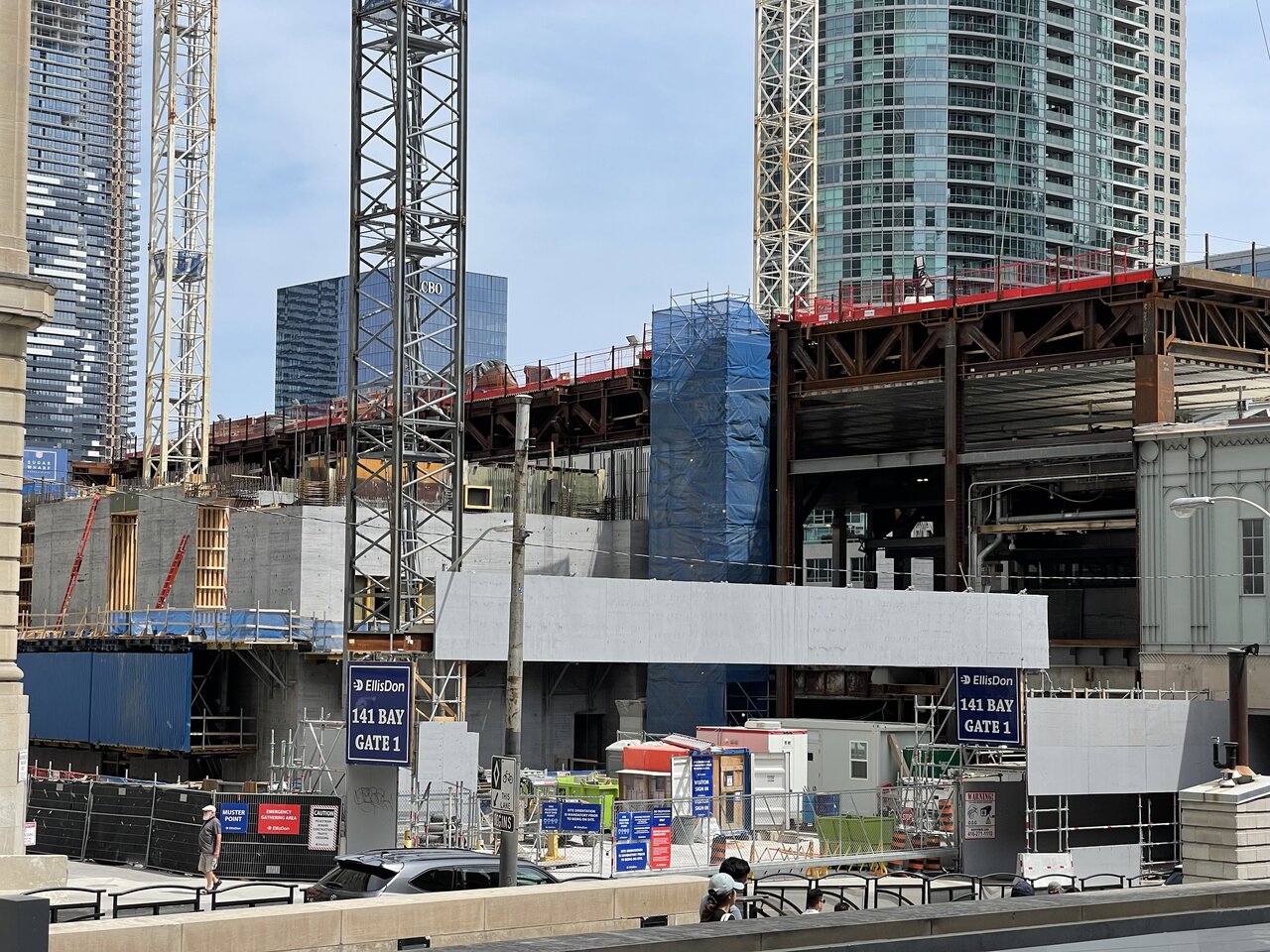

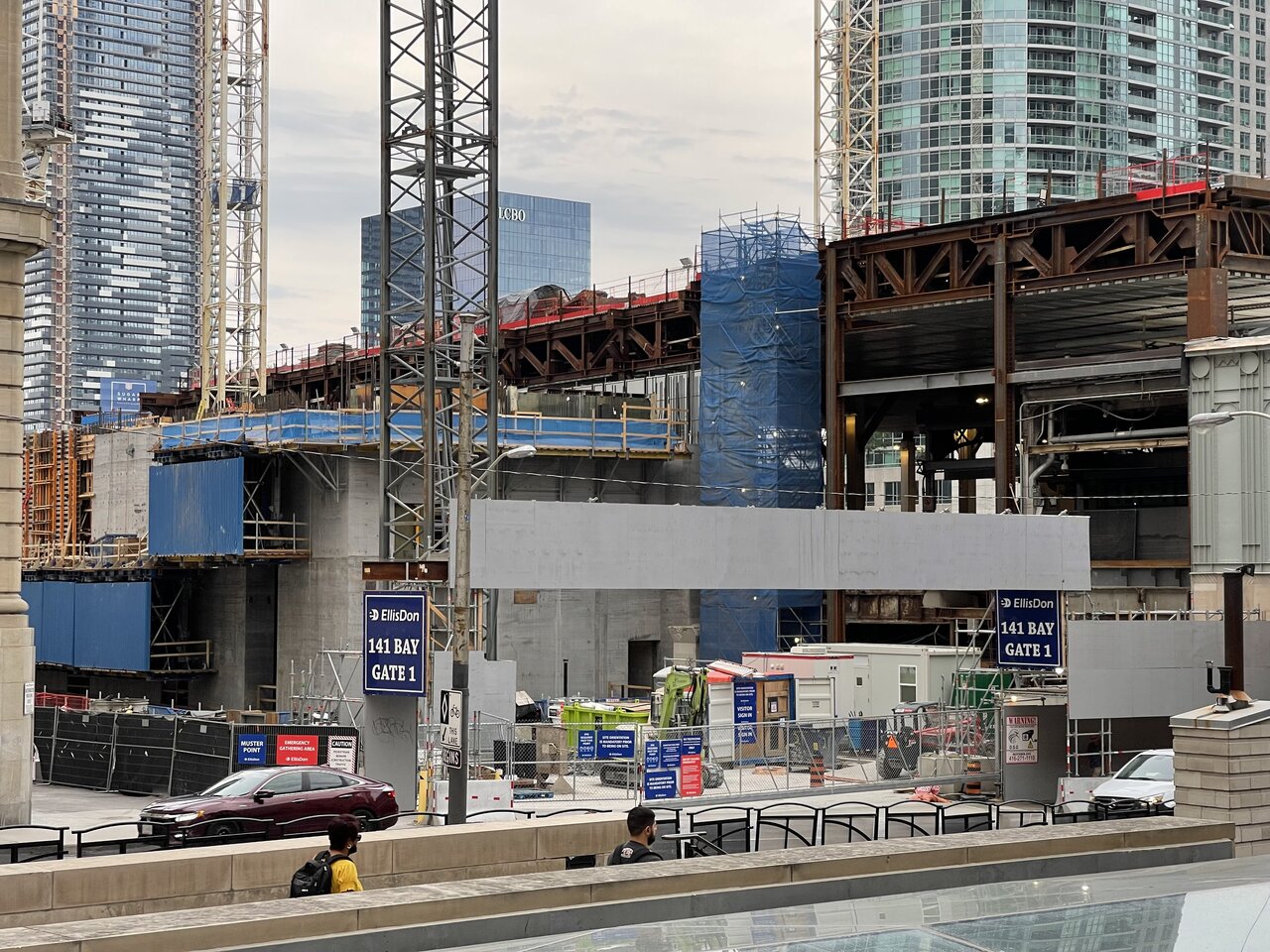

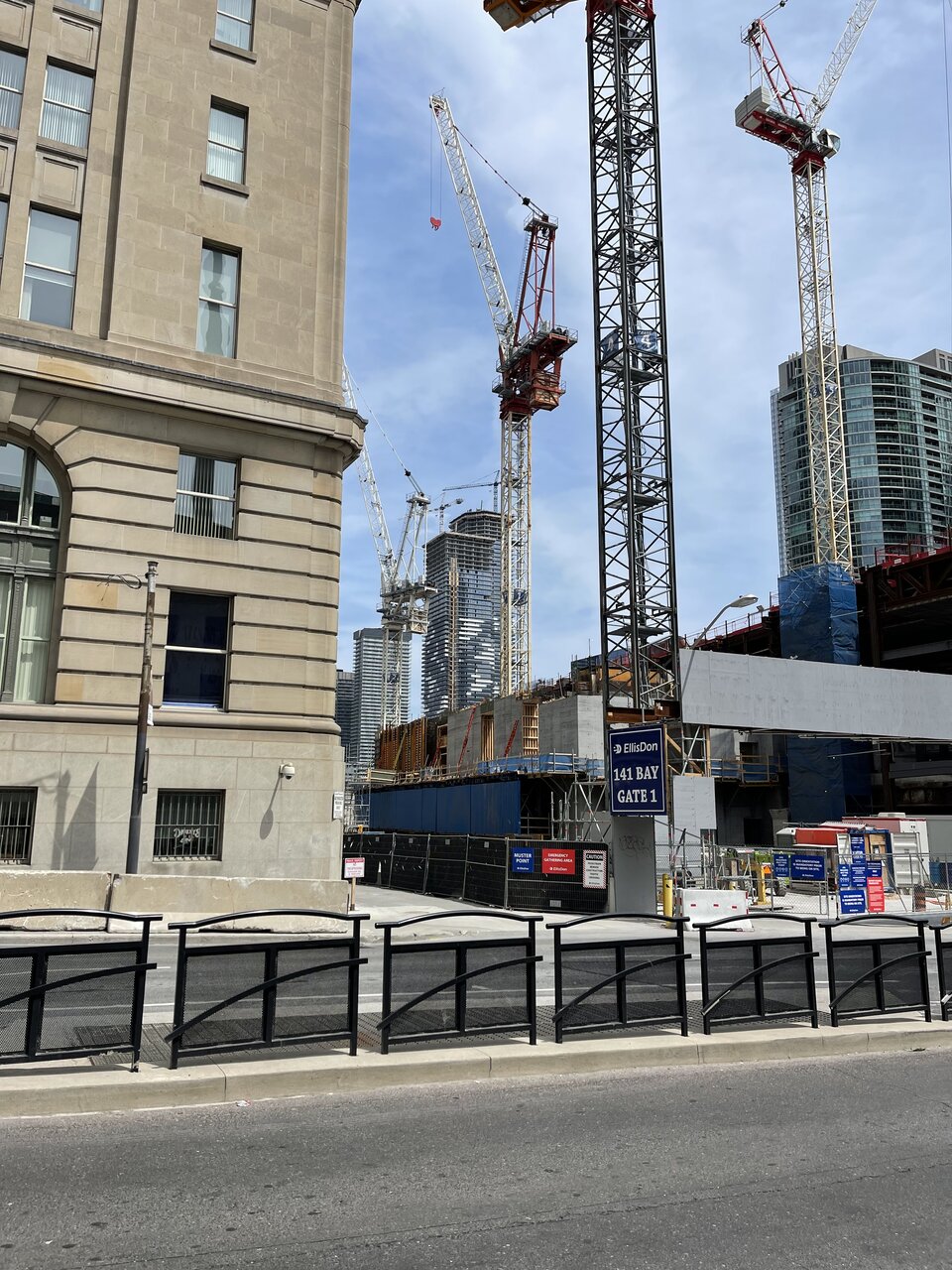

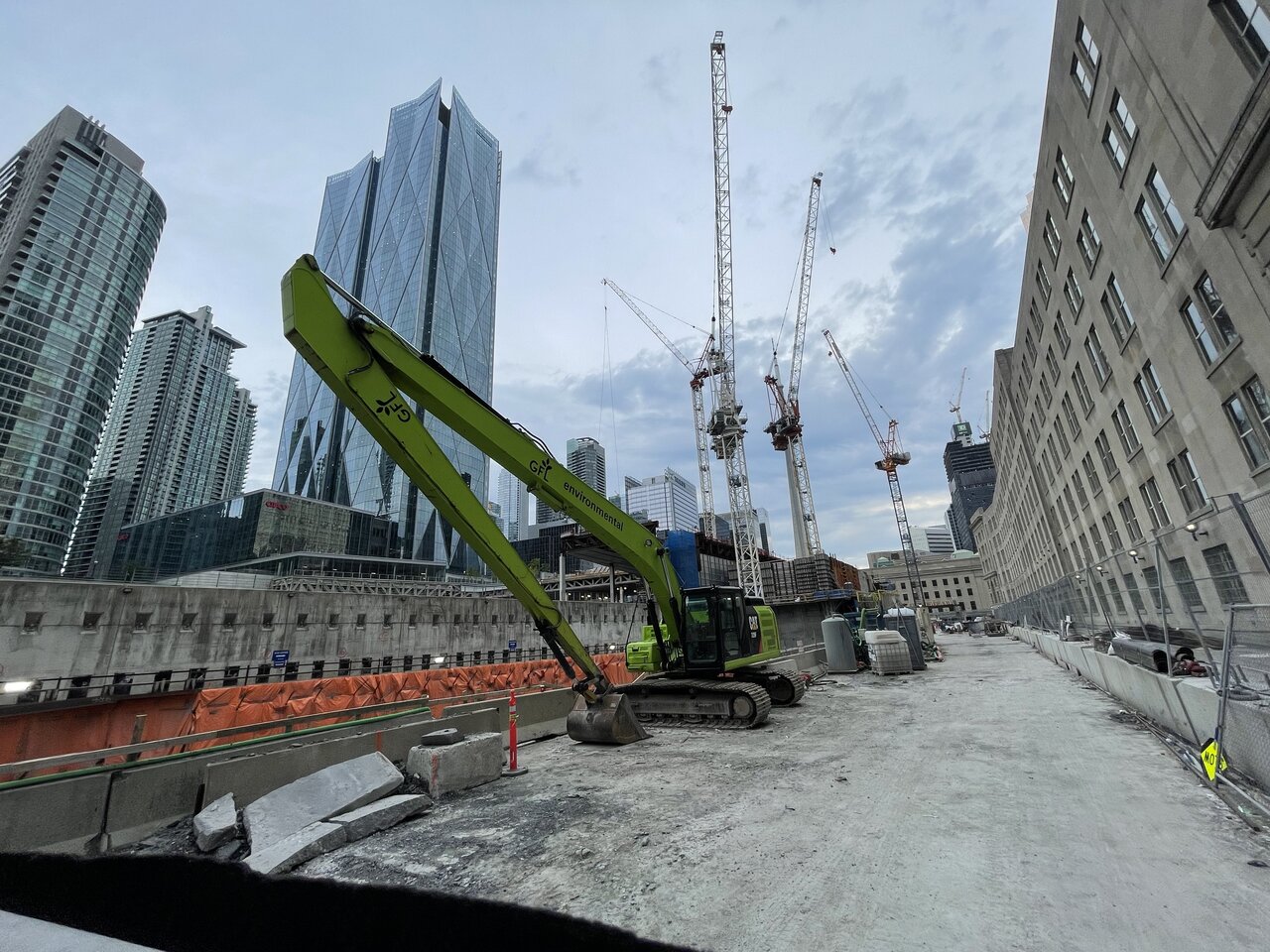

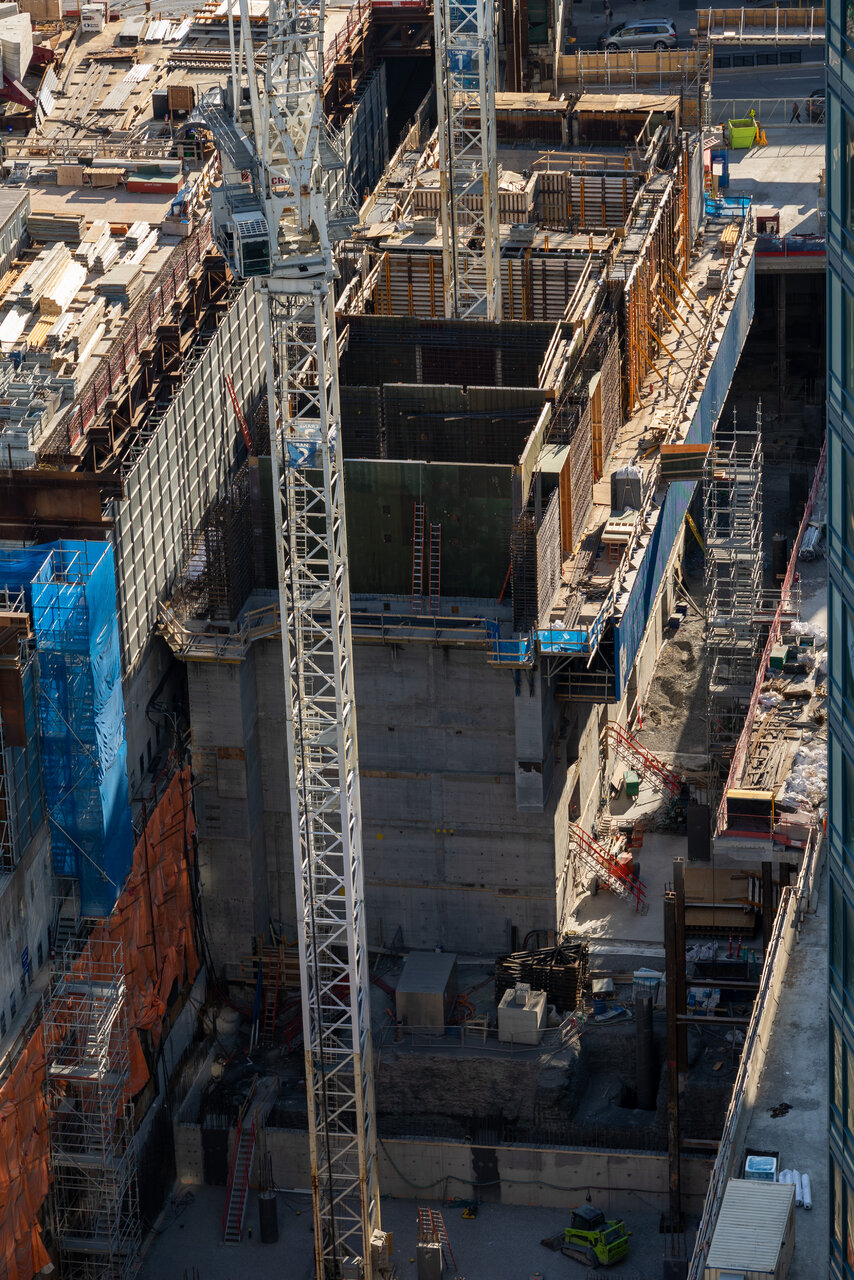

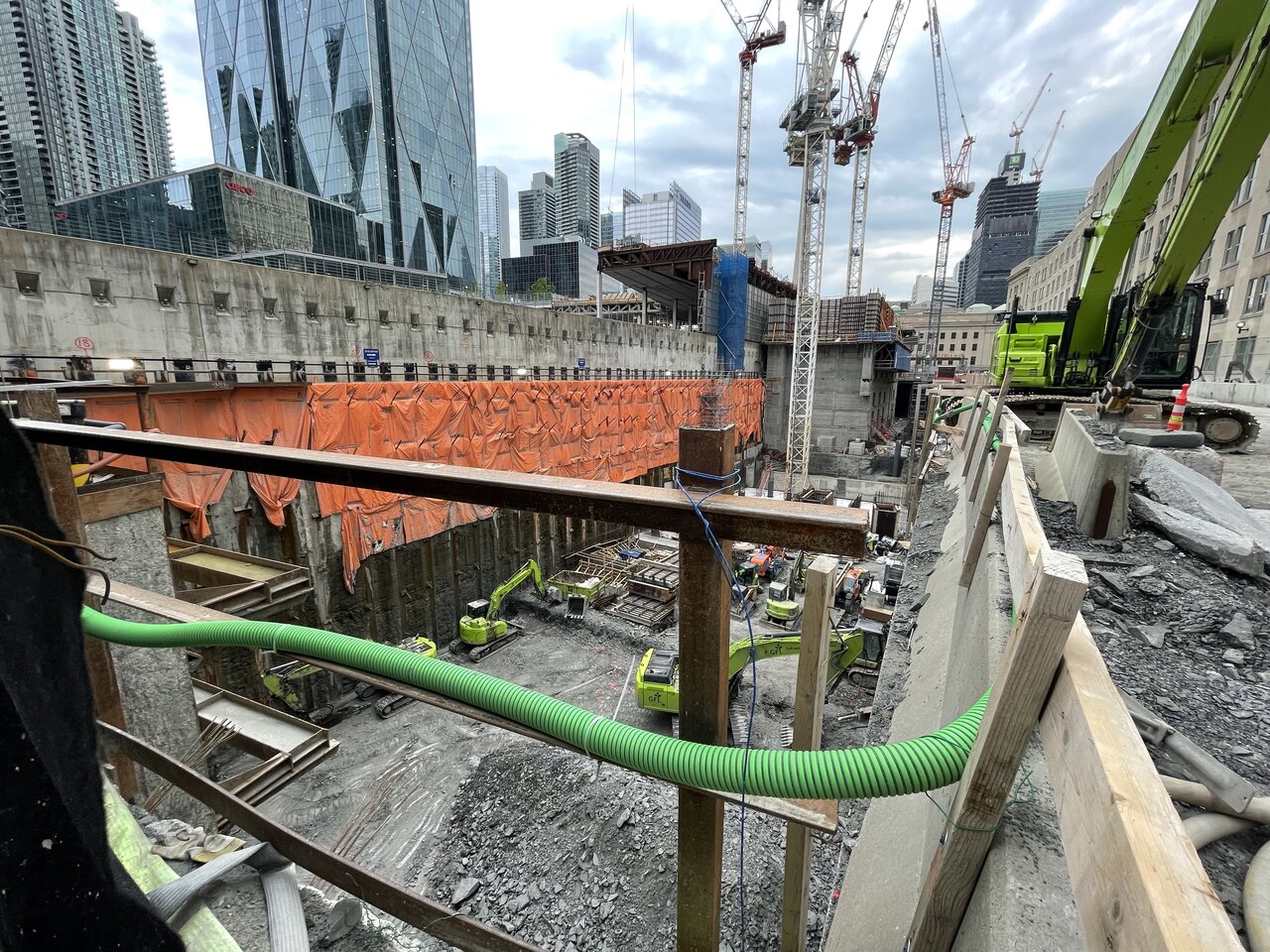

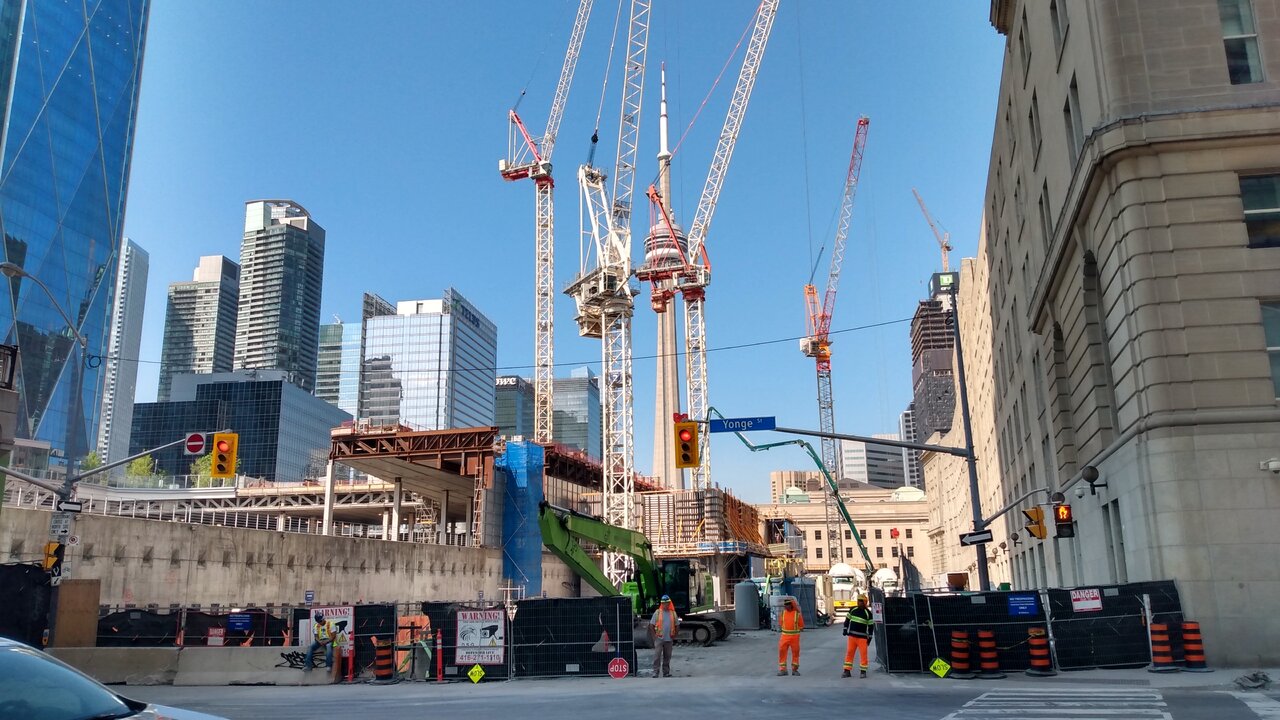

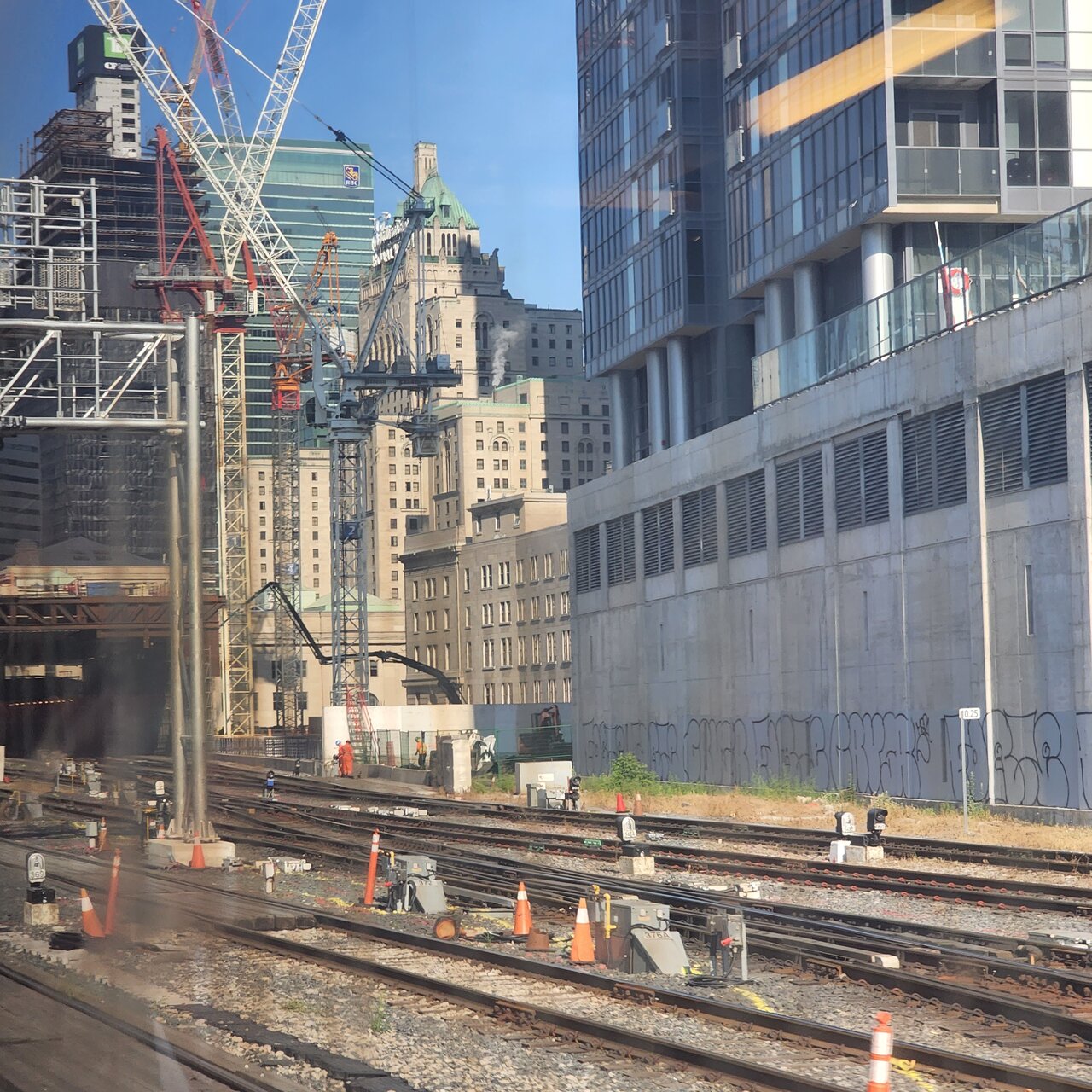

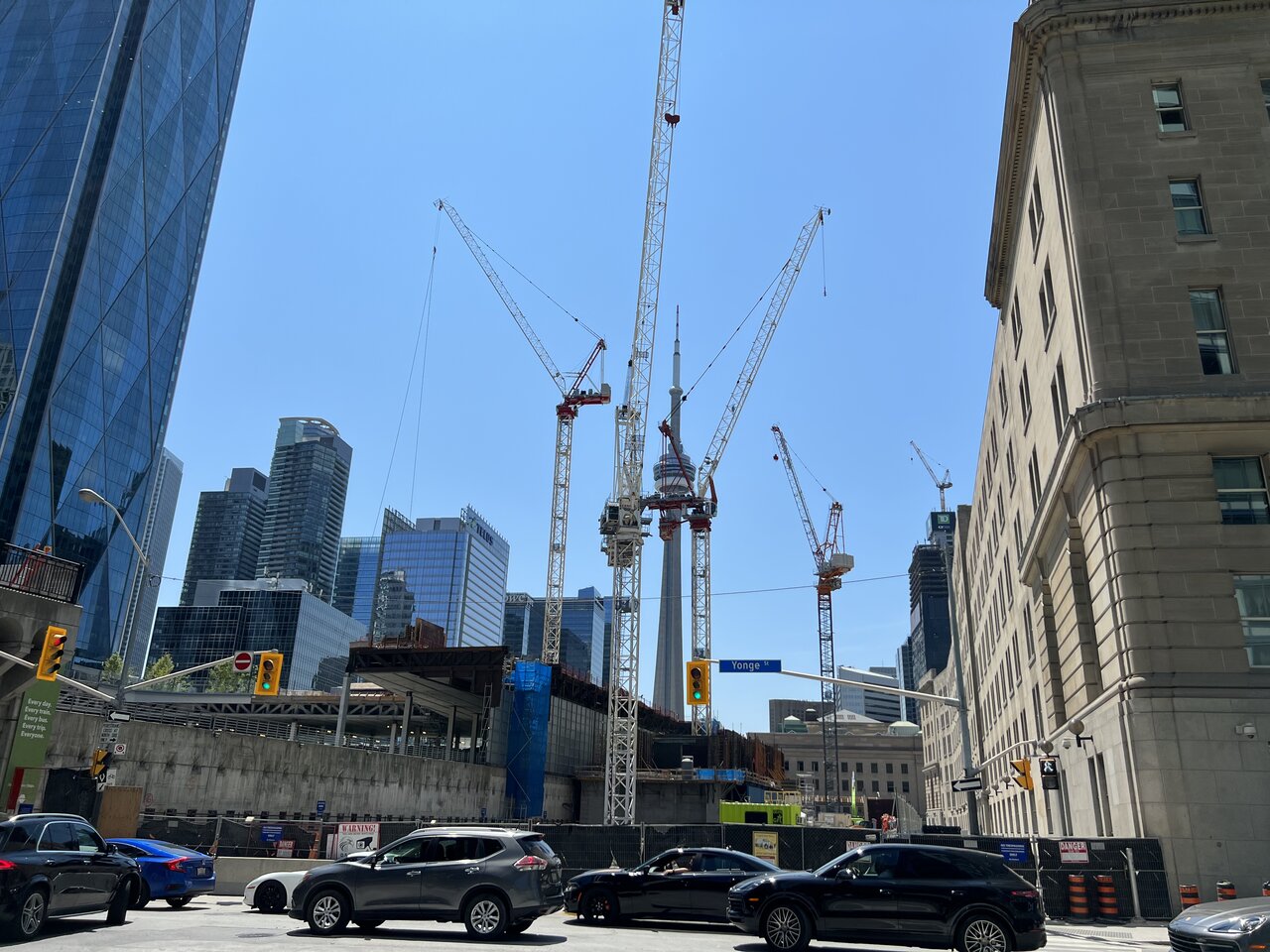

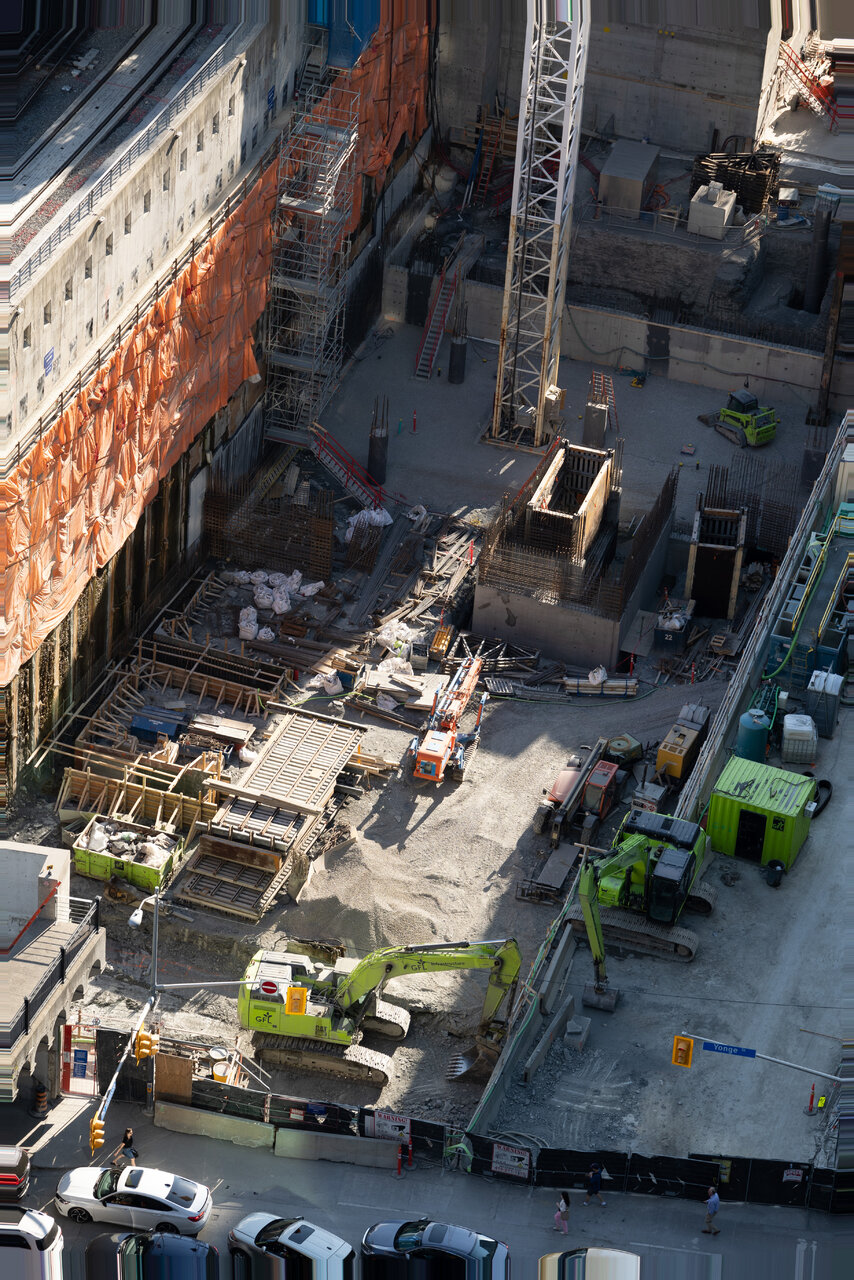

Pictures from July 14


















mburrrrr

Senior Member
Member Bio
Joined
Feb 10, 2010
Messages
1,047
Reaction score
14,105
Email exert from
CIBC SQUARE Construction Update

141 Bay Street

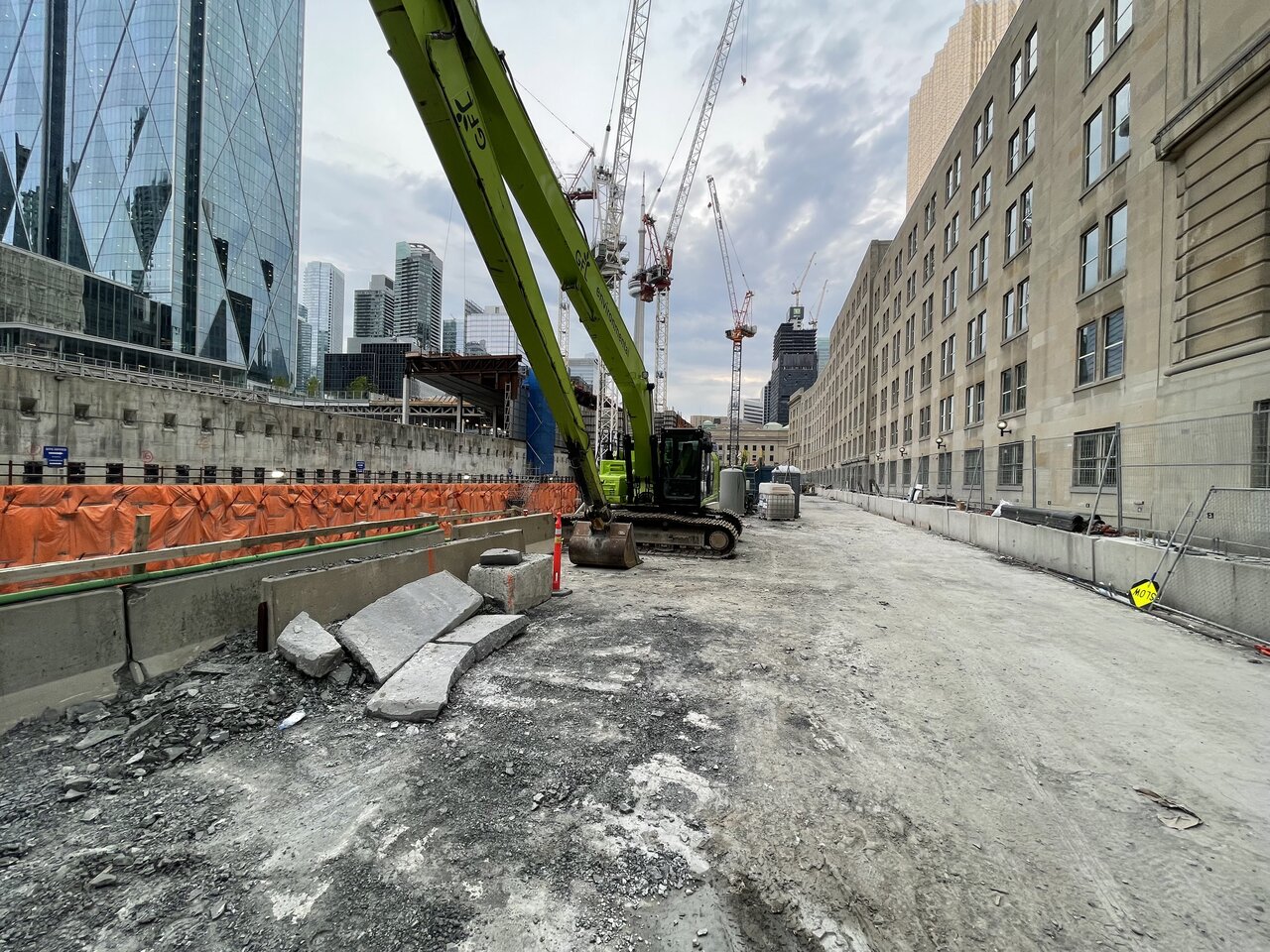

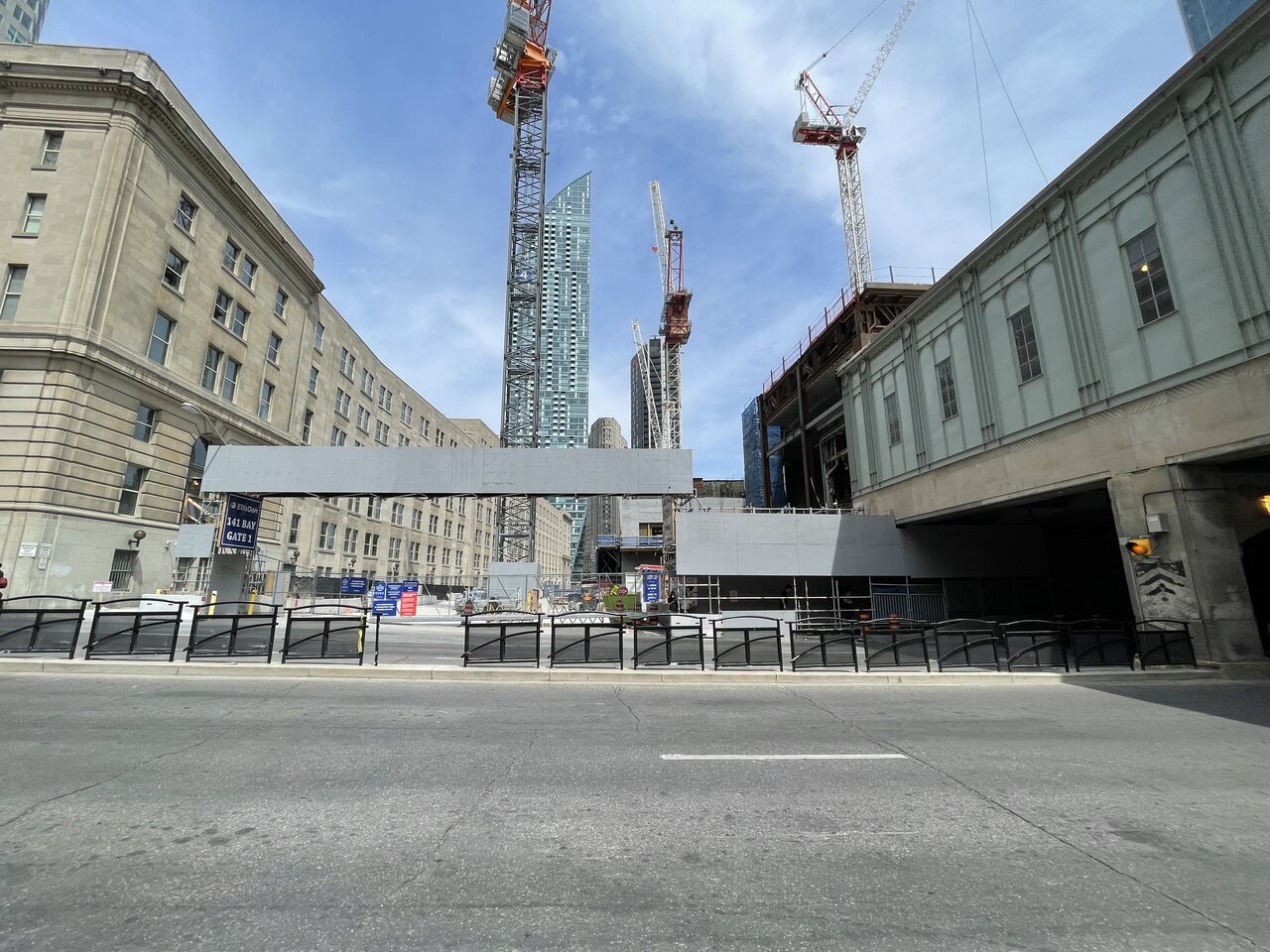

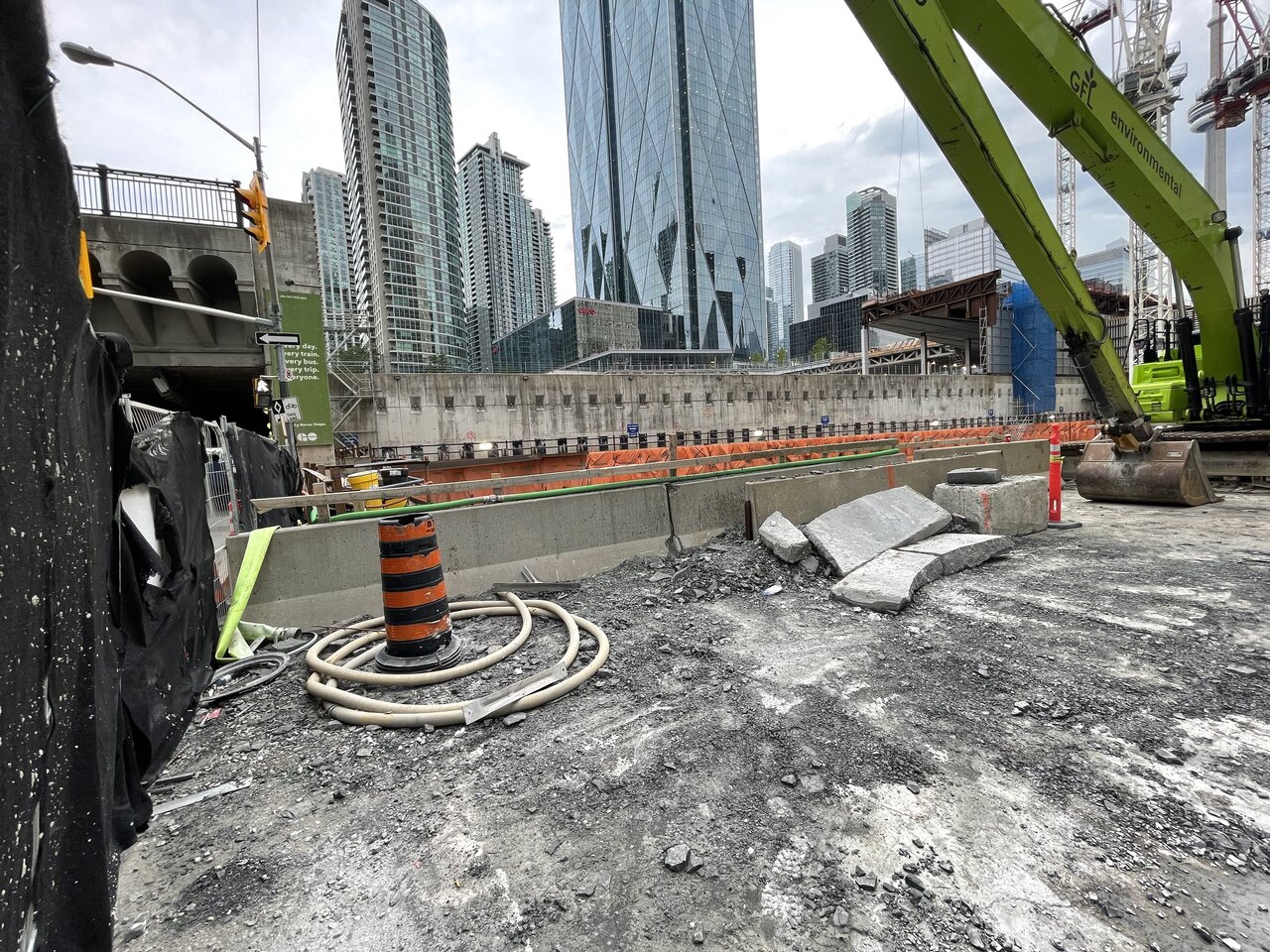

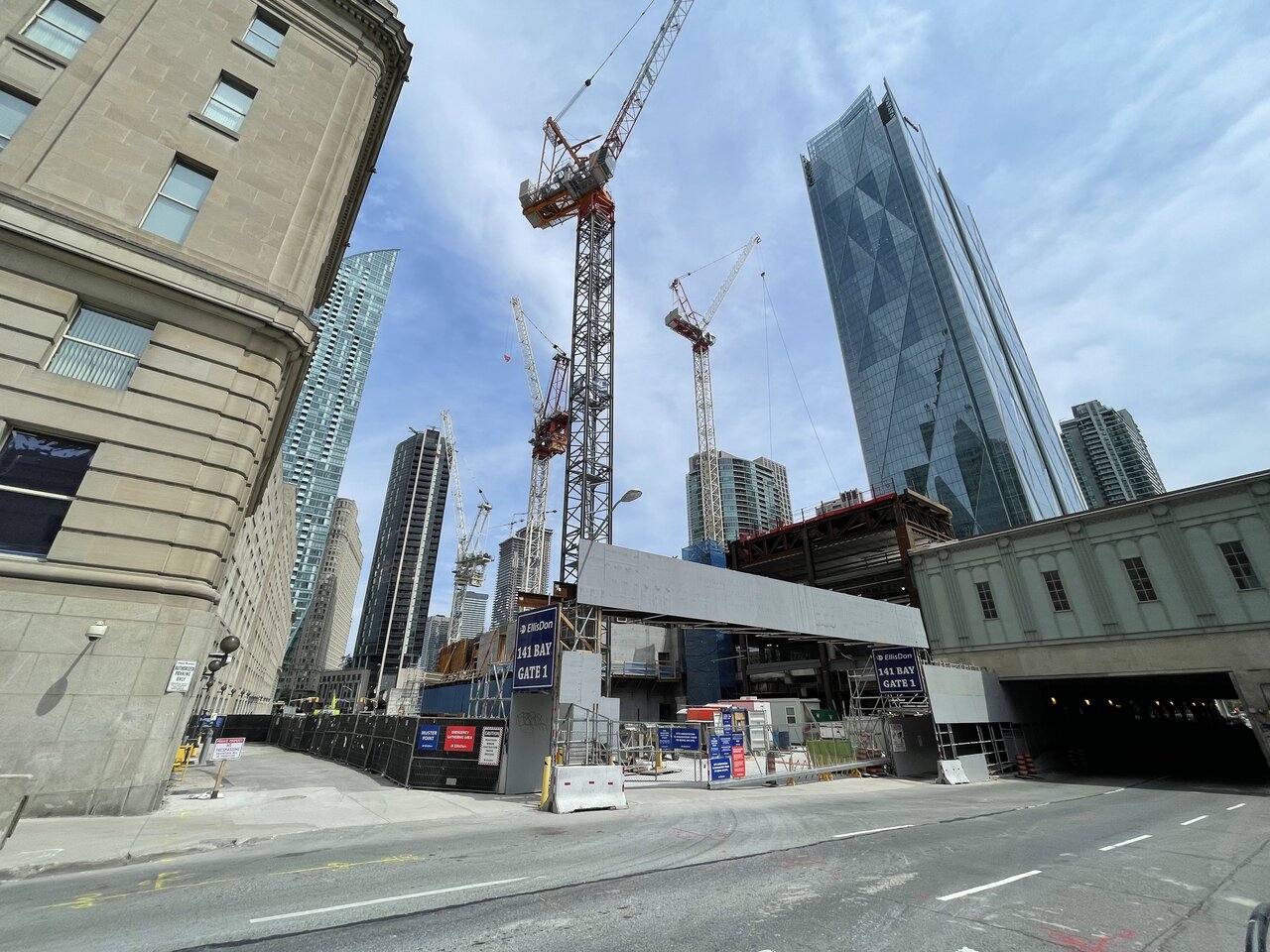

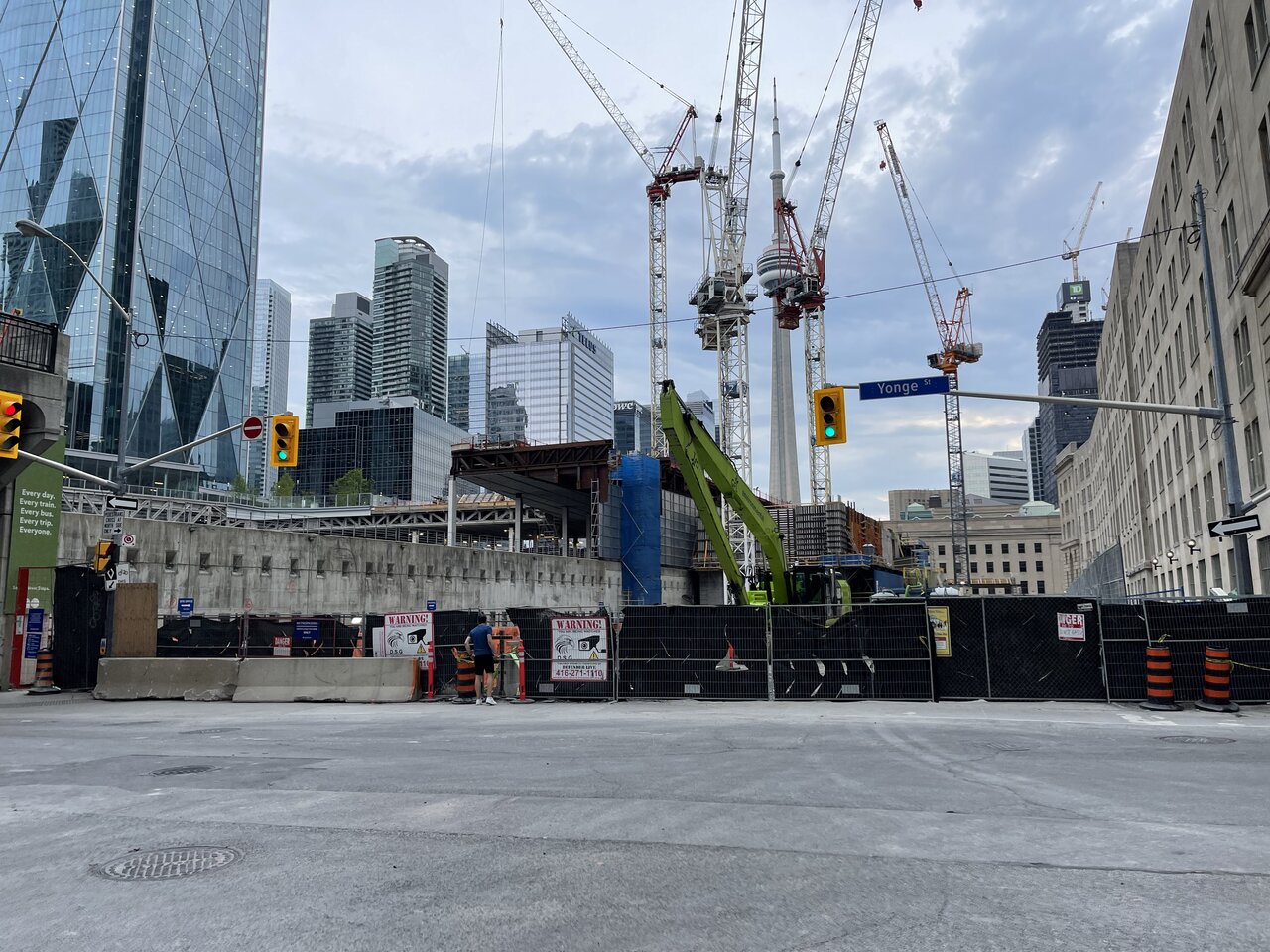

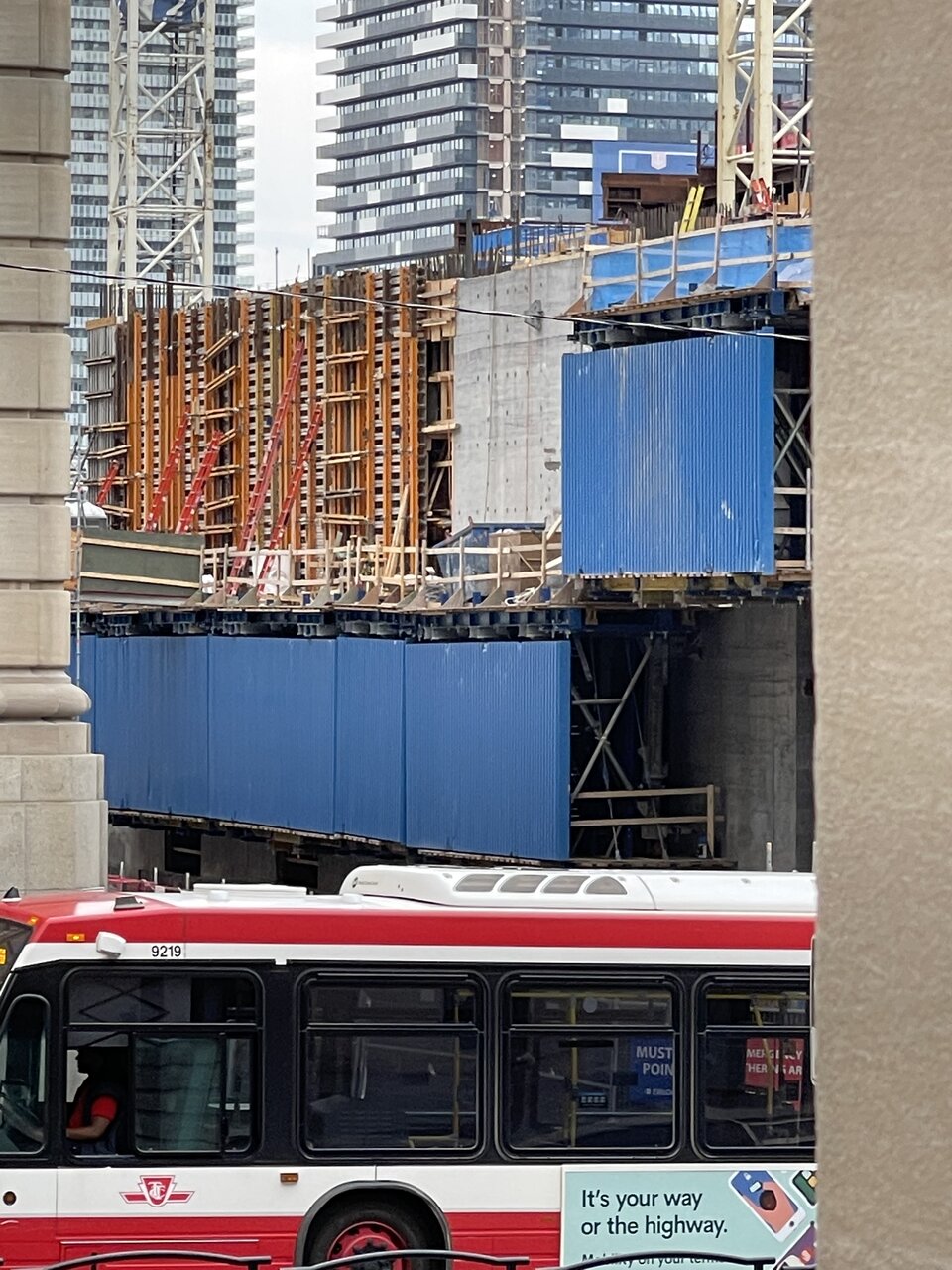

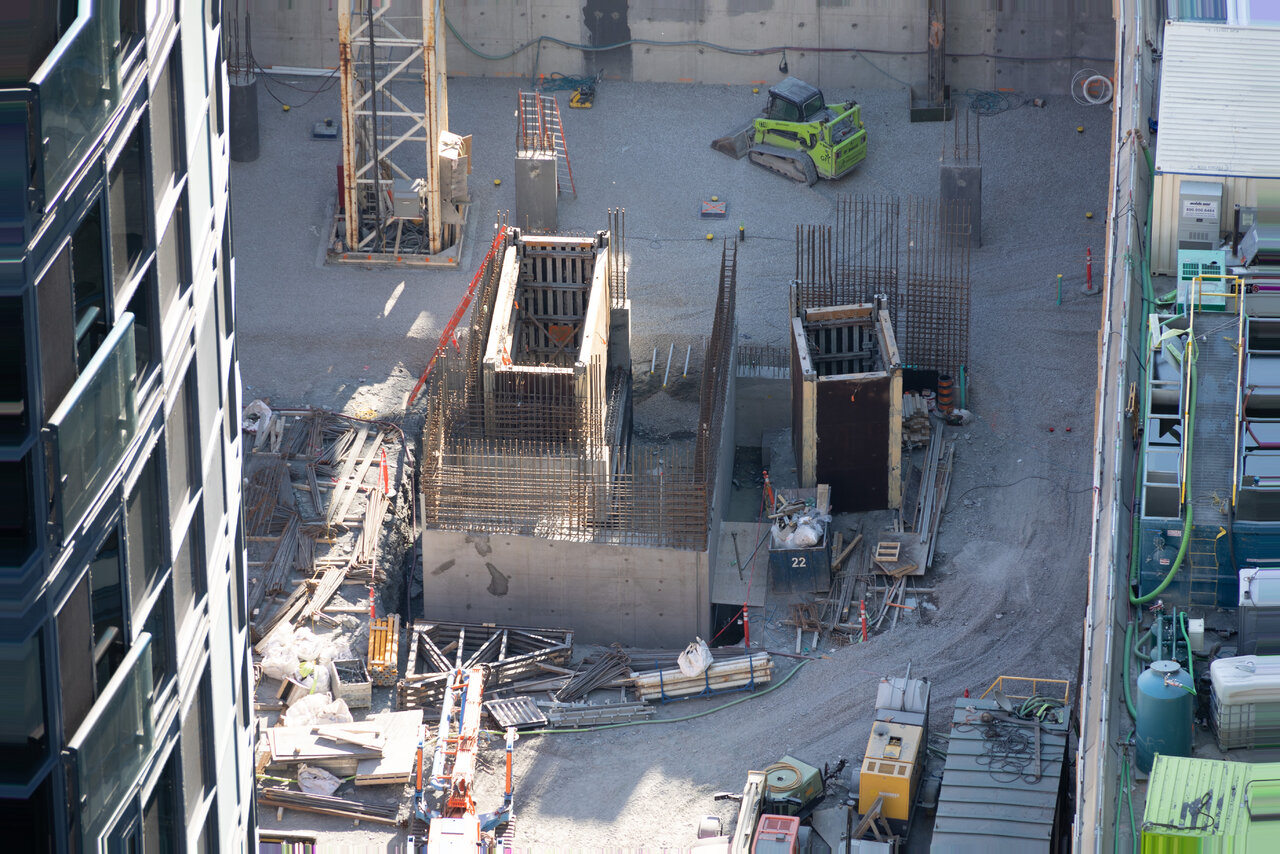

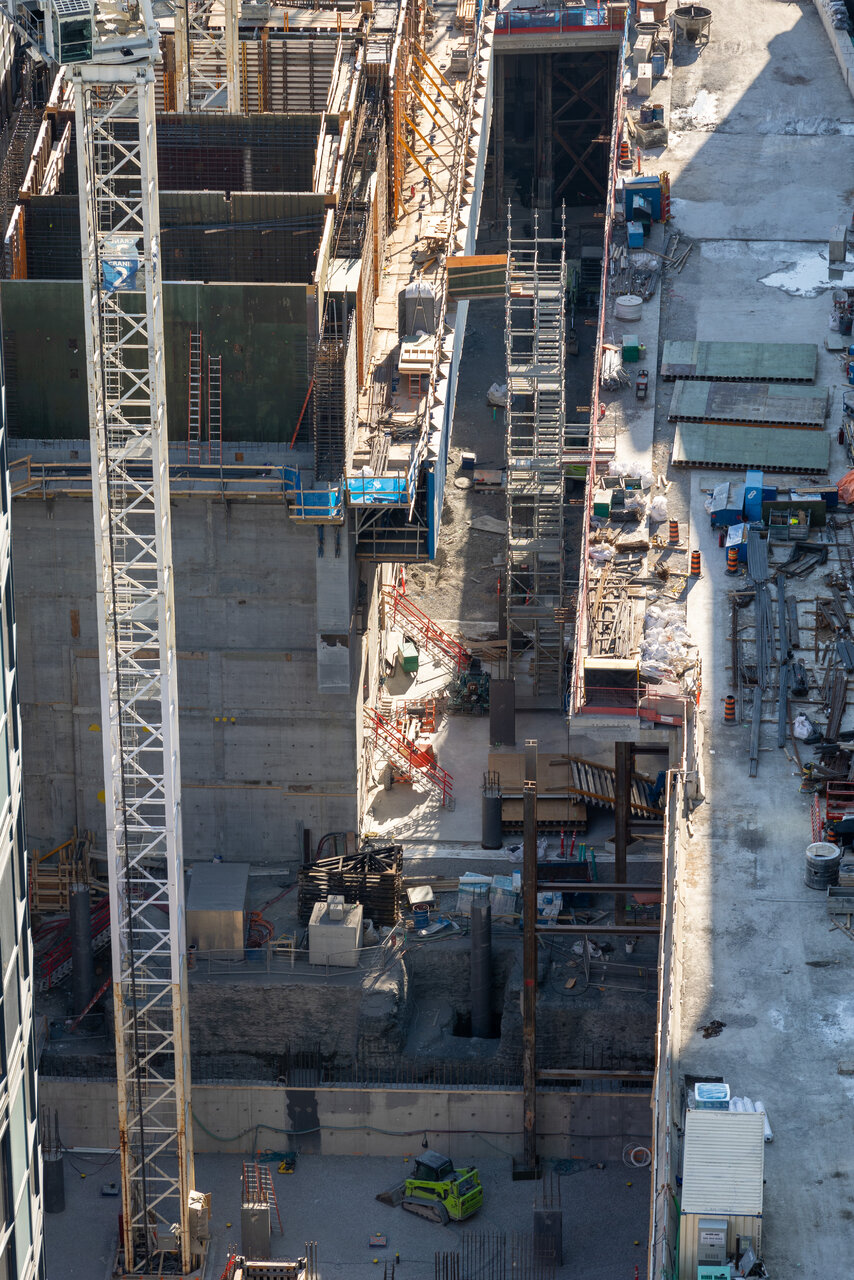

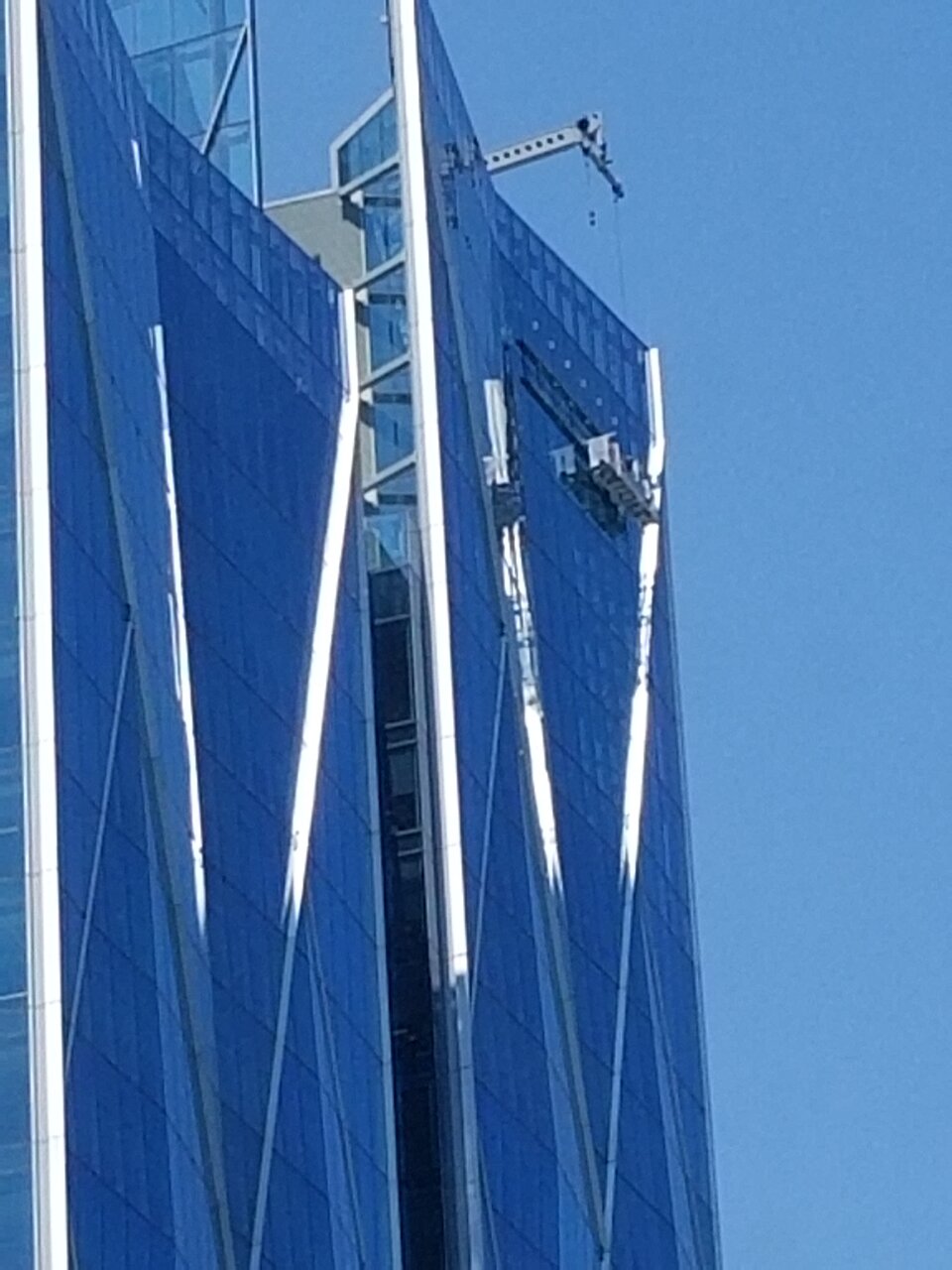

Construction at 141 Bay Street continues following the labour action disruptions in the month of May and the remobilization of forces in June. Excavation will be complete on the eastern half of the site for the end of July. Footings, columns, underground mechanical, and slab-on-grade work are progressing across the P3 and P5 areas of the project. Preparation for the foundation of the final tower crane near Yonge Street will be commencing with erection targeted for the end of the summer. The forming of the Tower core walls has progressed to Level 3. The next step in the superstructure is the placement of twelve large, structural steel nodes atop the Level 3 core wall starting at the end of July.

On the east side of the site, the overburden from the existing viaduct has been removed. The reinforcement of the existing viaduct is underway within the centre median of Yonge Street under the railway overpass. This work continues during extended daytime hours with partial lane closures and is targeted for completion in mid-August.

On the west side of the site, enabling works for the foundation of the bridge between 141 Bay and Union Station are targeted to start in August.

Overbuild Park

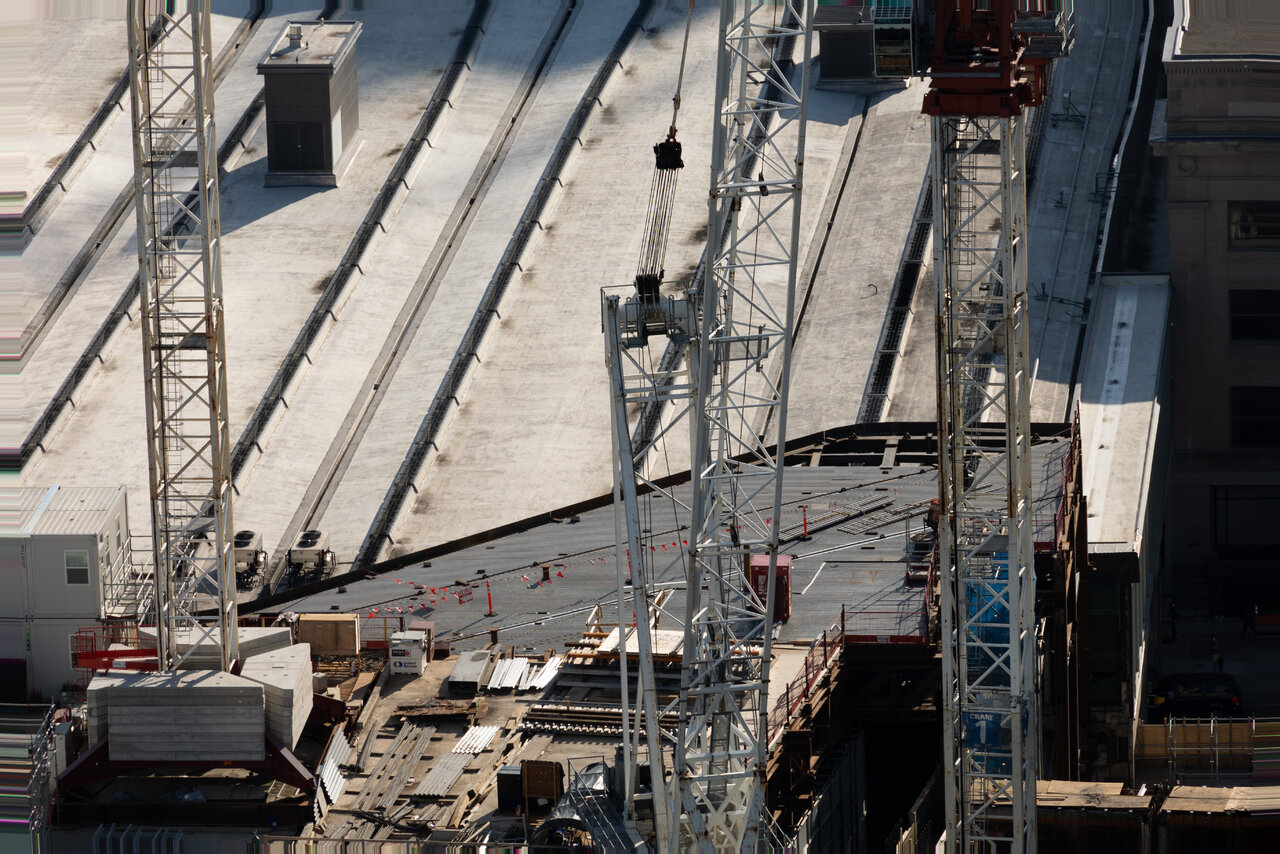

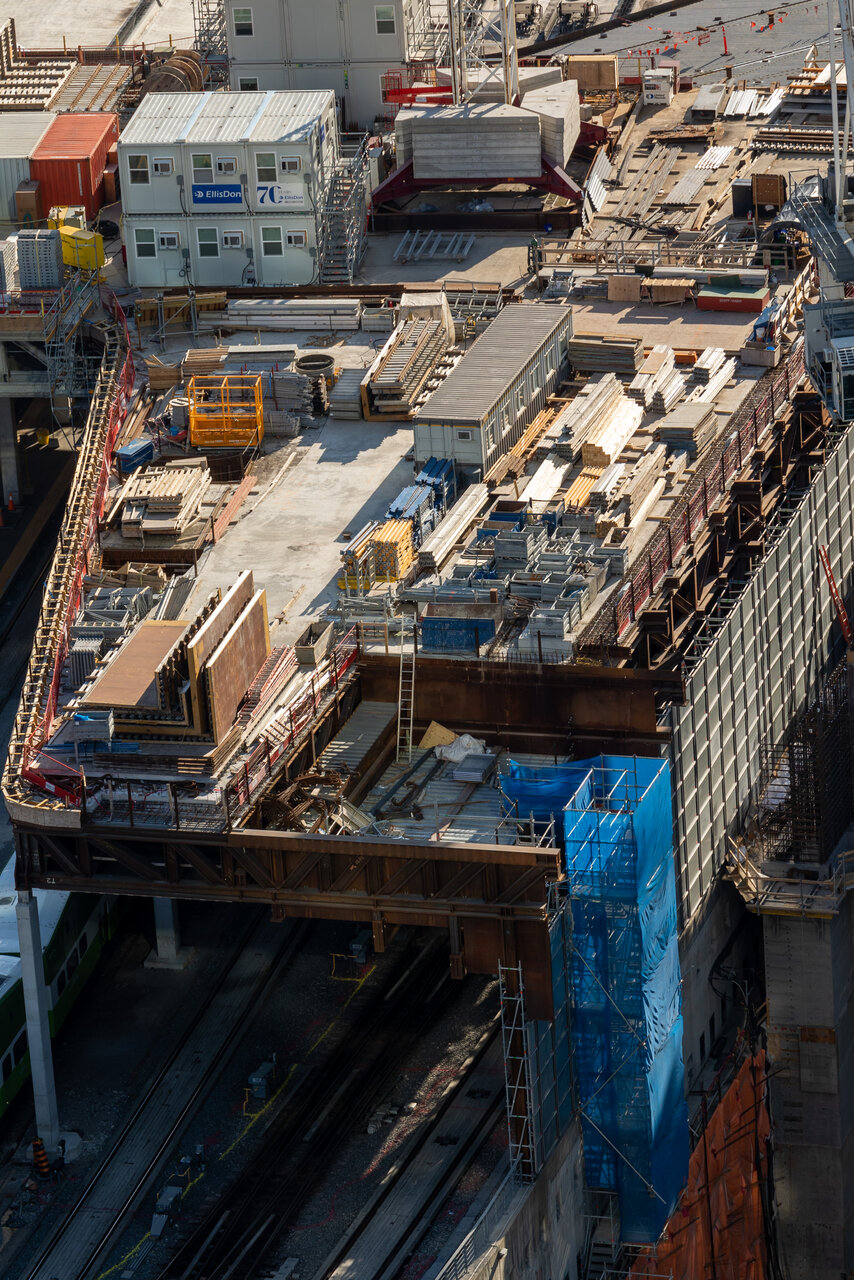

Crews have finished installation of structural steel & steel deck for the current phase of the Overbuild Park. The concrete topping work is being scheduled. To ensure safety, this work will take place overnight as it requires access to the active Metrolinx rail corridor – no construction personnel are permitted to work in the rail corridor when trains are in operation.


condovo

Senior Member
Member Bio
Joined
Dec 2, 2007
Messages
3,659
Reaction score
6,351
The logo and word mark are way too small for me. I can barely read it even from a couple of blocks away. Same for Two Bloor West. I don't have this issue with any other corporate logo on the skyline.


bmw007

New Member
Member Bio
Joined
May 2, 2010
Messages
29
Reaction score
23
Email exert from
CIBC SQUARE Construction Update

141 Bay Street

Construction at 141 Bay Street continues following the labour action disruptions in the month of May and the remobilization of forces in June. Excavation will be complete on the eastern half of the site for the end of July. Footings, columns, underground mechanical, and slab-on-grade work are progressing across the P3 and P5 areas of the project. Preparation for the foundation of the final tower crane near Yonge Street will be commencing with erection targeted for the end of the summer. The forming of the Tower core walls has progressed to Level 3. The next step in the superstructure is the placement of twelve large, structural steel nodes atop the Level 3 core wall starting at the end of July.

On the east side of the site, the overburden from the existing viaduct has been removed. The reinforcement of the existing viaduct is underway within the centre median of Yonge Street under the railway overpass. This work continues during extended daytime hours with partial lane closures and is targeted for completion in mid-August.

On the west side of the site, enabling works for the foundation of the bridge between 141 Bay and Union Station are targeted to start in August.

Overbuild Park

Crews have finished installation of structural steel & steel deck for the current phase of the Overbuild Park. The concrete topping work is being scheduled. To ensure safety, this work will take place overnight as it requires access to the active Metrolinx rail corridor – no construction personnel are permitted to work in the rail corridor when trains are in operation.

Thanks for keeping us abreast of the construction progress. Given the large footprint of the site, how long does it take to complete each level (2-3 months for the underground level and a month for each floor in the main tower) ? Curious to see how the ramp is taking shape to the parking garage on the east side.


Top
