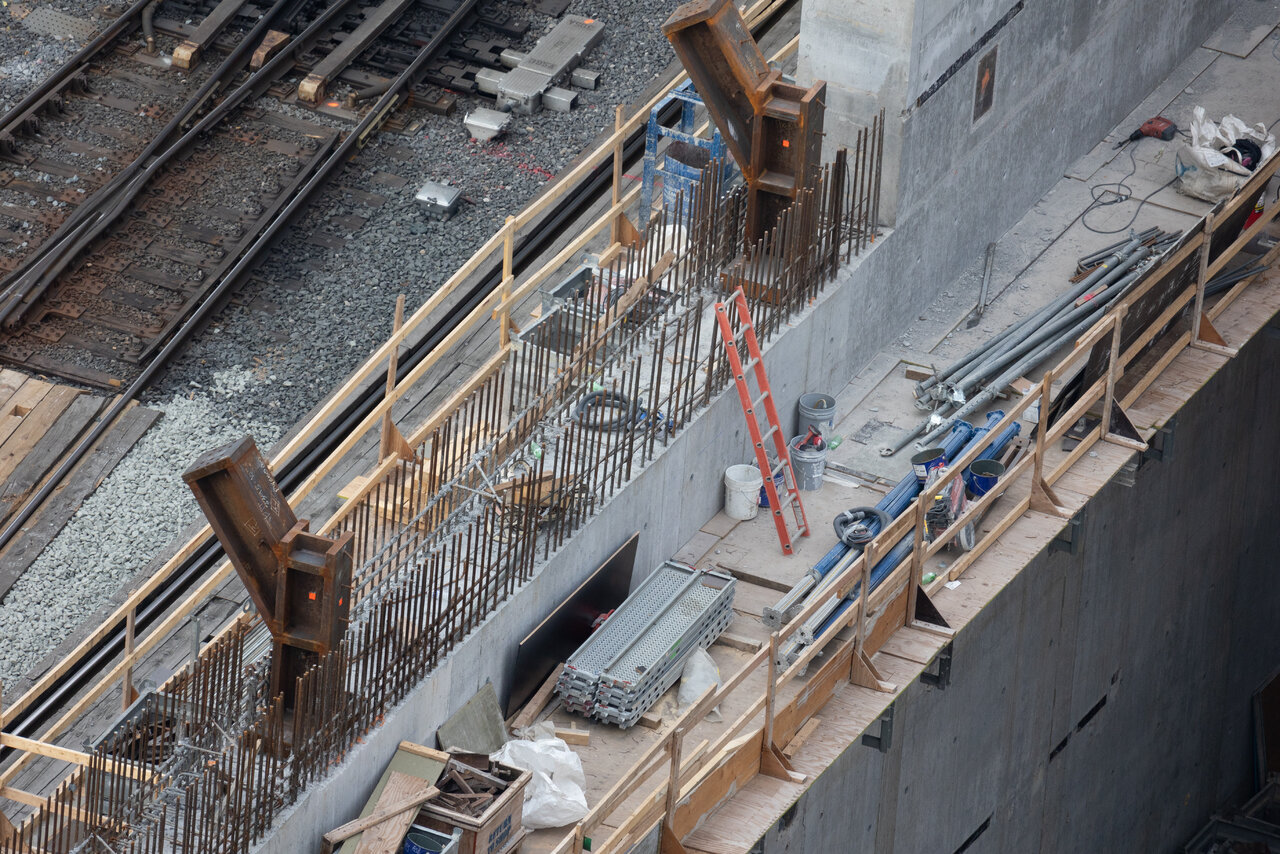

There were 3 jumps in the core sometime around Nov 4, 14, 22.

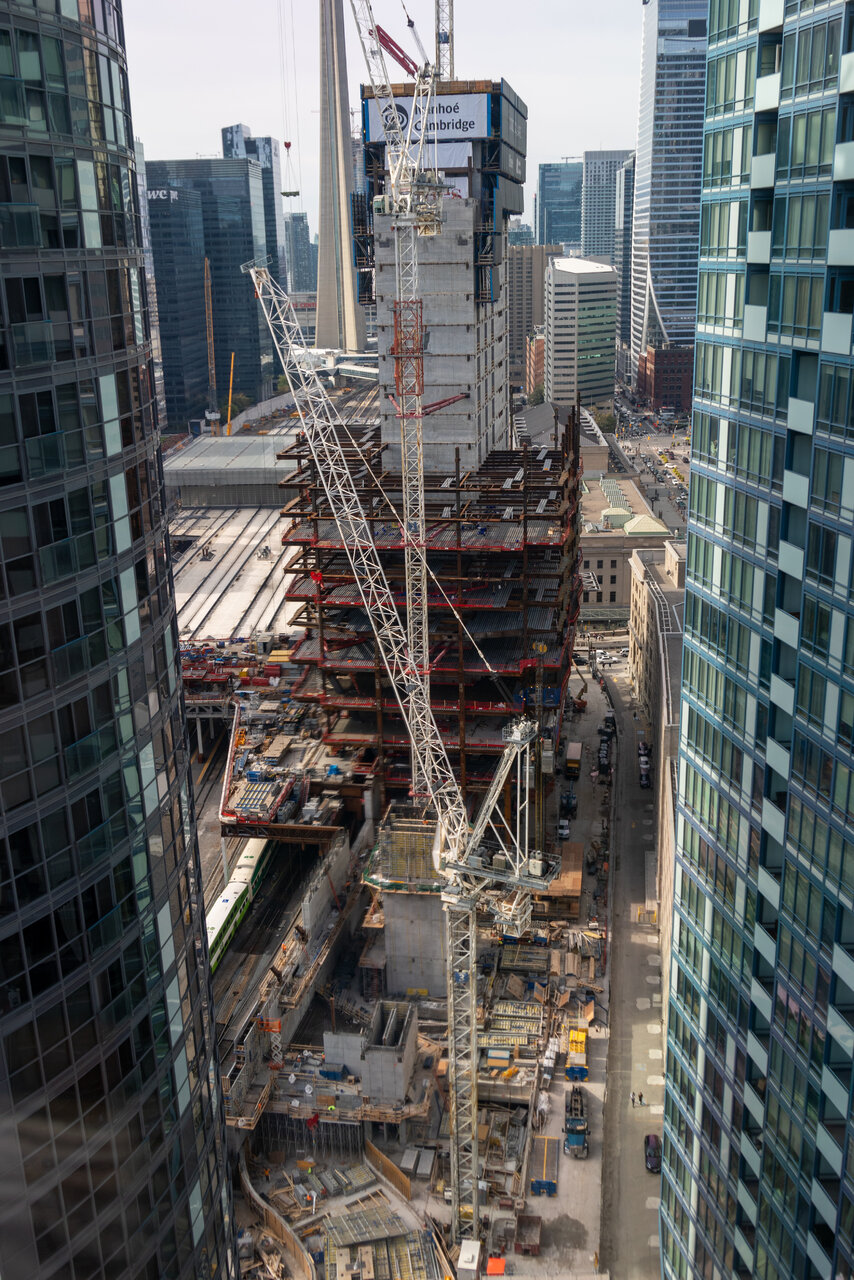

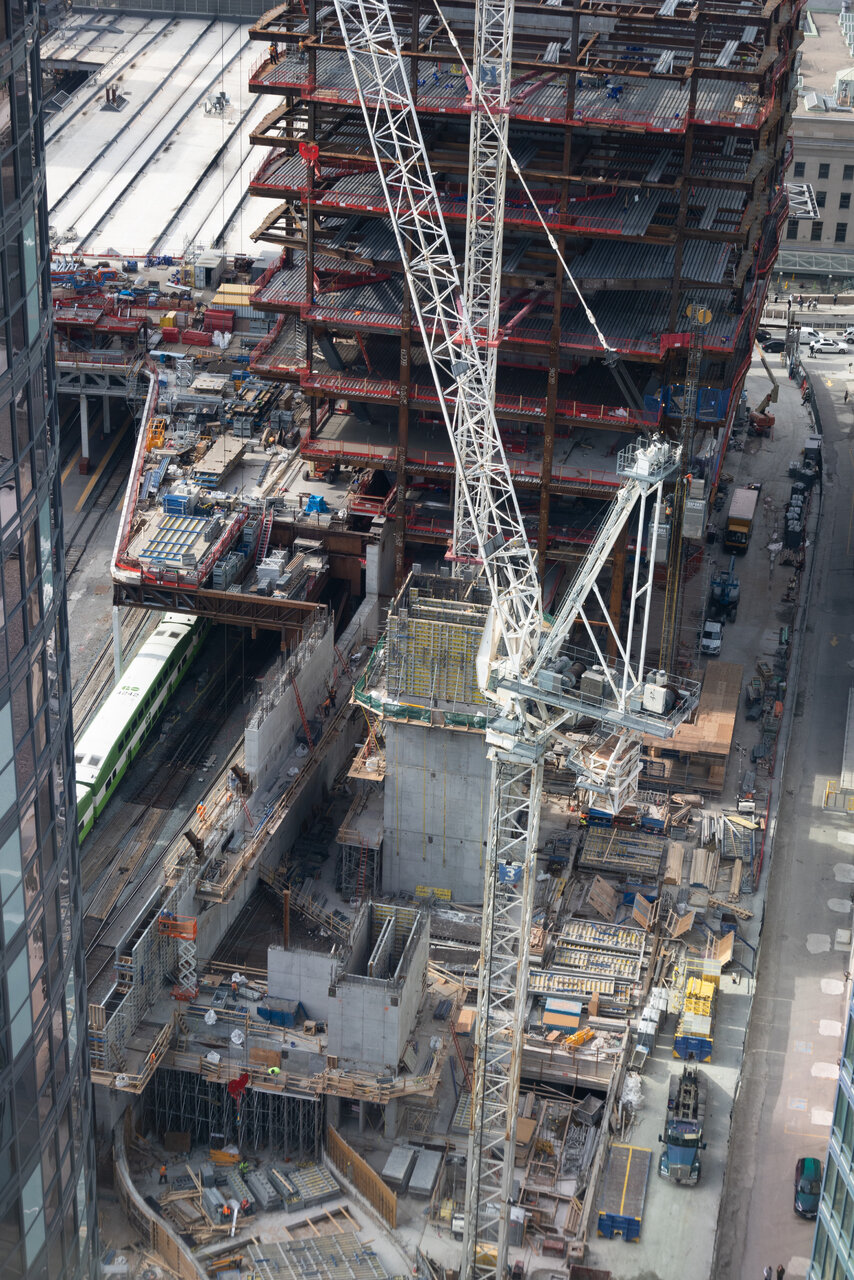

This phase looks to be about 12 months behind.

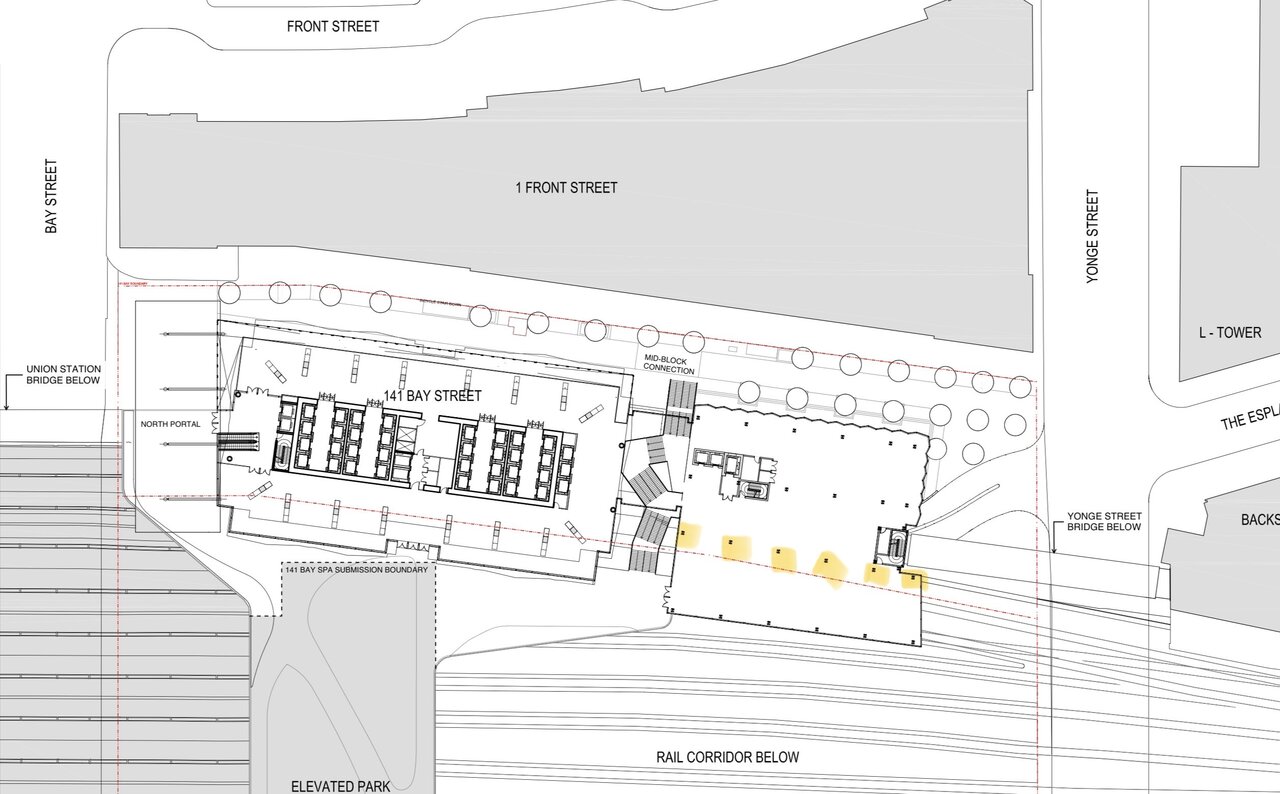

81 Bay 2017-05-21 to 2019-04-05 ~ 23 months

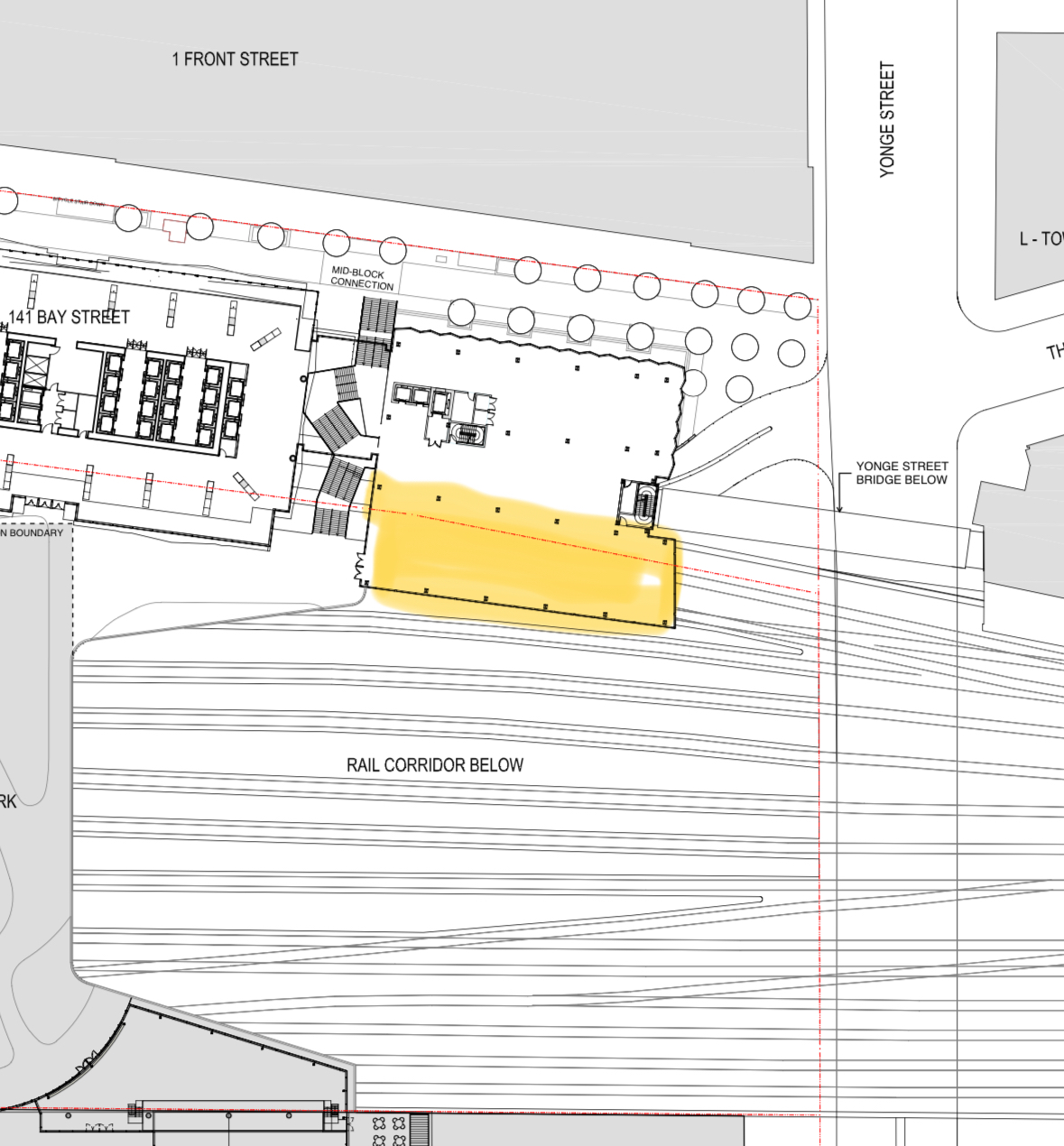

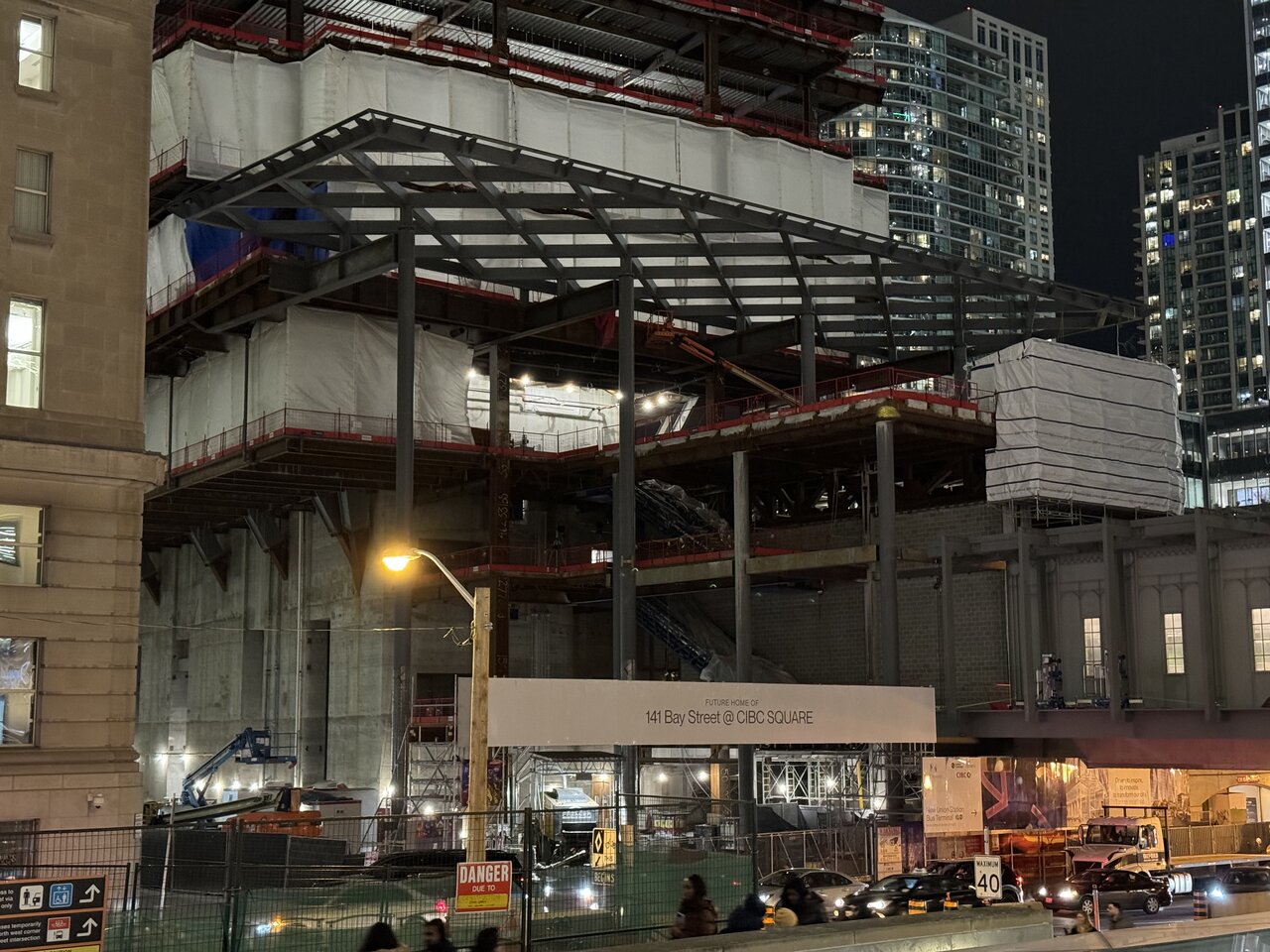

141 Bay 2020-12-01 to 2023-11-20 ~ 35 months
The glass was ~ 6 weeks after this.

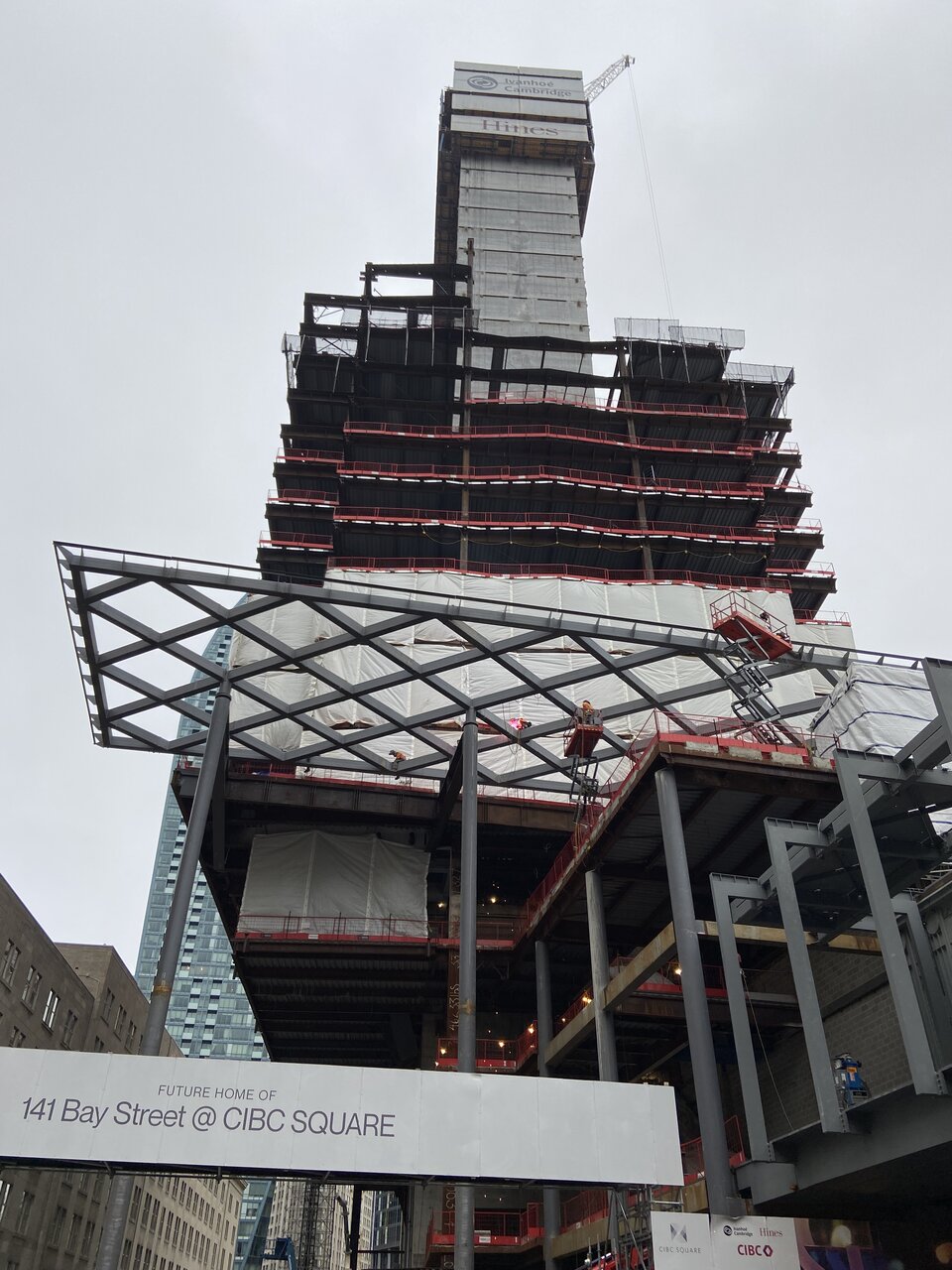

April 2019

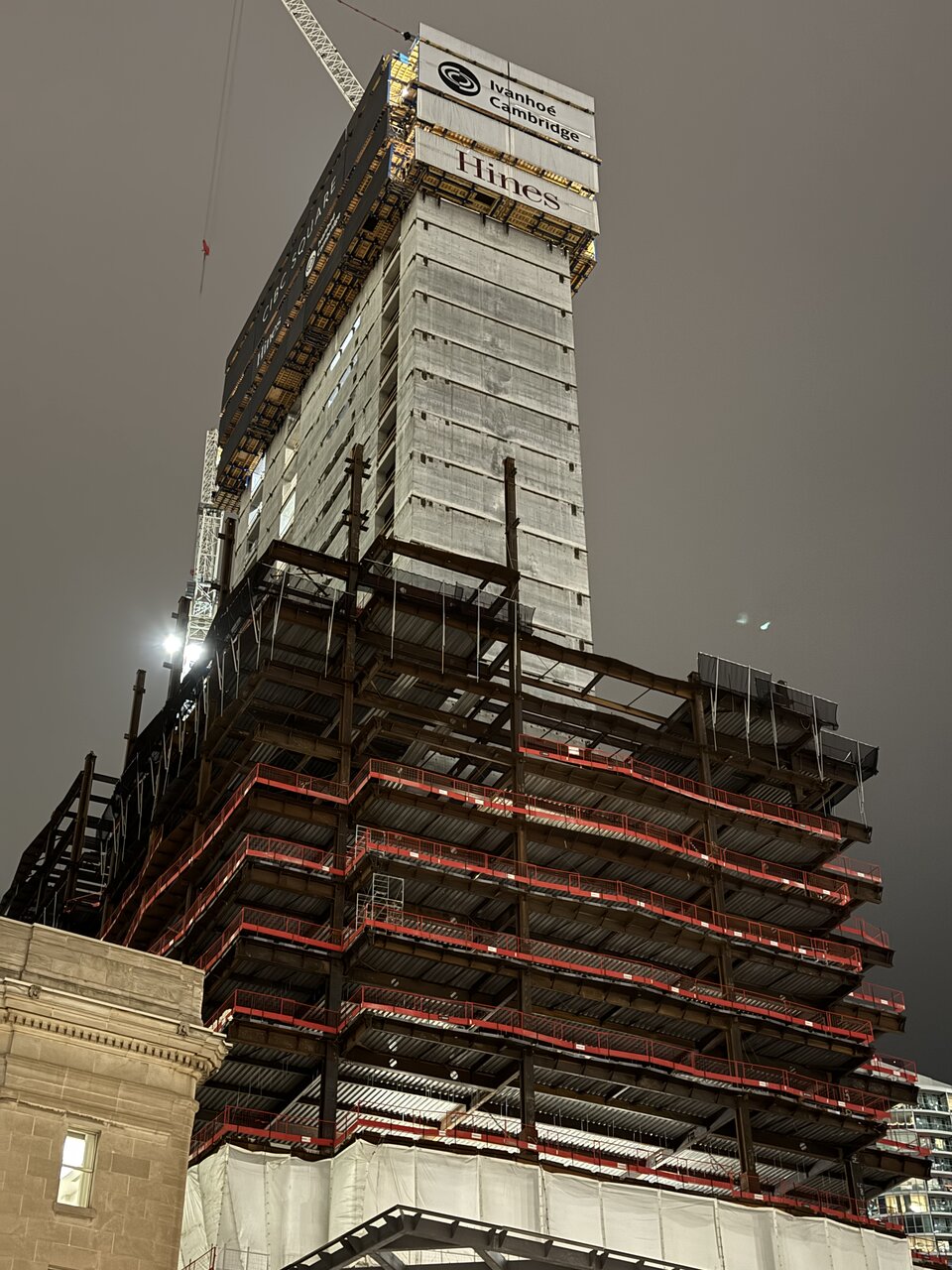

Core jump this morning. 7 days.
