Barrie Line double tracking update from Sunday 14 May 2017, riding northbound from YorkU to Rutherford.
Great pics and video, thank you!
Do you think they'd do a 75 minute schedule, or short turn-every-other-train? (60 min Aurora, 120min Newmarket)
At least till the extra siding gets built.
I was thinking 60 minute Aurora service would come first, but there has been a fair amount of outcry from Newmarket residents about the current arrangement. Extending the 75 minute trains up to Newmarket GO might be a worthwhile olive branch. We'll see.Since last month (during which time there have been 2 weekend closures), they've completed the second track through Rivermede Road and installed the switch just south of Rutherford station. There may have also been some work further south, but I don't know because last month's video conked out south of Rivermede.
At Maple Station, there's little indication of the pedestrian tunnel work - just two suspiciously fresh segments of platform and some weird pillars sticking up beside the tracks.
Looking north at the south end of the station:
Looking north from the station building, a second similar site:
Looking south from the station building, you can clearly see where the second track will go.
With the current/under-construction track layout you can have 60-minute service to Aurora (using the YorkU-Rutherford siding), or 75-minute service to Newmarket (using the Maple-King City siding). To get service every 60 minutes to Newmarket you'd need another siding exactly 30 minutes north of York University station. Definitely a worthwhile investment, but not going to happen within a year.
I know this is kind of old, but I wonder what it would take to get 60 min service to Barrie on the weekdays until 12:30am? Another siding? or double track?I tried my hand at some conceptual schedules showing the various scenarios.

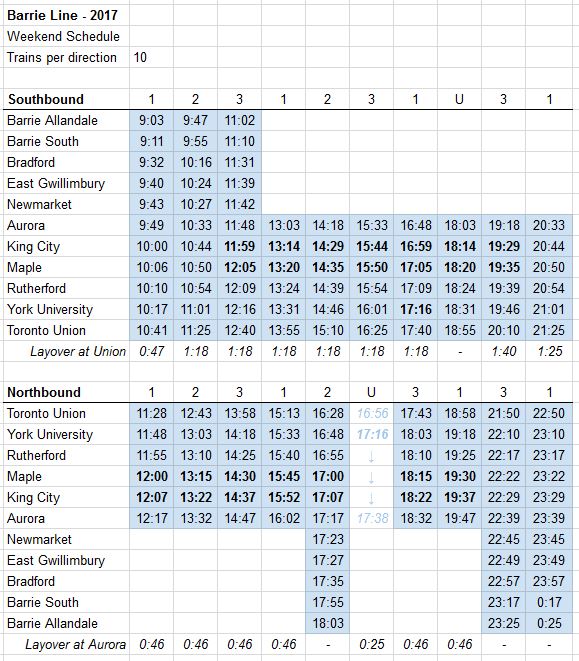

First, the current schedule. The 16:56 northbound is a deadhead that meets the 16:48 southbound train at the York University siding. It can't be in service because there's no platform on that track.
On top of each run, I've indicated my best guess for the trainset that might be operating it. Numbered trainsets originate from Barrie yard, while "U" trainsets originate downtown. Trainsets 1 and 3 are 6-car sets, while trainsets 2 and U are 10-car sets.
View attachment 109479

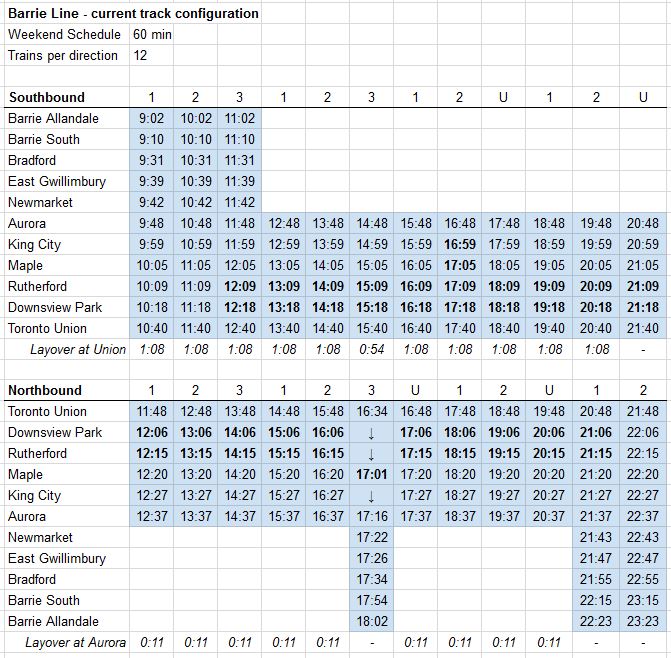

Next, the 60-minute Aurora schedule. As far as we can tell, the current plan is to move to something like this within a year.
With service moved from York U to Downsview Park, I took the liberty of switching the current deadhead to an in-service run to Aurora, which allows the Barrie-bound train to operate express, providing a very respectable 1:28 travel time from Union to Barrie Allandale - a 77 km/h average speeed.
View attachment 109480

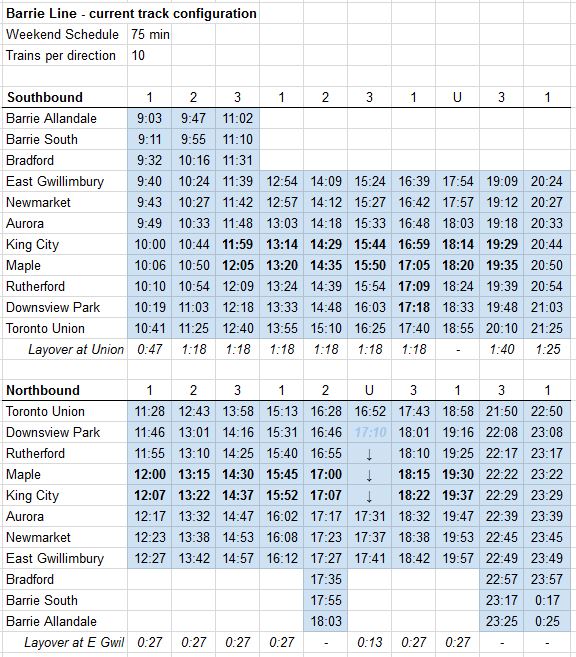

The alternative to that would be a 75-minute schedule to Newmarket, which is basically identical to the schedule currently in use, except that trains continue north to East Gwilimbury rather than sitting around in Aurora for 46 minutes. Again I've switched the northbound deadhead to an in-service express, but this time it has to be the Aurora trip based on the siding locations.
View attachment 109481
I tried to do a 60/120 turnback schedule, but I couldn't get it to work out. It doesn't seem practical to get the trains evenly spaced in both directions south of Aurora.

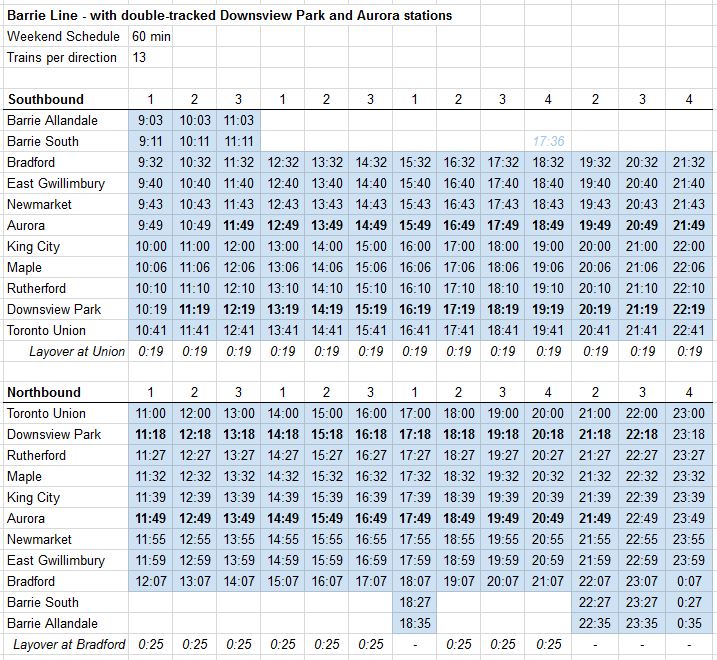

Finally, once we get double track at Aurora and Downsview Park stations, we could run an hourly service to Bradford. I've shown Trainset 1 heading back to Barrie in the afternoon, with the corresponding southbound trip being handled by Trainset 4 which deadheads from the yard to the siding at Bradford before the northbound trip gets there.
View attachment 109482
Interestingly, all four of these schedules have the same equipment requirement: four trainsets (and the last one could equally be run with three sets by not sending Trainset 1 back to the yard in the afternoon). Based on that, my guess is that their operating costs would only be slightly higher than today, while their potential ridership is far greater.
