Tim MacDonald
Senior Member
May 8th
|
|
|
The earliest would be late July to Early Sept, but more like in Aug depending on Mississauga Rd bridge area.thanks for that. Makes me wonder when traffic will shift to the new bridge, doesn't look like long now.

my understanding is that both directions will be shifted to the new bridge for a year or two while they complete the rehabilitation of the existing bridge.Drove past the bridge this morning for the first time in quite some time. From my low vantage point it appears that the new span is ready and being readied for use - or about 50% of it. All construction on the east side bridge approaches has completed apparently, there were no crews in evidence. There was no activity on the bridge itself. Temporary crash barriers and temporary orange road markings appear to be in place. They appear ready to take the next step in diverting westbound traffic onto the new bridge and them move into the first phase of the rehabilitation of the older bridge.

The west side of the bridge, centered around Mississauga Road, both in the diversion areas between the east and west bound traffic, and the areas south of the east bound traffic were a hive of activity. Paving, other concrete work, sorting and removing fill etc.

To the east side of the bridge, in the center diversion area, where I believe they are rehabilitating or replacing a large drainage culvert, that work also appears to be in its final stages. This may line up then with a major revamp pf the traffic flows both east and west bound through this area soon.
Drum may have better information then this.

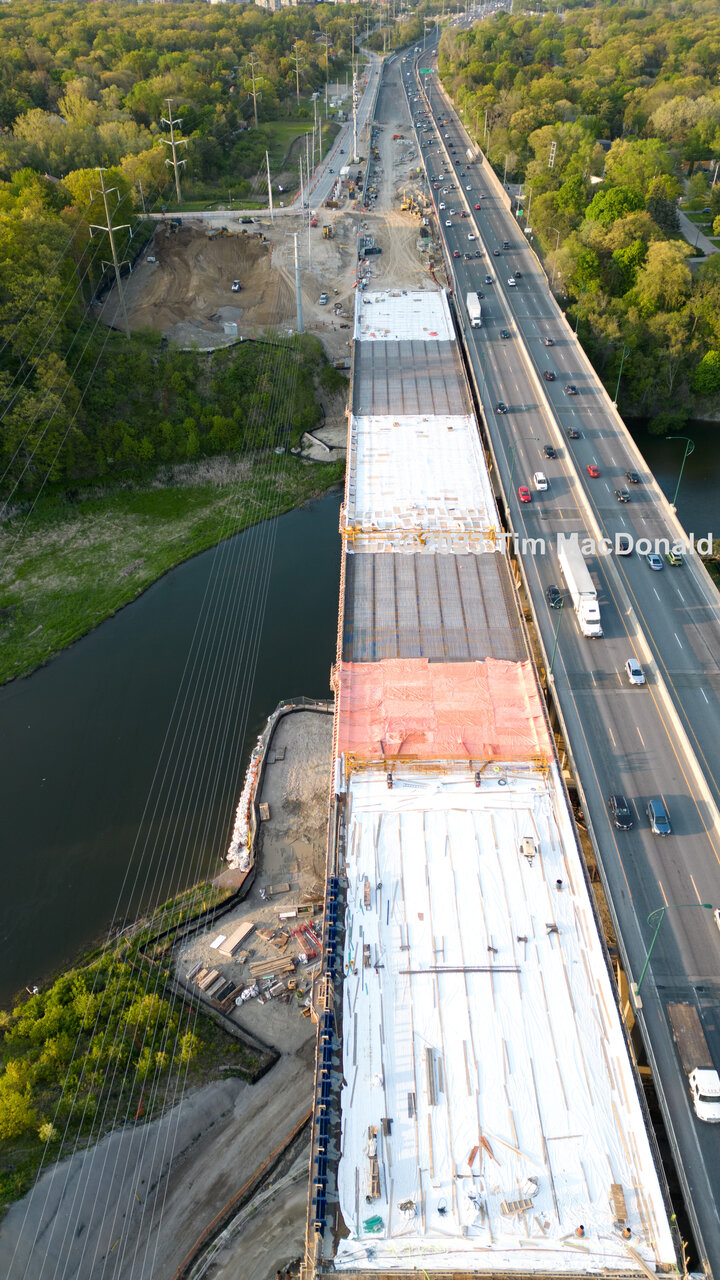

No info since I rarely drive the QEW.Drove past the bridge this morning for the first time in quite some time. From my low vantage point it appears that the new span is ready and being readied for use - or about 50% of it. All construction on the east side bridge approaches has completed apparently, there were no crews in evidence. There was no activity on the bridge itself. Temporary crash barriers and temporary orange road markings appear to be in place. They appear ready to take the next step in diverting westbound traffic onto the new bridge and them move into the first phase of the rehabilitation of the older bridge.
The west side of the bridge, centered around Mississauga Road, both in the diversion areas between the east and west bound traffic, and the areas south of the east bound traffic were a hive of activity. Paving, other concrete work, sorting and removing fill etc.
To the east side of the bridge, in the center diversion area, where I believe they are rehabilitating or replacing a large drainage culvert, that work also appears to be in its final stages. This may line up then with a major revamp pf the traffic flows both east and west bound through this area soon.
Drum may have better information then this.

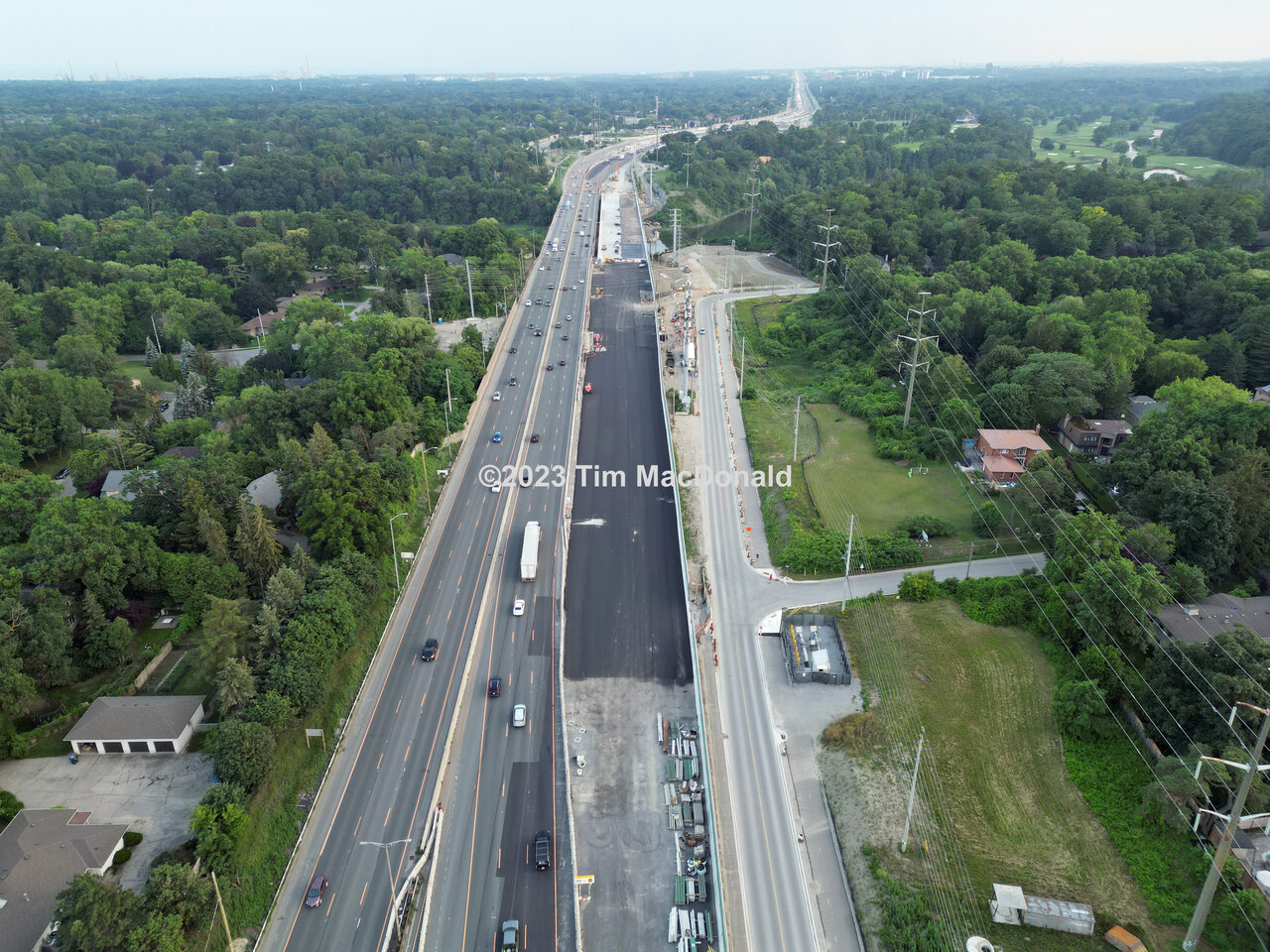

I can confirm, after a return trip, that the new bridge is set up for both eastbound and westbound traffic, with a crash barrier to separate the traffic flows, with temporary lines painted, including what will be a merge lane from Mississauga Road going eastbound. The activity on the west side approaches was easily the busiest I have seen with multiple crews at work paving etc. The timeline must be fairly quick to change the traffic flows.No info since I rarely drive the QEW.
What I can see from @tims photos, the westbound is ready to open after some paving at Mississauga Rd with the eastbound opening a week later. I expect, MTO will want all lanes open at the same time.
Could happen this weekend with a lot of 'what' taking place Monday Morning for the new route.I can confirm, after a return trip, that the new bridge is set up for both eastbound and westbound traffic, with a crash barrier to separate the traffic flows, with temporary lines painted, including what will be a merge lane from Mississauga Road going eastbound. The activity on the west side approaches was easily the busiest I have seen with multiple crews at work paving etc. The timeline must be fairly quick to change the traffic flows.

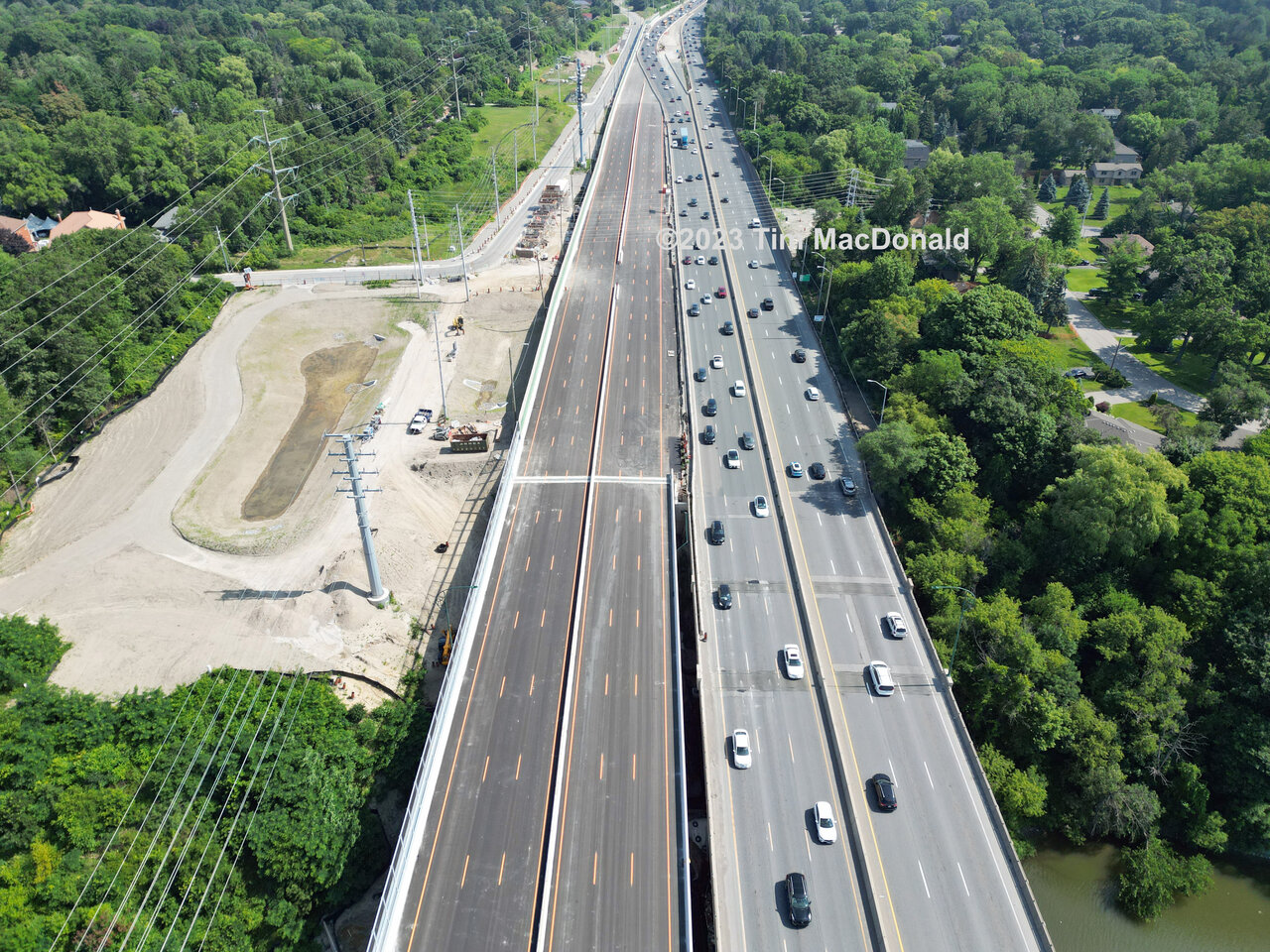

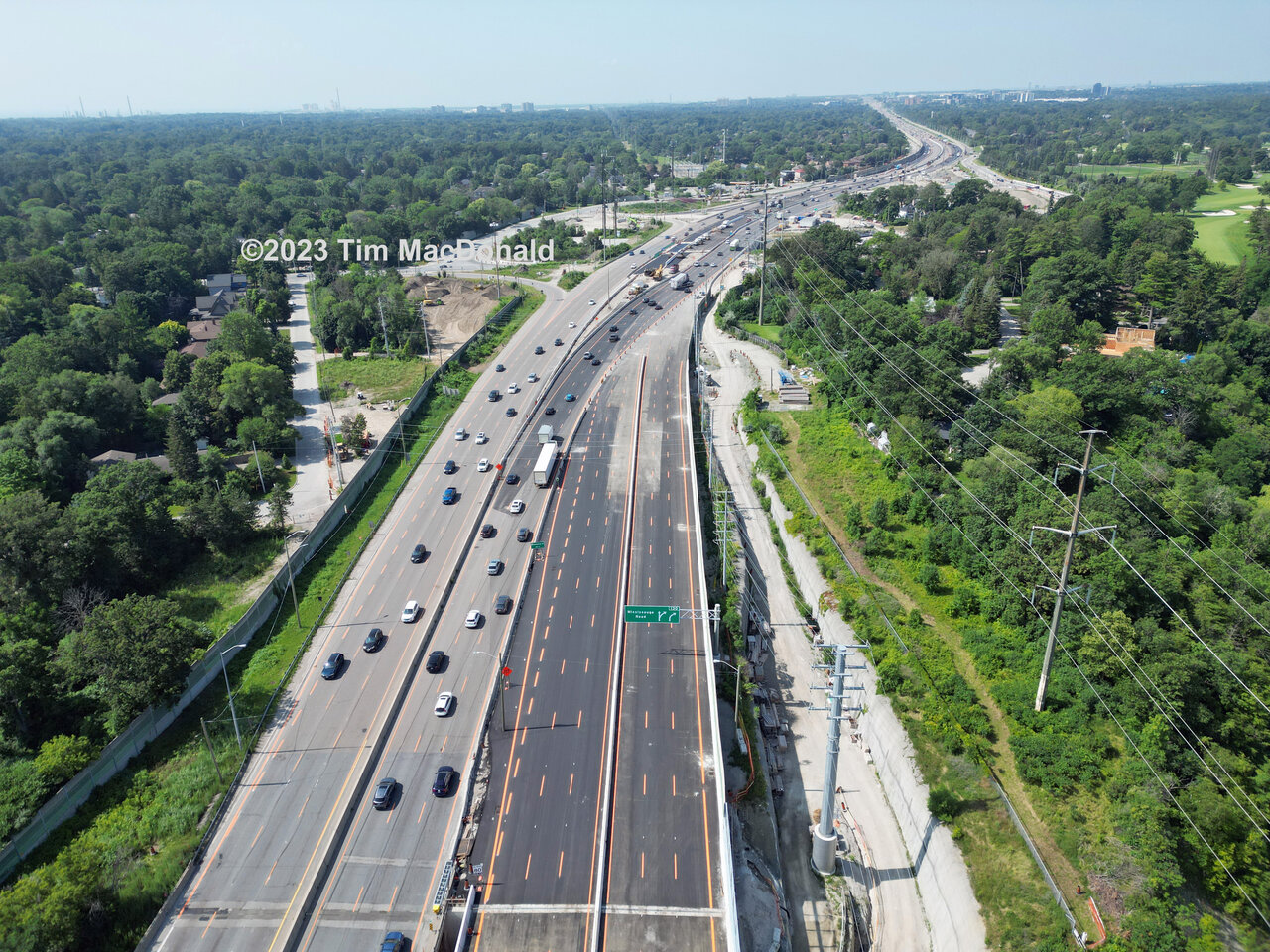

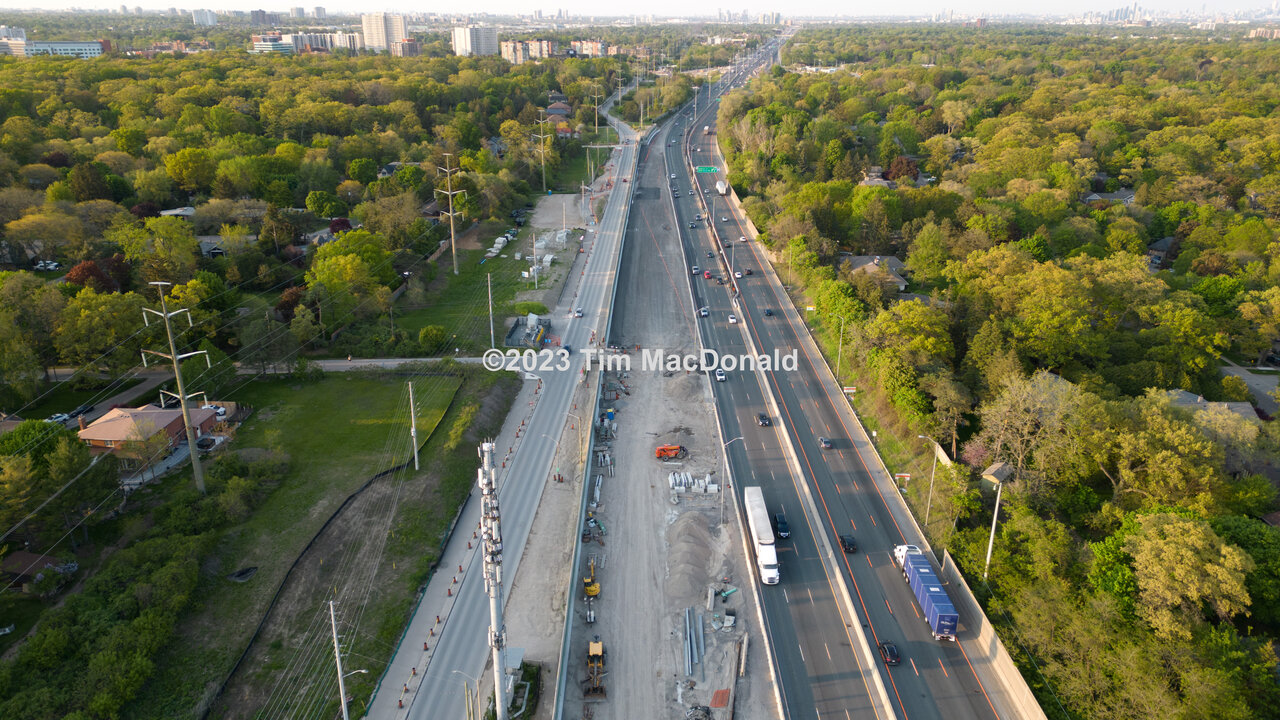

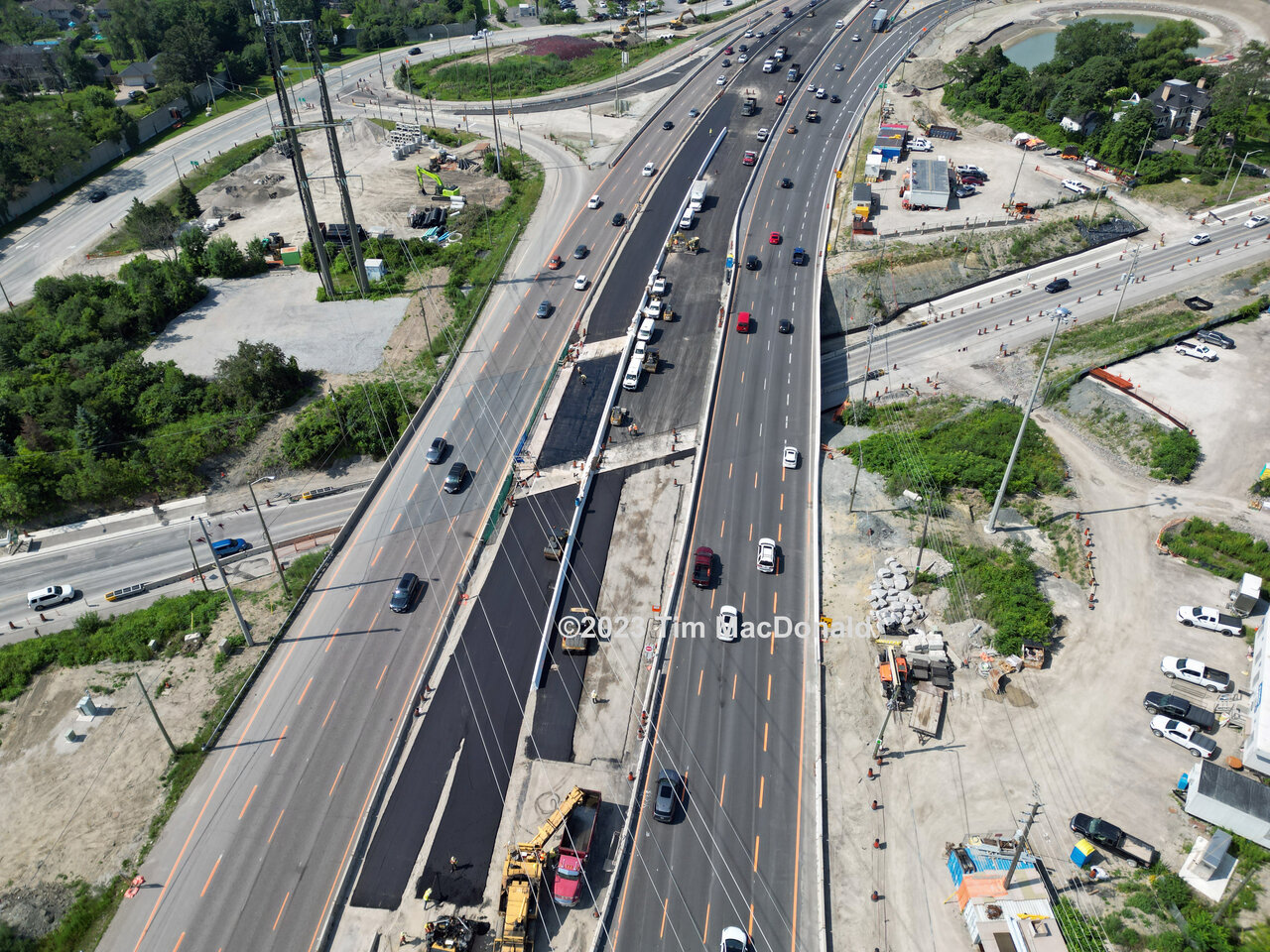

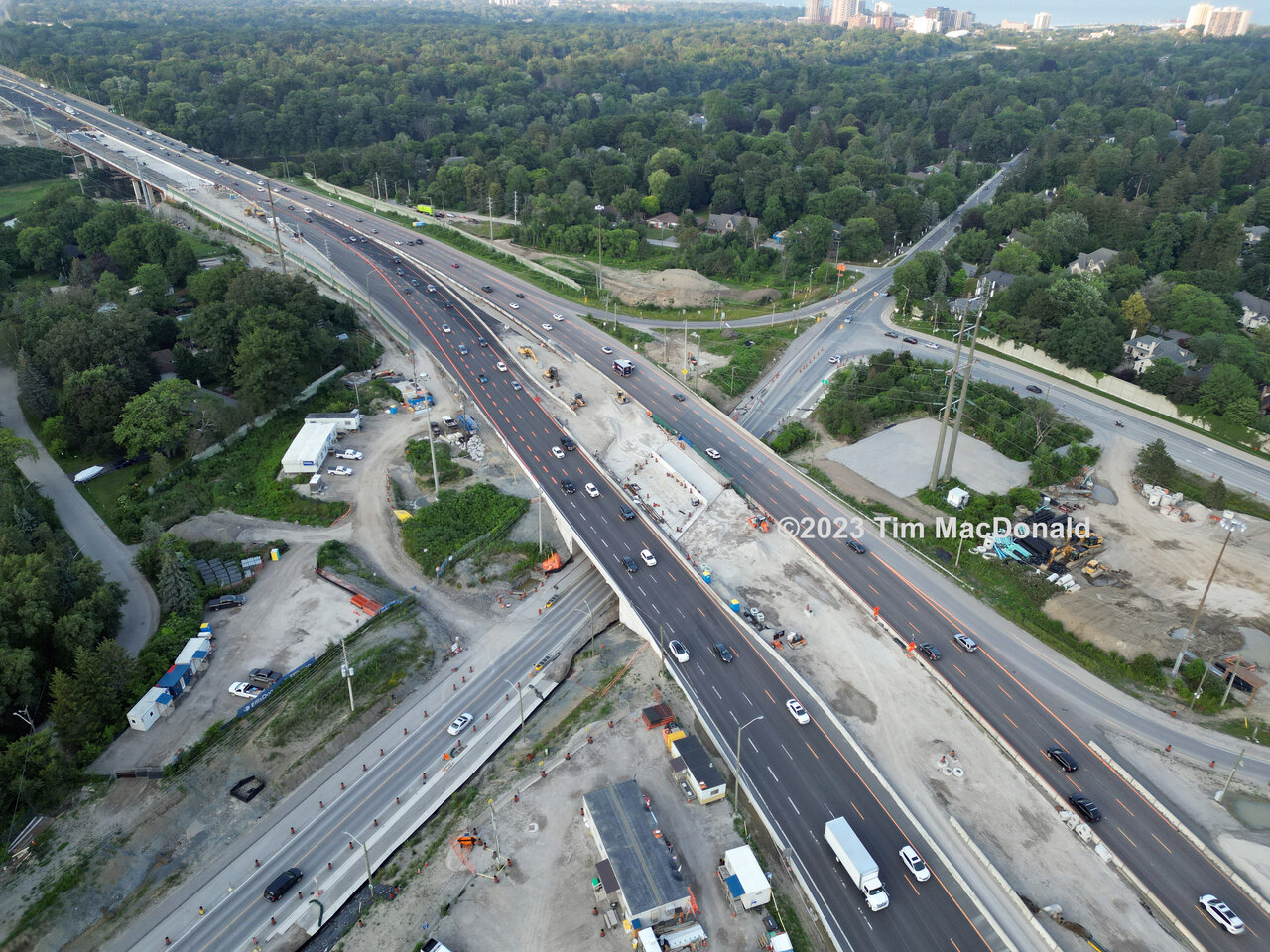

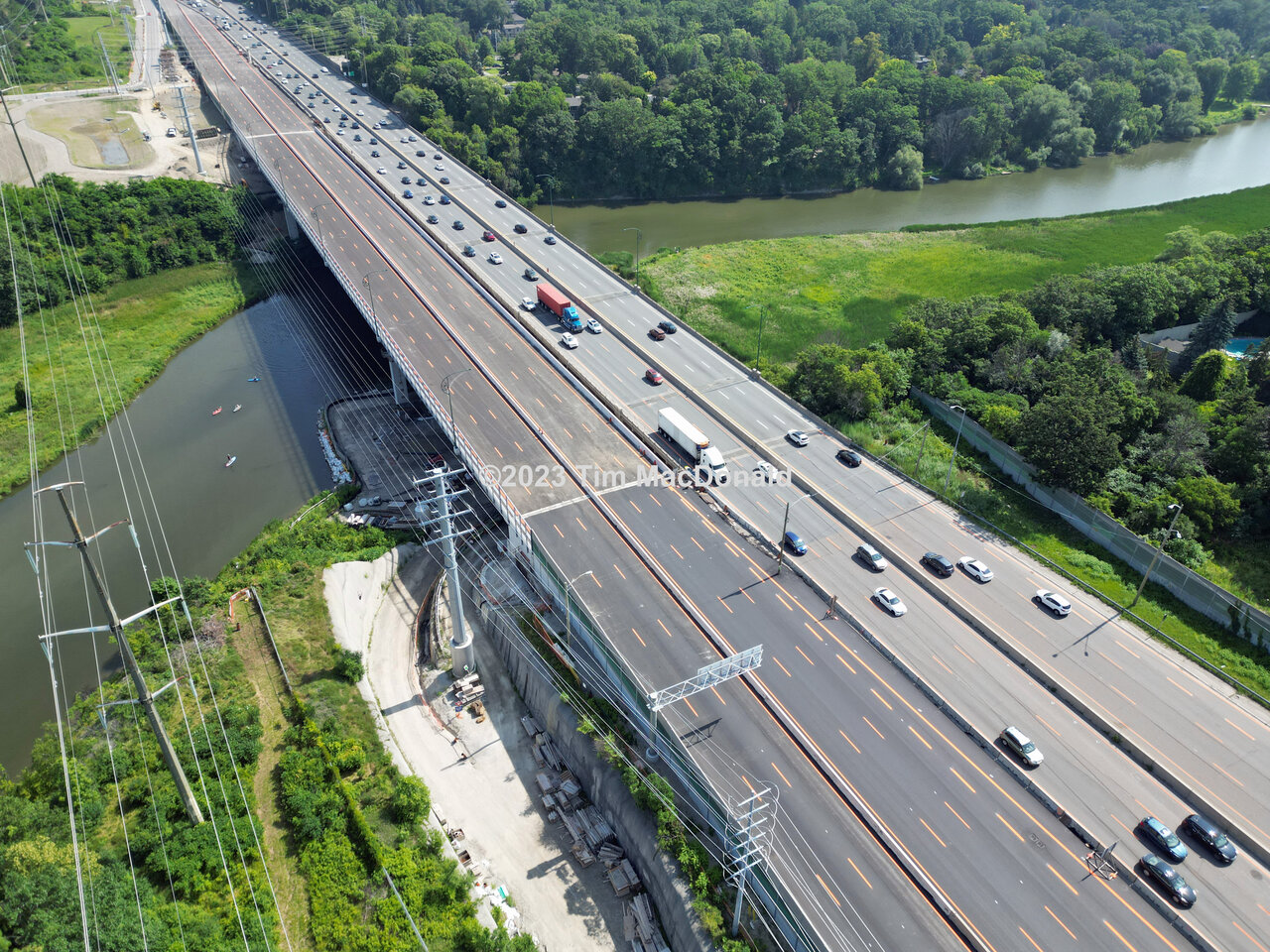

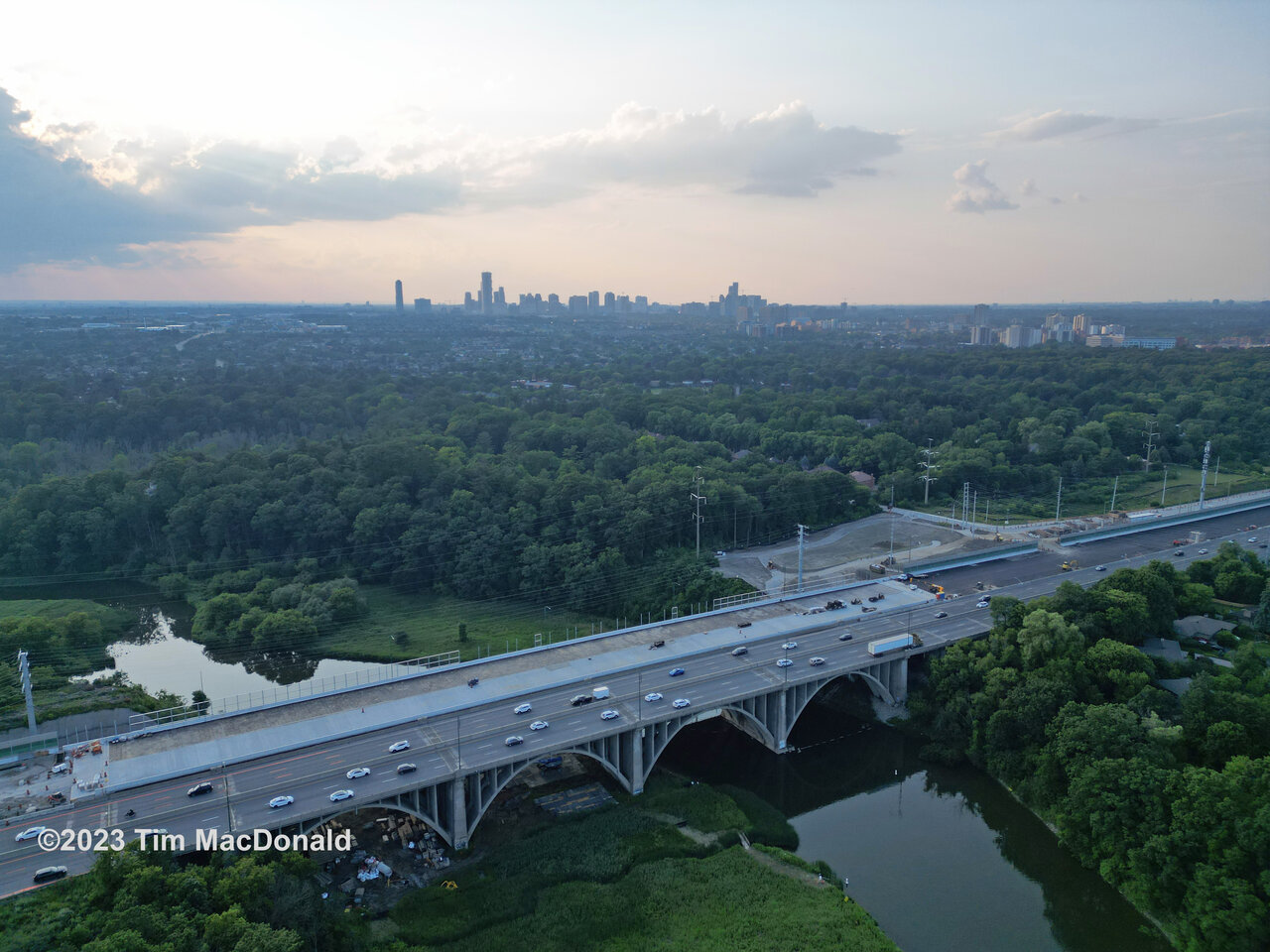

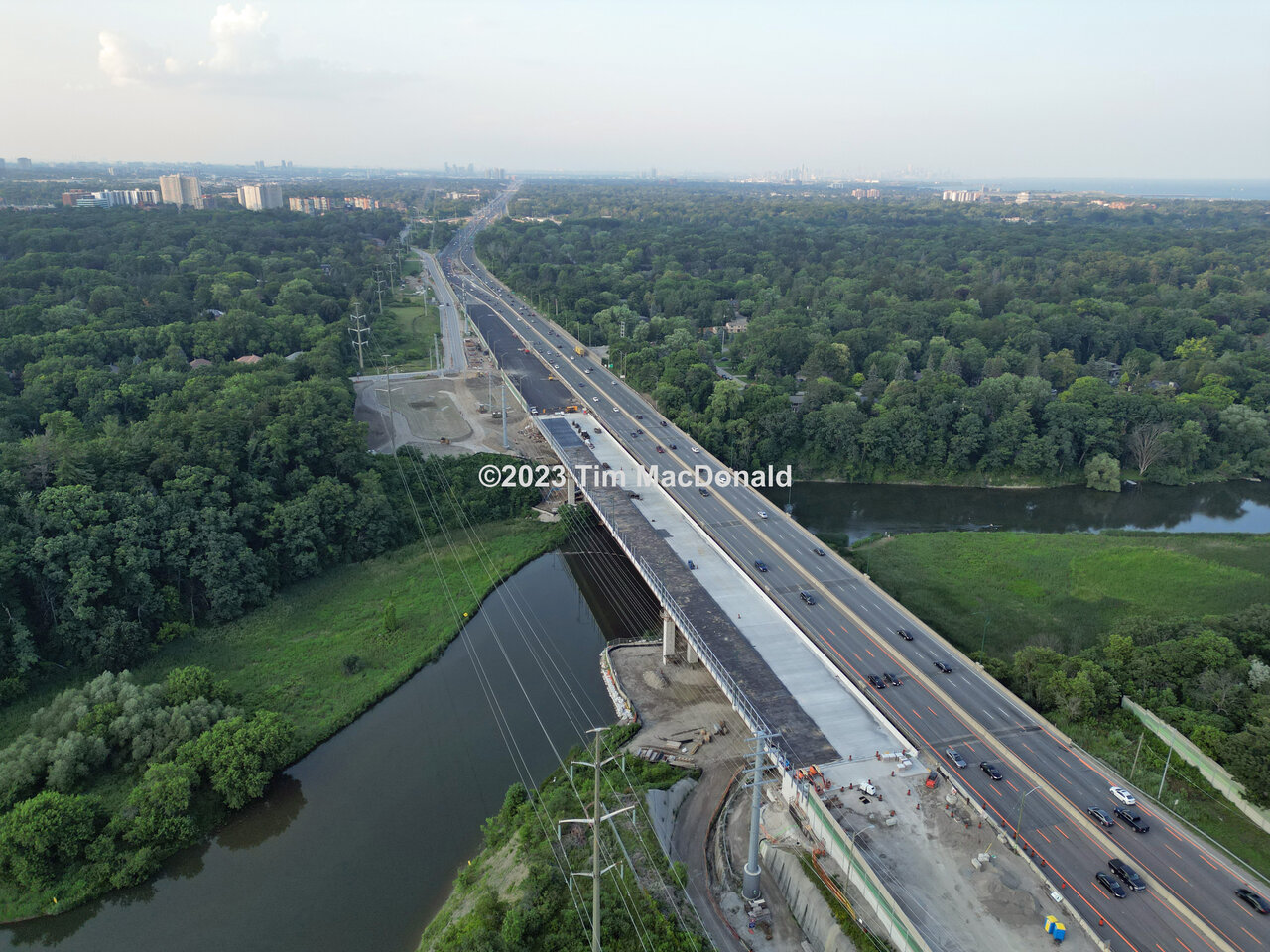

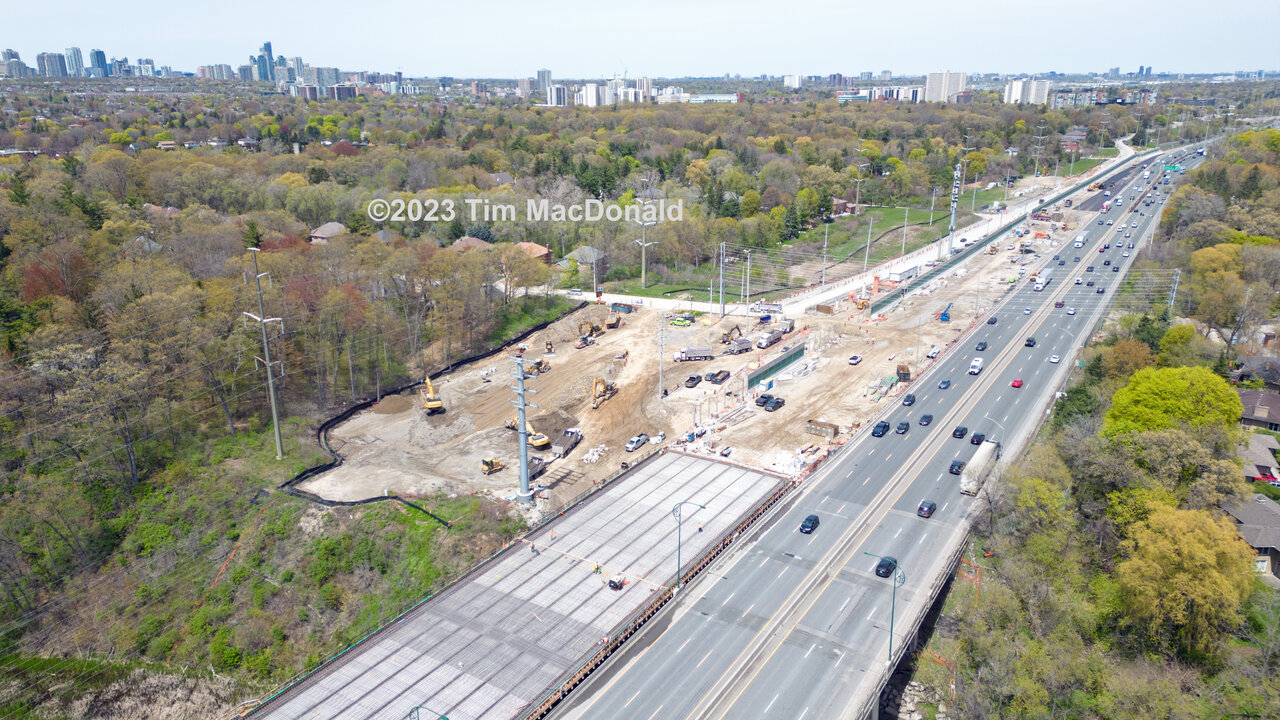

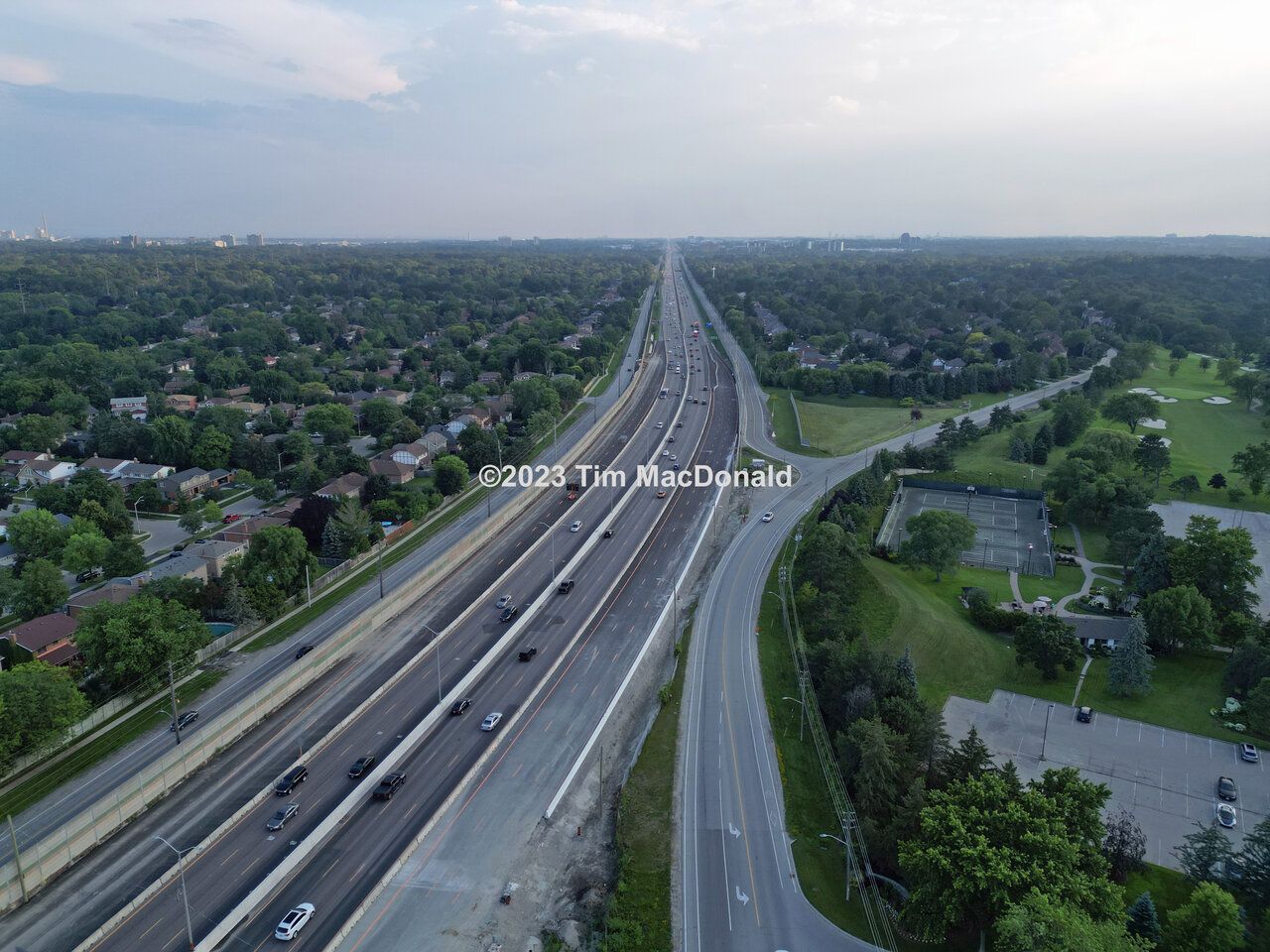

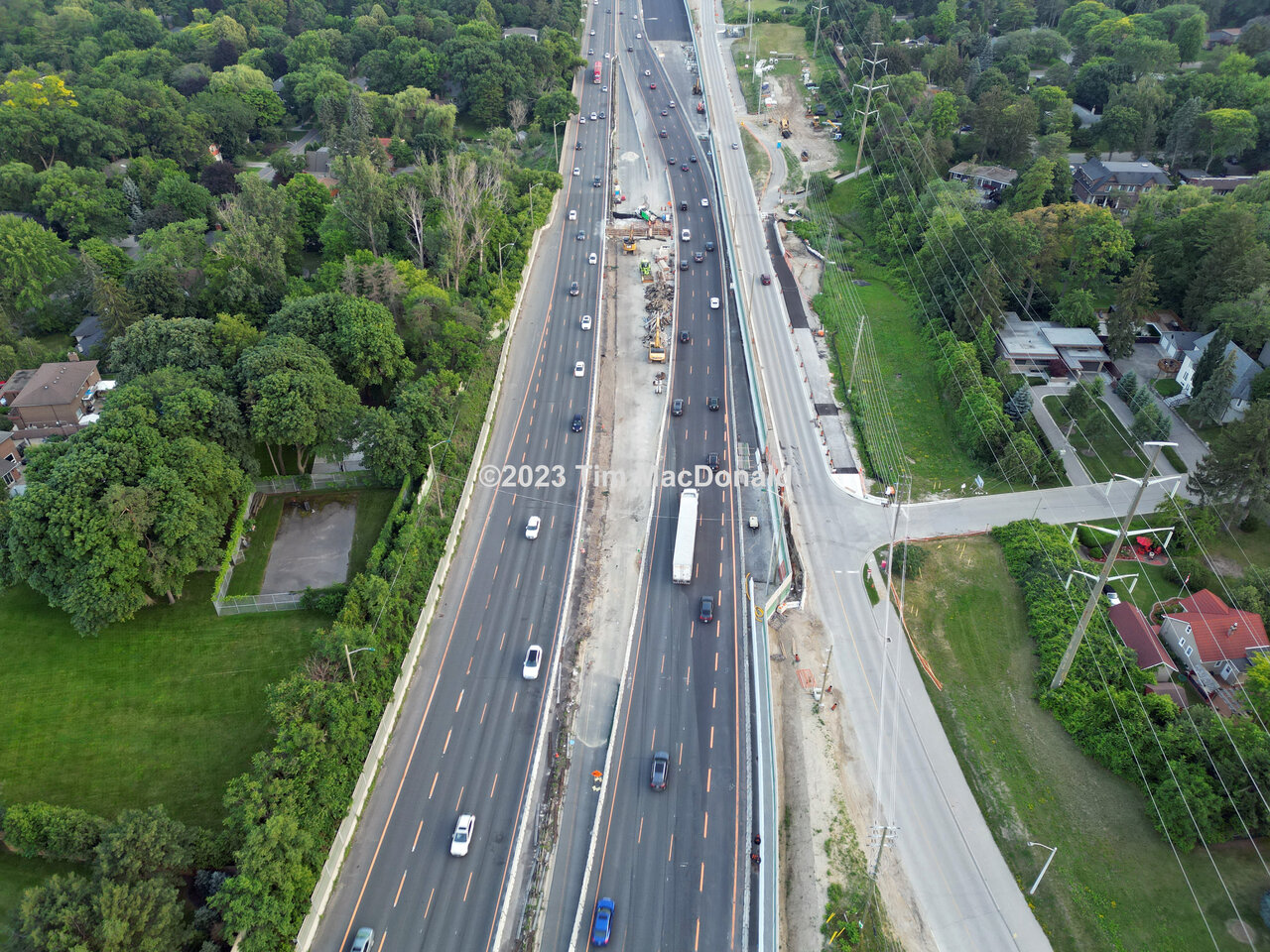

This the photo I was referring to that you shot and most likely wrong now.Further to my post earlier today, here are some photos from July 23rd. This new bridge is marked to carry six lanes of traffic - 3 in each direction.

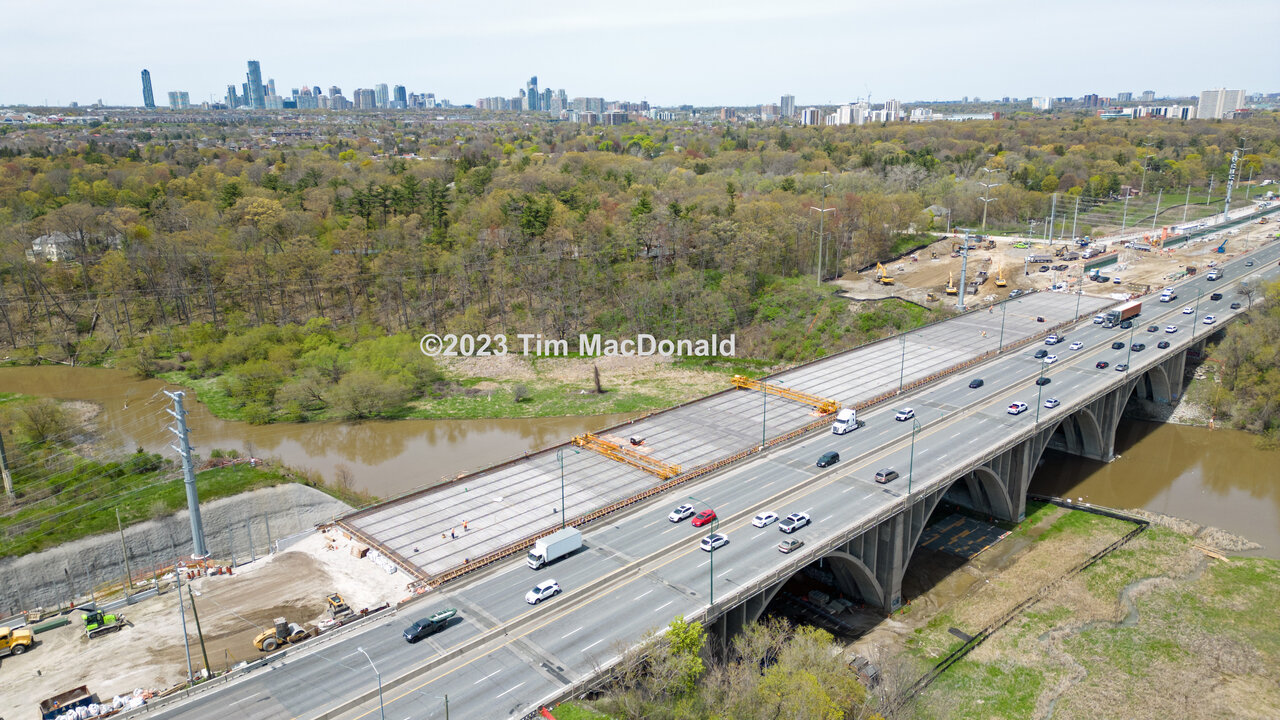

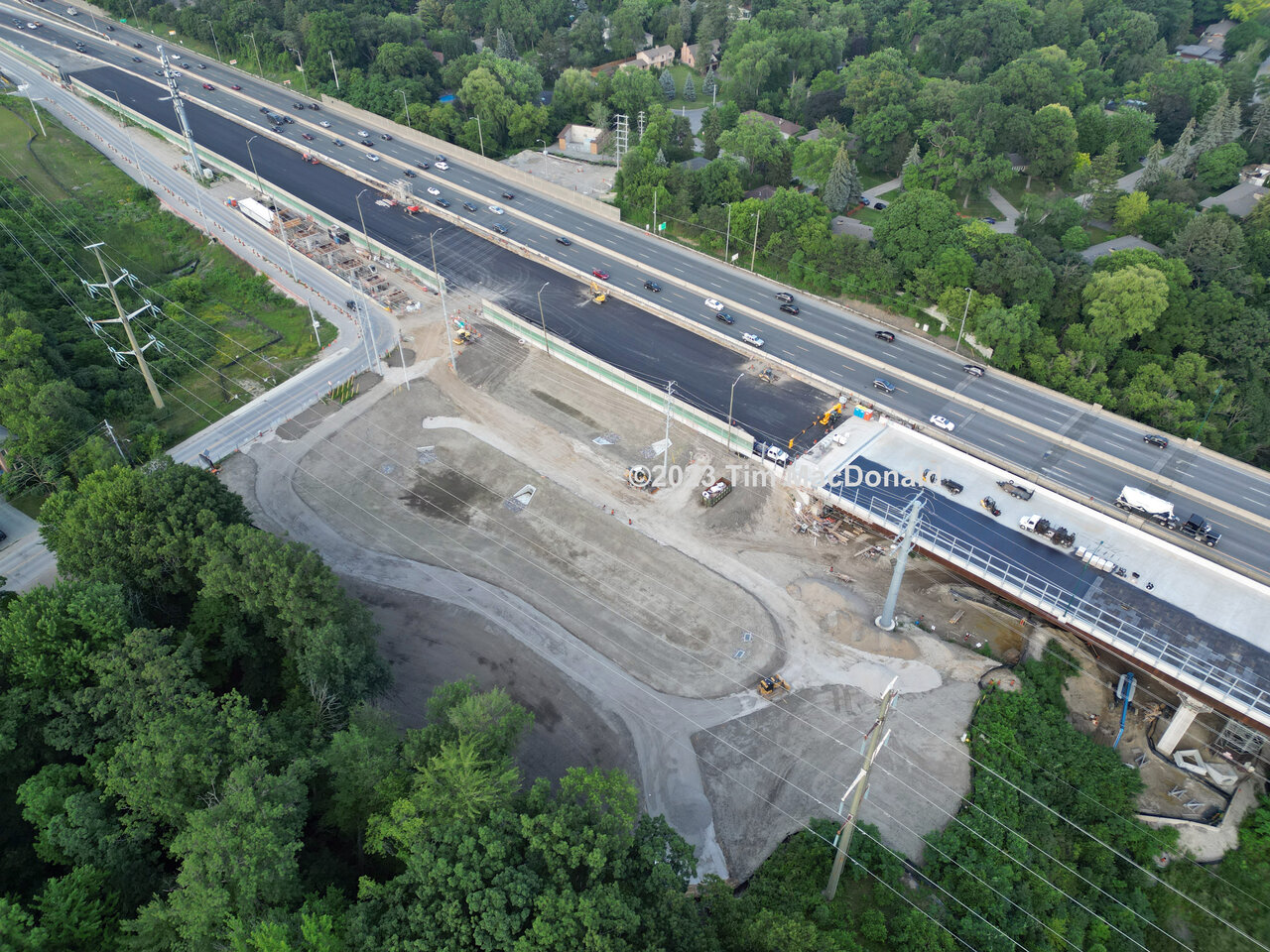

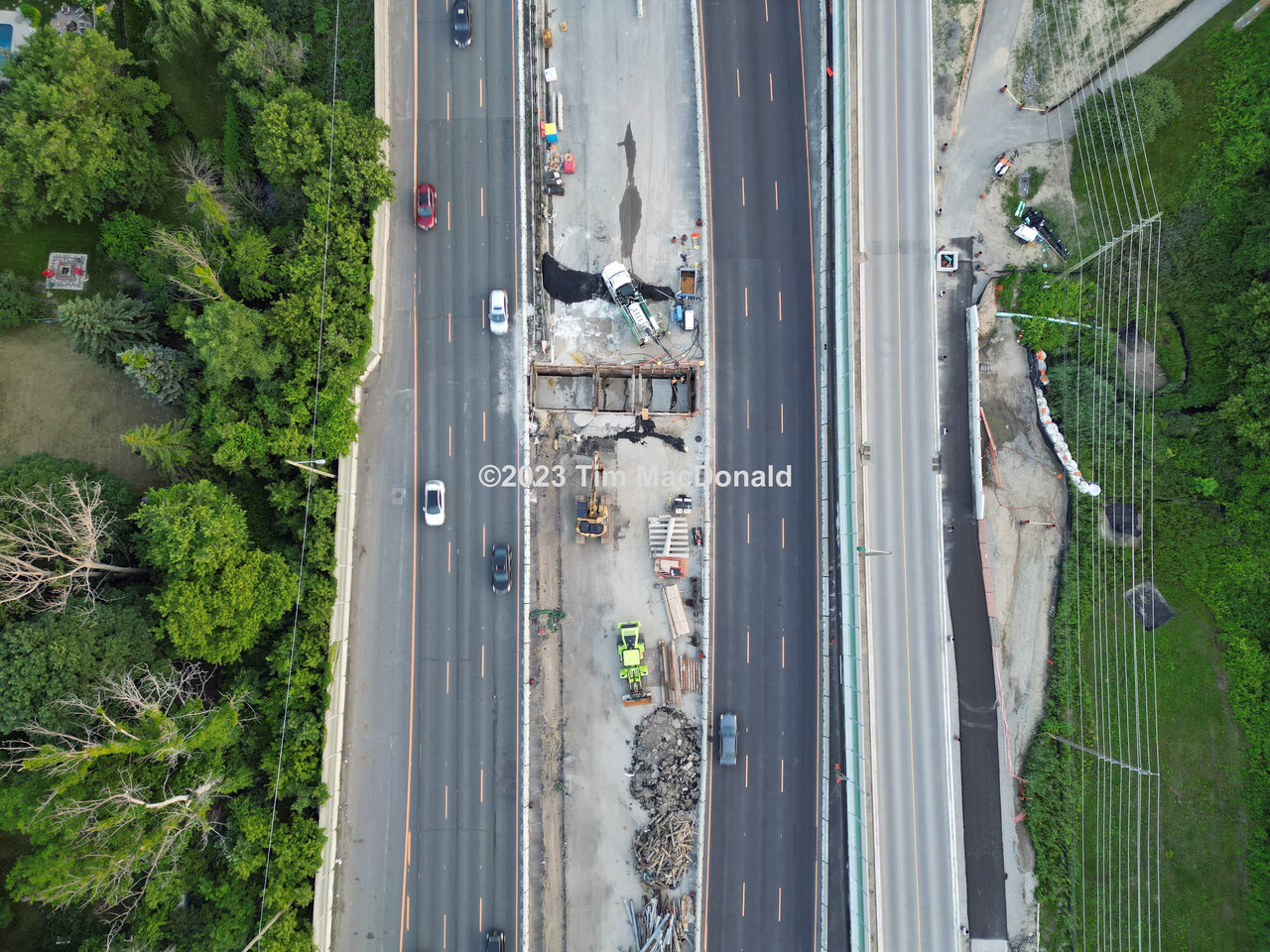

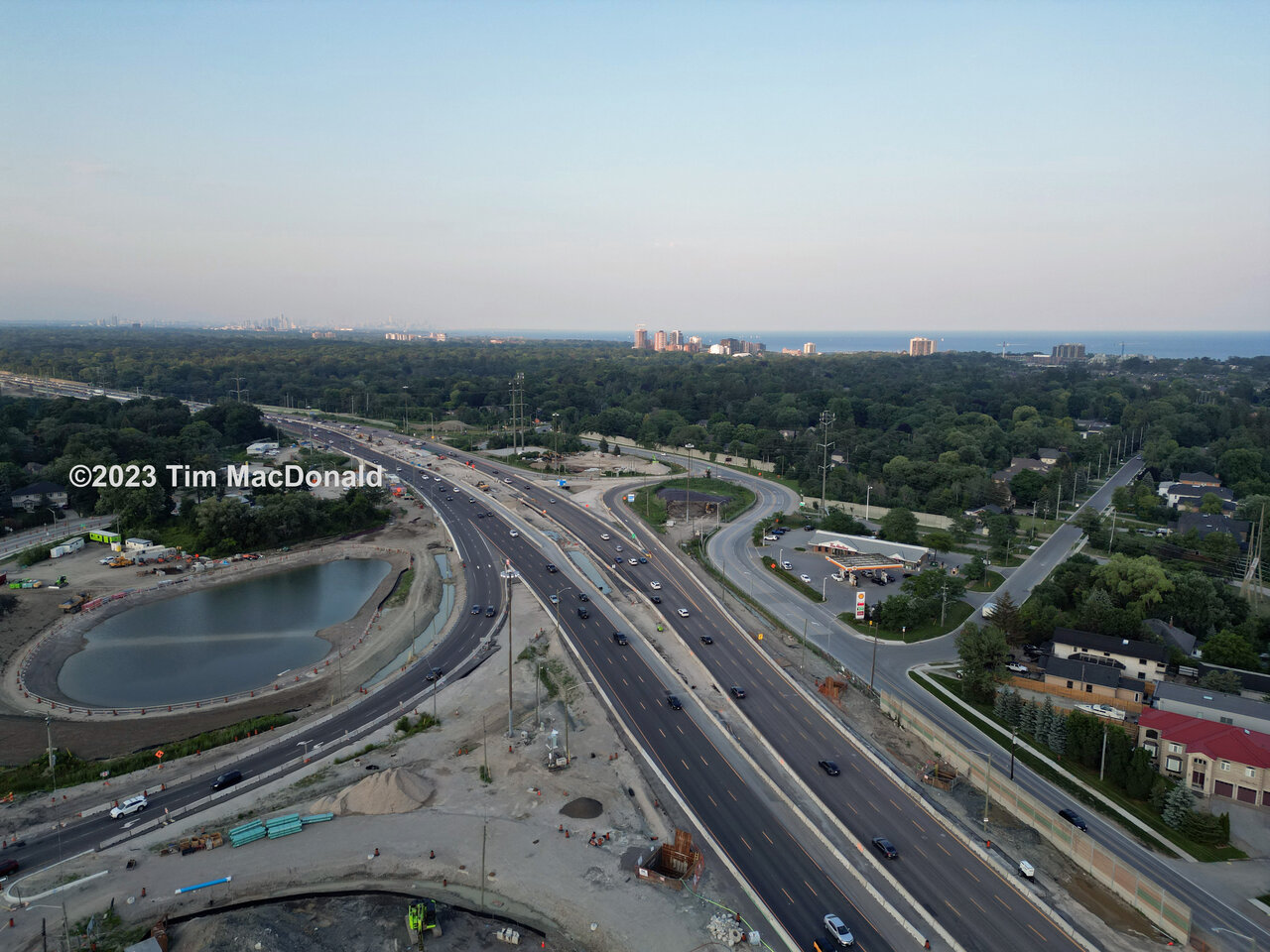

I don't see a parking lot on the east side that @drum118 referenced in his June 24th post. It appears to be storm water retention pond. Supports for the pedestrian bridge on the north side, east of the river, seem to be forming.

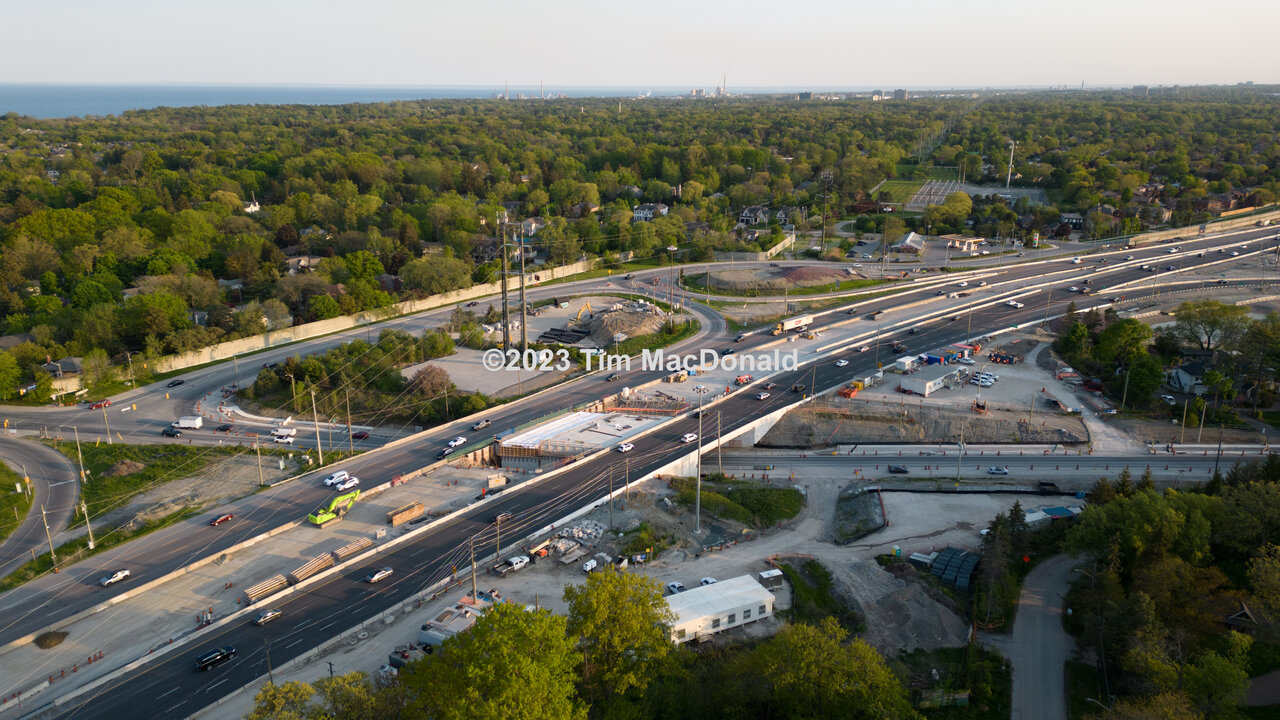

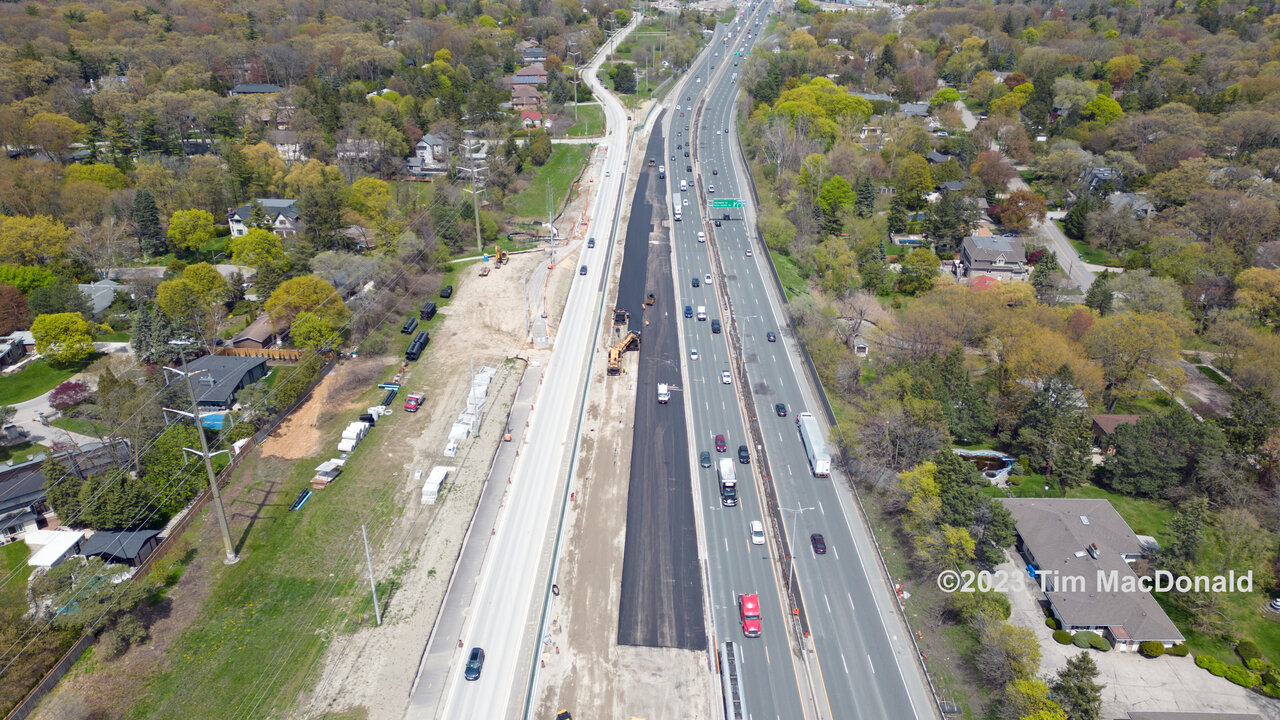

They've kept the street light design and these have been installed on the new bridge.
View attachment 494728
