W. K. Lis
Superstar
When will it be dug up again to repair the "deficiencies"?
It still on schedule to be completed by the end of 2024 with service starting Q1/O2 2925. Based on what I am seeing first hand, the date will be met even with a few sections being almost a year behind schedule, like PC tunnel.When is this like planned to open? Seems like early 2026?
This will not be like Crosstown nor KQQR work. There has been a few areas that have been rebuilt due to poor concrete or a change in design. It even different than the Finch project where Finch has been a nightmare to drive on it while Hurontario has had a few bottlenecks from tine to time including 2 full weekend closure for intersections.When will it be dug up again to repair the "deficiencies"?
It still on schedule to be completed by the end of 2024 with service starting Q1/O2 2925
We don’t want an Ottawa situation do we.900 years for testing? I guess if you really, really, really want to iron out all the glitches....
LOL how did I do that when it was supposed to be 2025?? So much for not proof reading things before posting these day. The system would be obsolete in that 900 years of testing900 years for testing? I guess if you really, really, really want to iron out all the glitches....

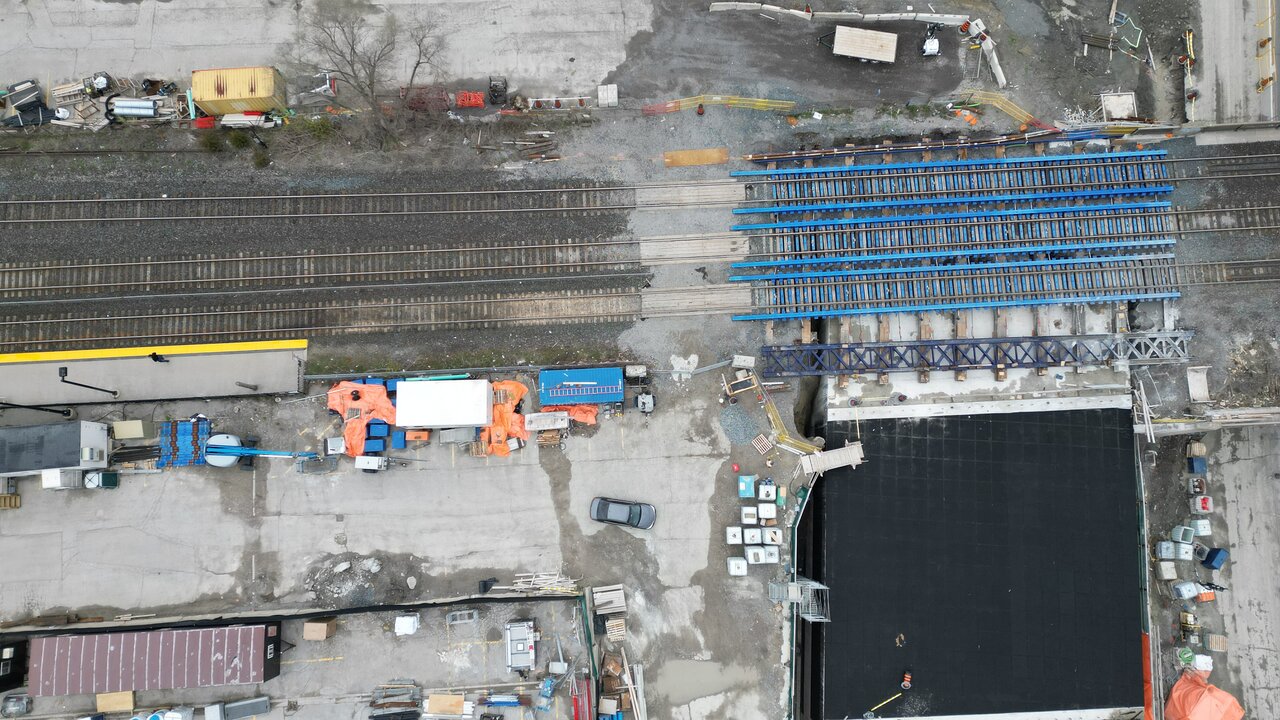

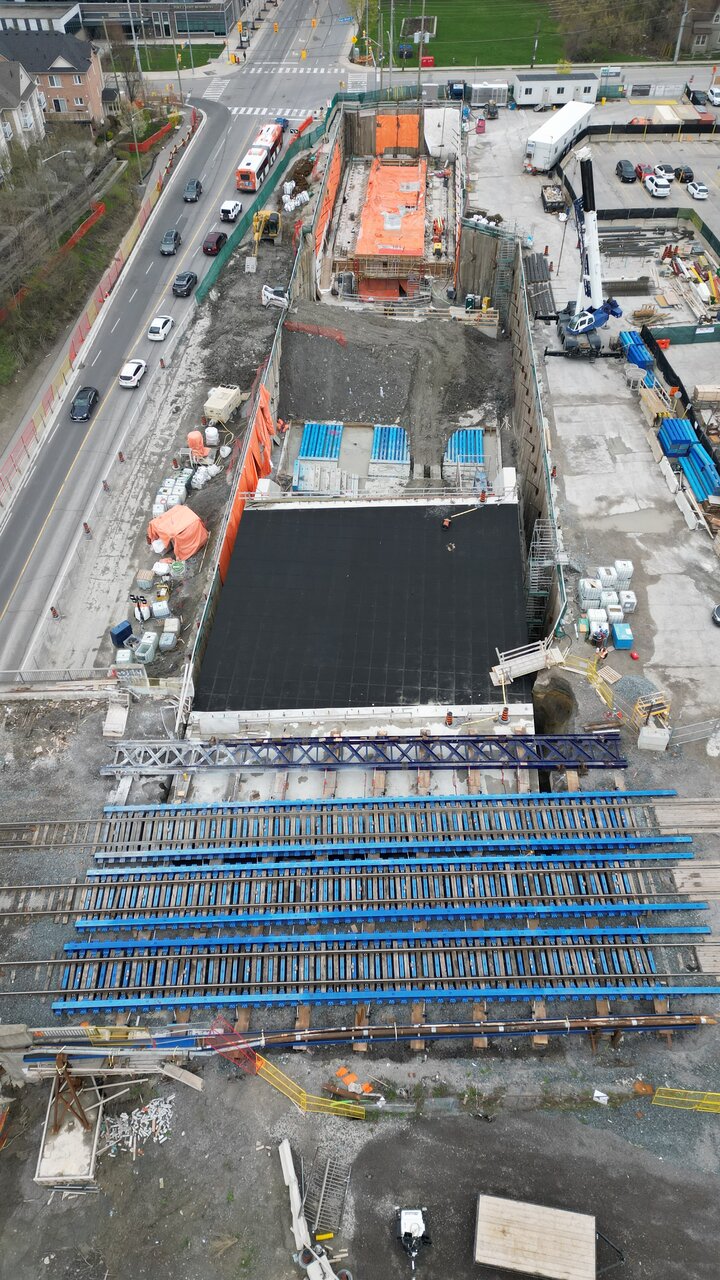

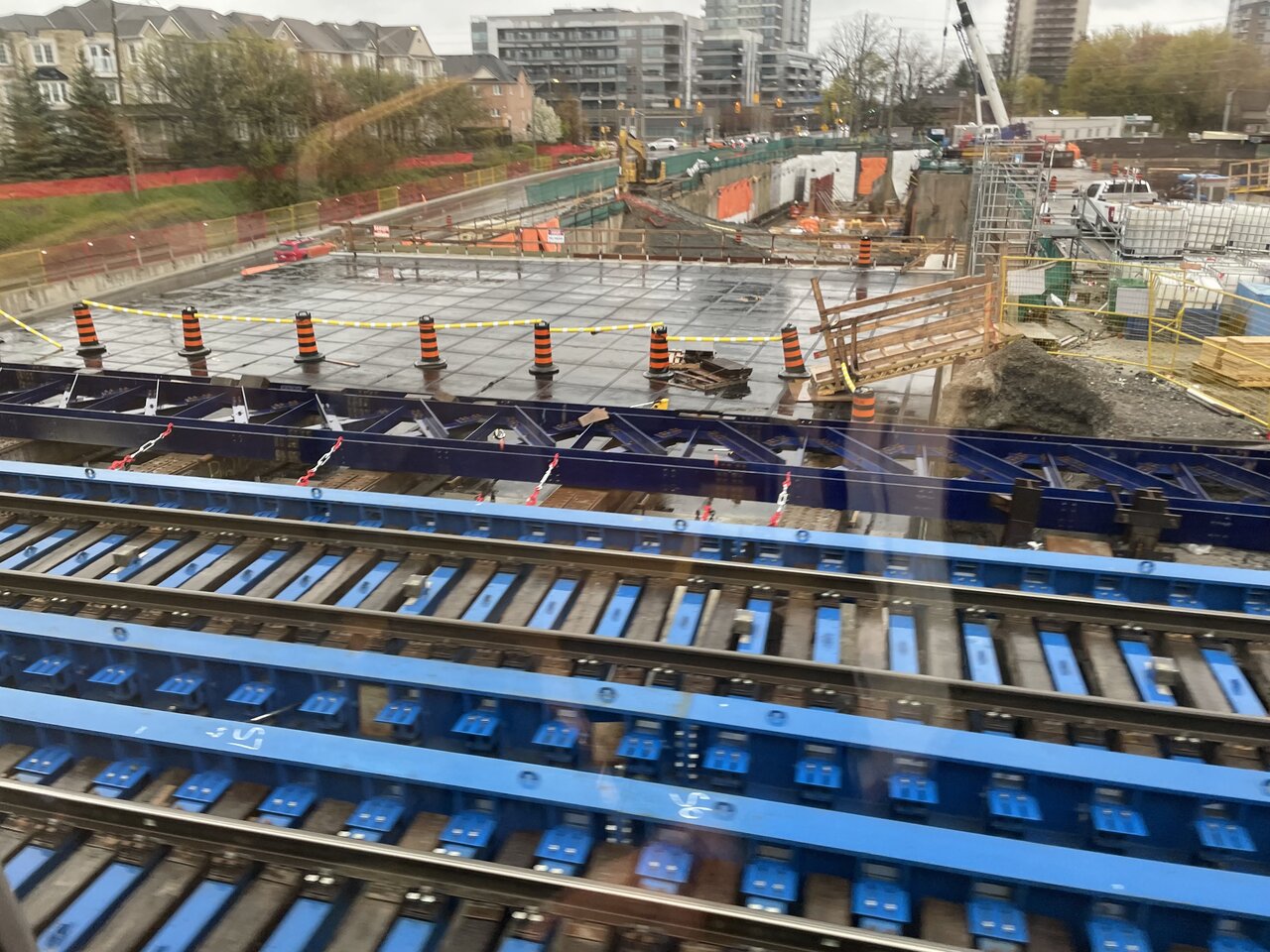

From today (May 2nd), Tim’s photos above for comparison. The black waterproofed section is now solidly below the dark blue support structure. Some good movement.
That was raised at a council committee last week when the update on the line was presented to then at the time. Council wants the loop done when the line opens in early 2025 as well a timetable for the current work as to when X will be completed.
Its an yes and no, but we will see. The PC box is a year behind, but hasn't delay much. Some of the delay has been caused by ML related to the box, not the contractor. The QEW box was 3 weeks behind. The elevated guideway was 4 months late starting A lot of the yard track is behind schedule, but not effecting anything other than manpower that could be use elsewhere.I heard through the grapevine, 2 years ago, that the project was already tracking behind schedule.. so we shall see...
Let see.......the surface route would free up $2 Billion that can be use for many projects as well riders would be using it years before the subway is ready to run.There’s a new report to the Brampton Committee of Council summarizing the 30% design of the northern extension to Downtown Brampton.

The surface design – which would require the lowering of Main Street under the CN overpass and a below-grade terminal at Brampton Station – would cost over $900 million

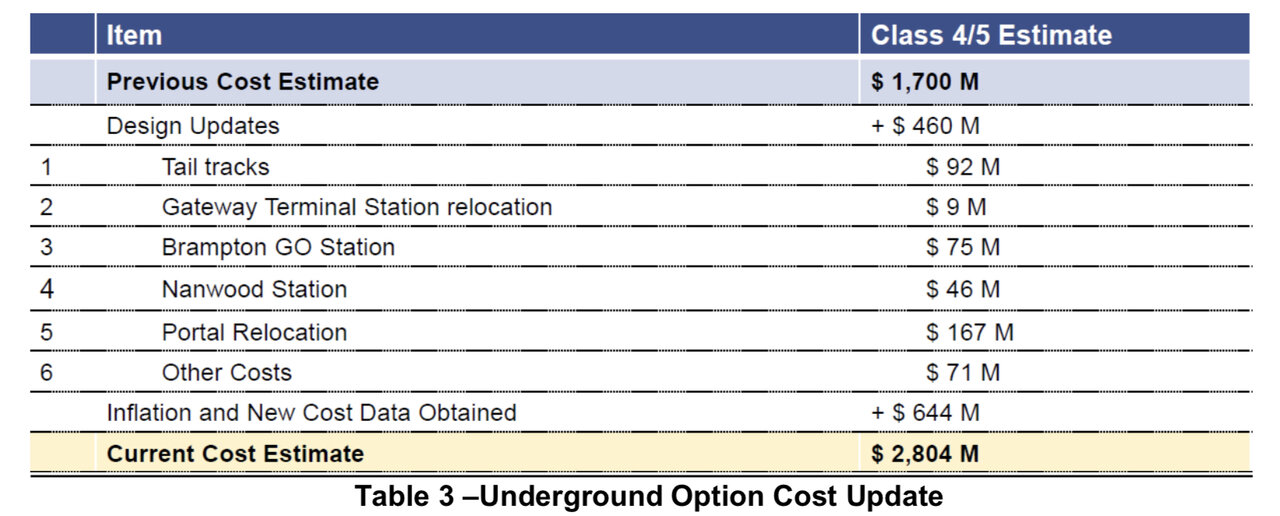

The underground tunnel would cost over $2.8 billion.
View attachment 474169
View attachment 474168
The underground option is preferred for every reason but cost (cycling infrastructure, heritage, downtown public activation, traffic).
It’s worth reading, as it shows what the Brampton surface LRT terminal would look like (the heritage railway station would be moved) and how the city would make its case, comparing costs and ridership to other transit projects.
I’d rather the surface option get advanced – because it’s going to be more appealing to provincial and federal governments – but I just want the damned link completed.
It’s also worth noting that the relocation of the Brampton Gateway Station would cost just $9 million – it’s infuriating that Mulroney and Metrolinx aren’t willing to budge on that as phase one is underway.
There’s a new report to the Brampton Committee of Council summarizing the 30% design of the northern extension to Downtown Brampton.
The surface design – which would require the lowering of Main Street under the CN overpass and a below-grade terminal at Brampton Station – would cost over $900 million
The underground tunnel would cost over $2.8 billion.
Brown and company can say it is tunnel or nothing at all once full 30% is done.The link is giving 404 Error page Today. It looks like the same chart from Feb 27'th and figures we saw a couple months ago at the Brampton Council LRT session.
https://pub-brampton.escribemeetings.com/filestream.ashx?DocumentId=81694
The cons for the surface are manufactured on purpose as I broke down in this thread in February. $216M of the new $933M surface costs are from a new underground station added into the design over the 2015 plans. I recently publicly questioned the Integrated Downtown Plan pushed by staff who have no interest in giving priority to any transit vehicles through the downtown as they remove 2 lanes and was responded with condescending answers where such a consideration was considered "extreme".
The path that Mayor Brown is taking by putting all eggs in one basket because the "surface shortchanges the tunnel ask" is going to result in nothing being funded at all and this LRT ending at Steeles indefinitely.
I'm keeping an eye on when they halt progress on the surface study to prioritize the tunnel. Likely in a decision once the full 30% design docs are released soon.
