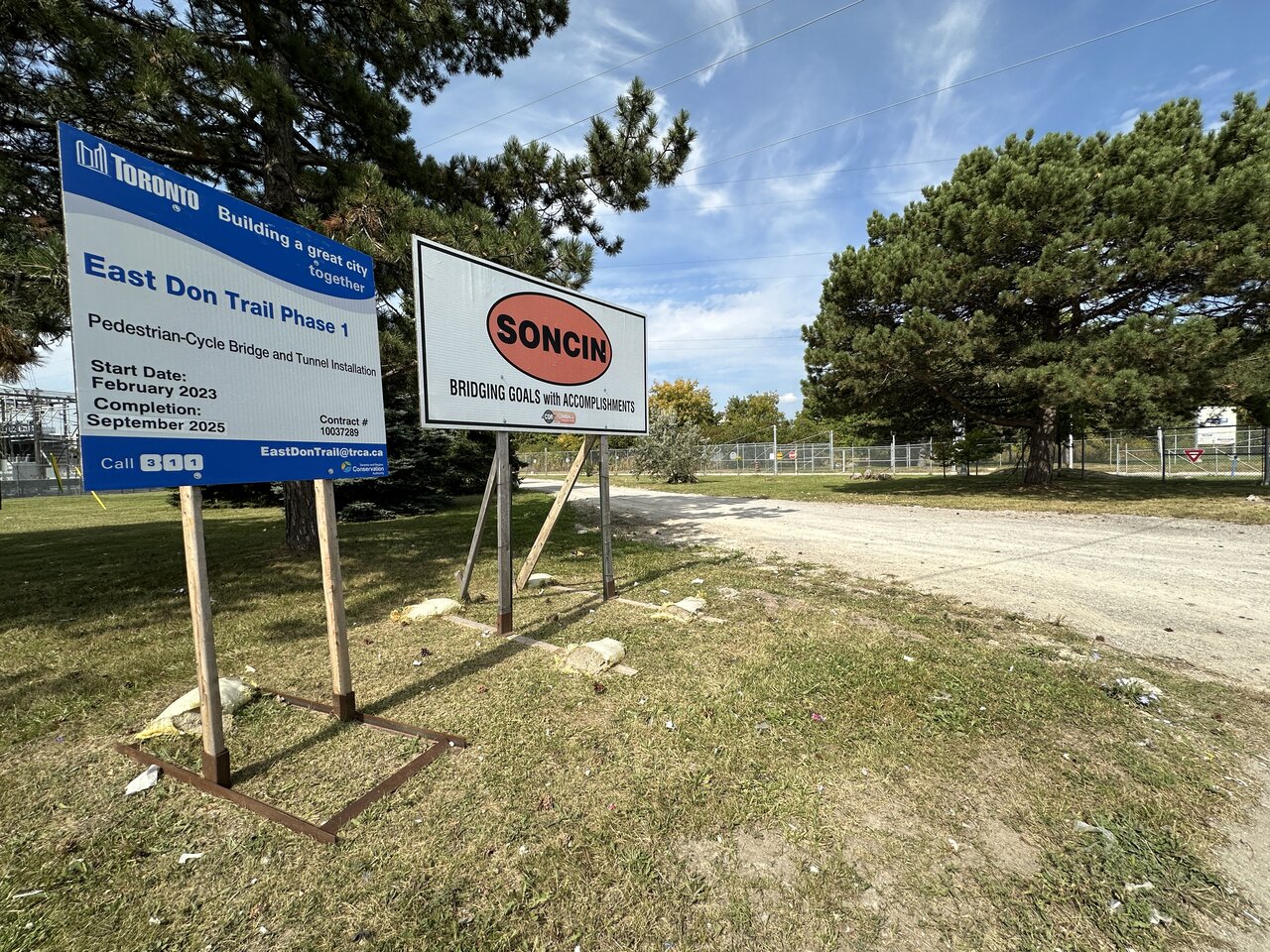

|
|
|
The completion date does not specify when the project will be ready to use (in most cases). It specifies when the entirety of the project is complete and when the site(s) has been demobilized and returned to its final condition.A recent walk-about. 1 of 2 photo dump.

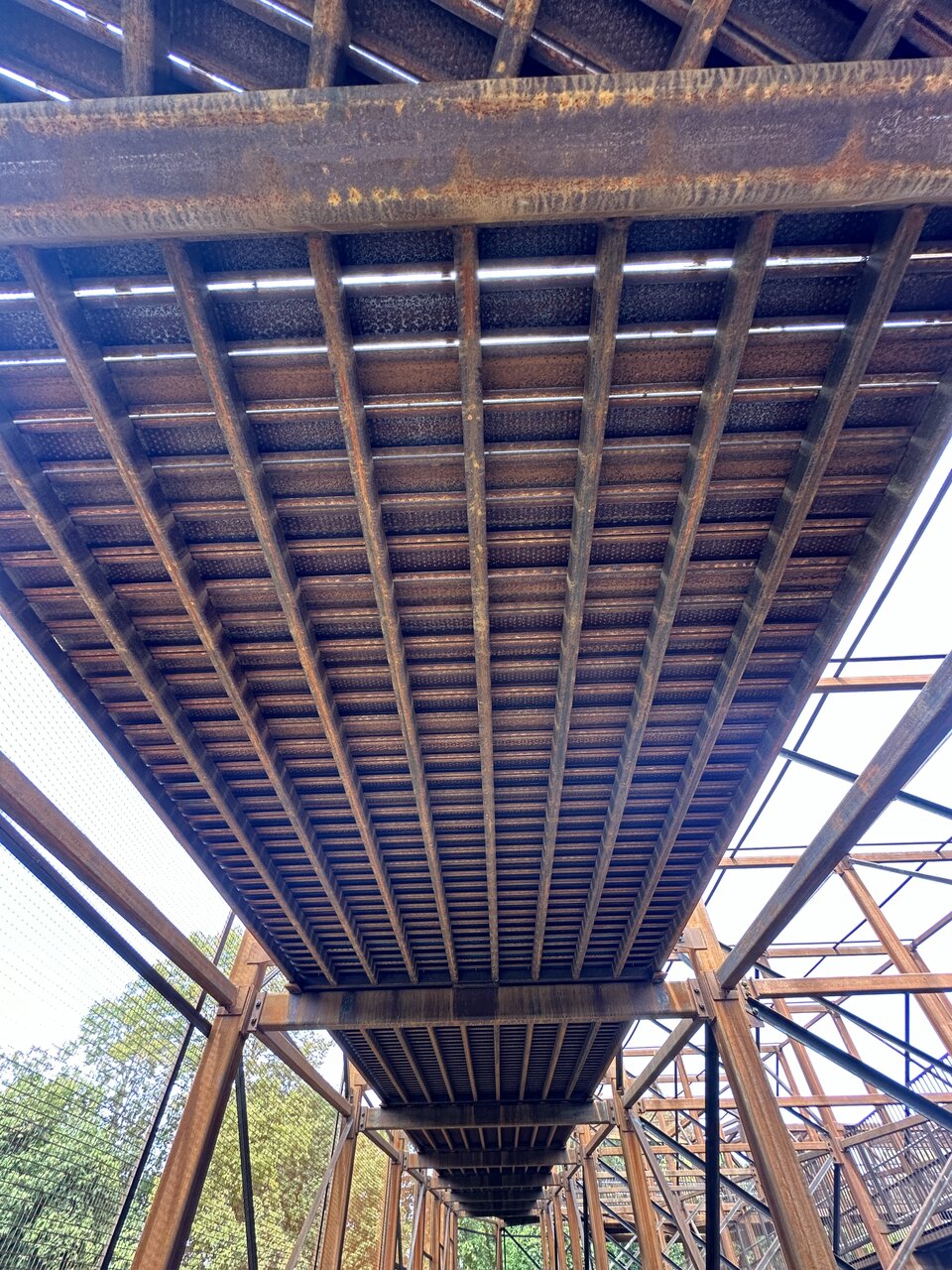

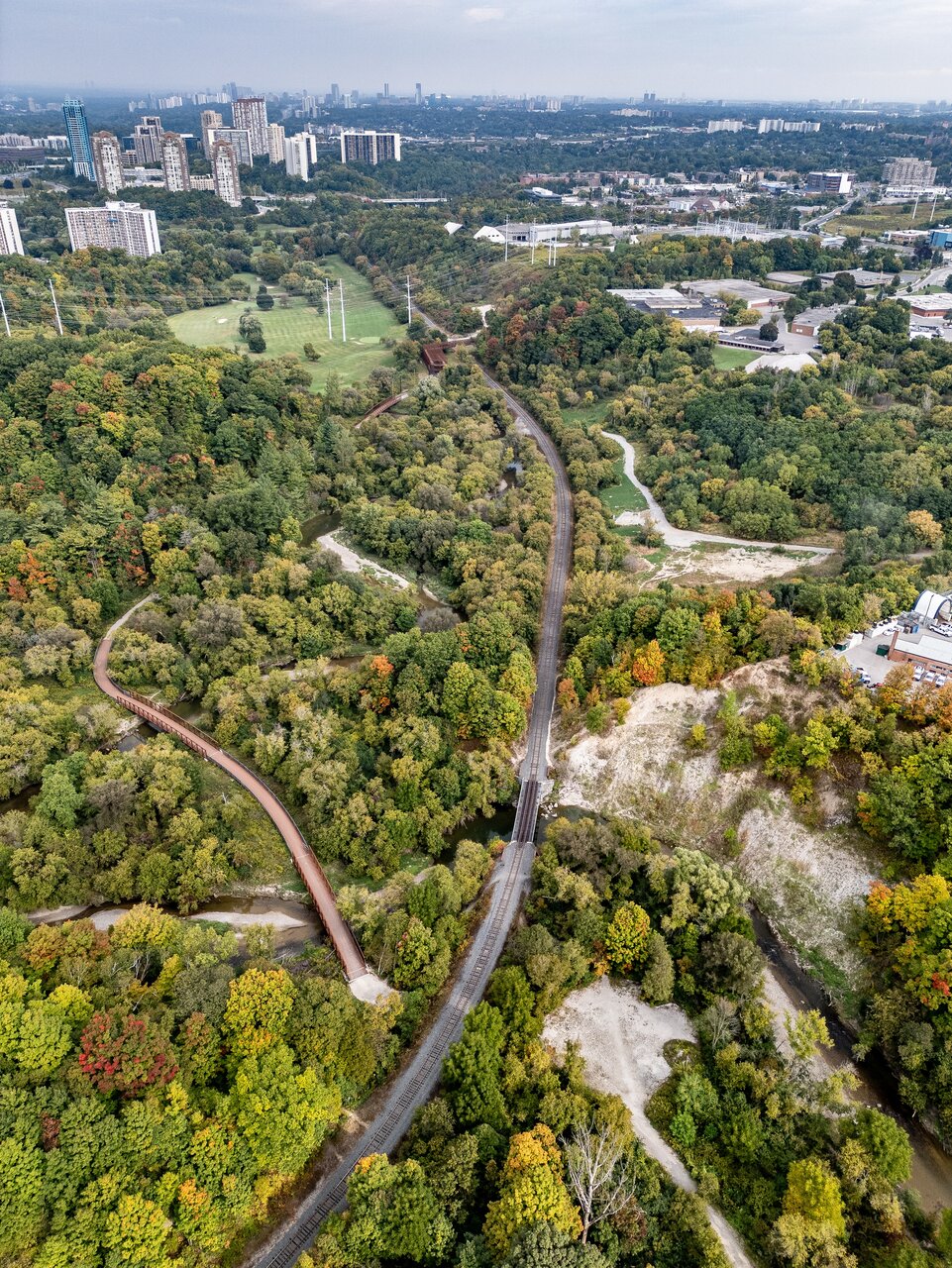

Sept 2025?! - They just need the tunnel completed and a little paving on the south end.
View attachment 597443
Embarrassing slow progress. When is this tunnel finally constructed?
This trail is taking about as long as a subway project… really sad honestly.
October, as I understand it.Embarrassing slow progress. When is this tunnel finally constructed?
October, as I understand it.
And as Northern Light correctly points out above, the factor is entirely trying to coordinate with Metrolinx.
Dan
Took a look today.....nada....Embarrassing slow progress. When is this tunnel finally constructed?
If I understand correctly the city is also now looking to push this trail section further north to terminate at the north side of Eglinton (so under the bridge and up via the access road). I am told the city is keen to start that work as soon as possible. If you've walked the 'Kitchen Sink' trail this summer you might have seen flags and stakes, which I believe is the intended route, but don't know for certain.
The spring 2024 update indicated:FYI the Bermondsey Access road is now paved.
In terms of completion date: I have been told by someone close to this, that this project's completion date has been pushed back a year. Fall 2025 is when the tunnel is expected to be completed. Which is quite disappointing. If I understand correctly the city is also now looking to push this trail section further north to terminate at the north side of Eglinton (so under the bridge and up via the access road). I am told the city is keen to start that work as soon as possible. If you've walked the 'Kitchen Sink' trail this summer you might have seen flags and stakes, which I believe is the intended route, but don't know for certain.
The tunnel-associated works are continuing to progress, with track closure dates secured for Fall 2024 to facilitate the installation of the tunnel.
In preparation for the tunnel installation, preliminary work is required for the relocation and temporary support of existing utilities (i.e hydro, communications etc.) along the section of rail line at the proposed tunnel location.
Successful completion of this task is critical in order to meet the scheduled track closure date for the tunnel installation as cold weather restrictions for working within the rail corridor will postpone the work into 2025.
The Project Team is diligently monitoring the progress and will be working with Metrolinx to secure additional track closure dates, if required.
The tunnel-associated works are continuing to progress, with track closure dates secured for Spring 2025 to facilitate the installation of the tunnel.
In preparation for the tunnel installation, preliminary work is required for the relocation and temporary support of existing utilities (i.e hydro, communications, etc.) along the section of rail line at the proposed tunnel location.
CN issued a request for proposal for Bala Sub Mile 7.3 Fiber Relocation in October 2024 and awarded the contract November 2024. They are anticipating submitting the work plan methodology and permit soon to Aecom/Metrolinx and starting the work by early 2025.
How many years did they need to figure that out and schedule it?
FAR too many!!How many years did they need to figure that out and schedule it?
I presented the updates without comment because I don't know who to point the finger at, but if I were a betting man...To extract a salient bit here.......... they needed to reroute utilities prior to the tunnel work; they failed to get that done.
The question, is why?
TRCA would not normally move hydro infra, hydro or its contractors would be brought in for that........
If so......were they unable to deliver on time, or were they delayed from coming in by TRCA and/or Mx?
It would be nice if someone were accountable for the latest in an endless series of delays.
I'm not even asking for anyone to lose their job........just own up to the mistake and apologize, that would be a start.
