The Metrolinx 2041 RTP shows 15 minute service to Hamilton downtown, so it is definitely in a Metrolinx master plan.
Multiple sources confirm to me that multiple Hamilton stations will eventually get allday 2-way service. Toronto already has multiple, as does various GTHA municipalities such as Oakville area itself, and Burlington itself. Why leave Hamilton out of the fun!?

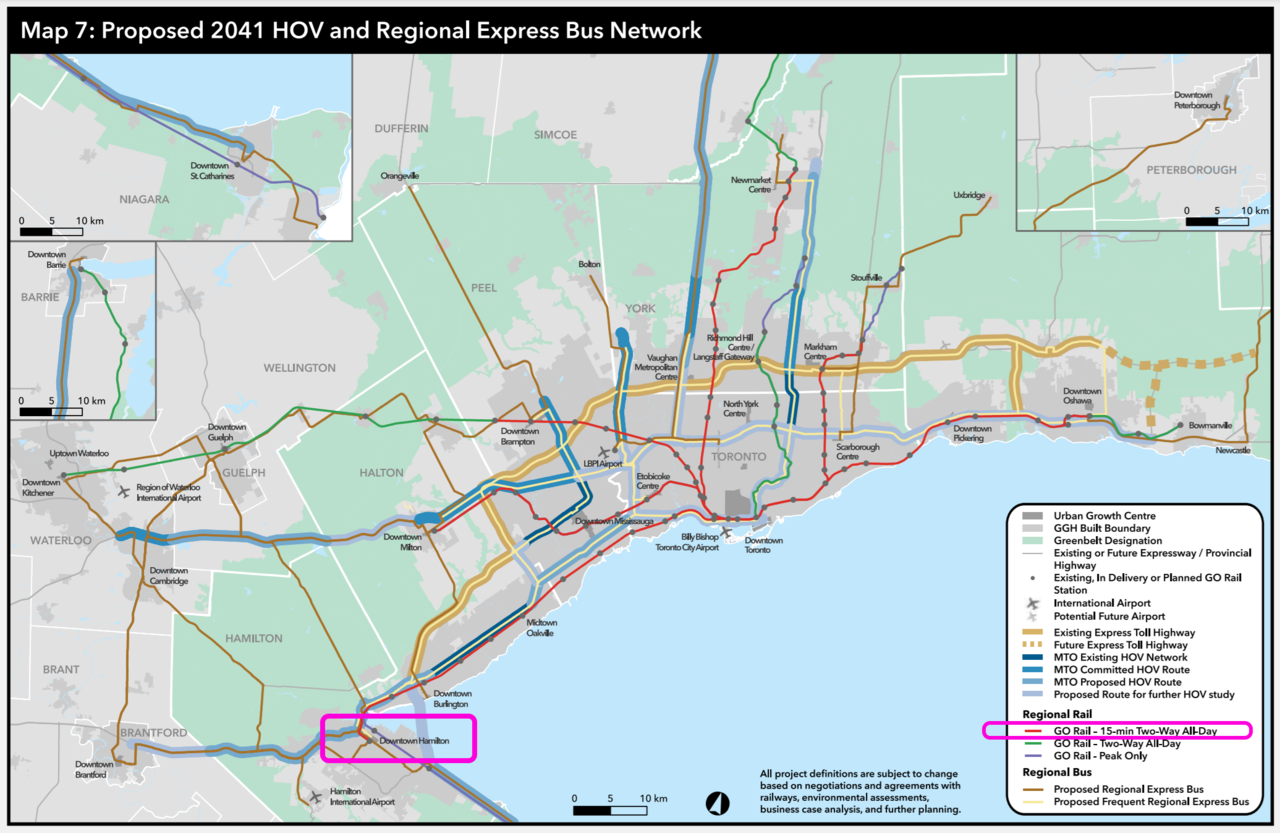

Here's proof, from the 2041 RTP map:
View attachment 337581

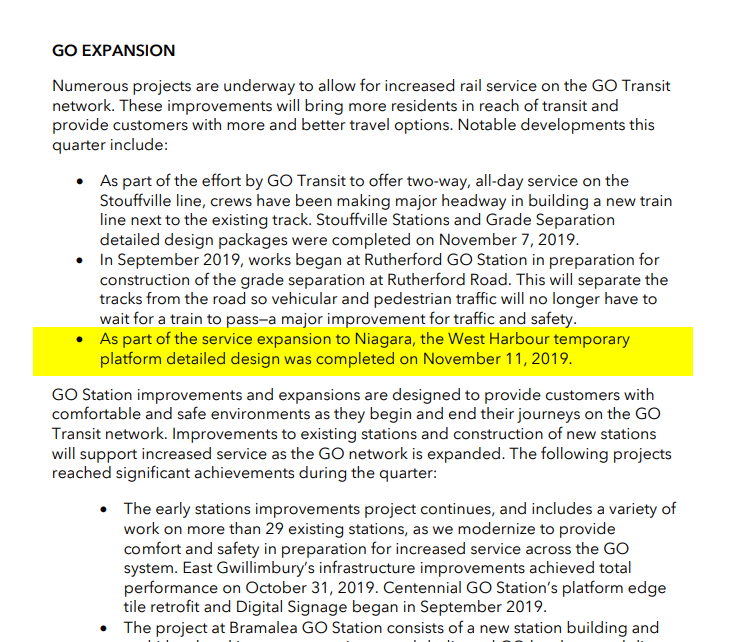

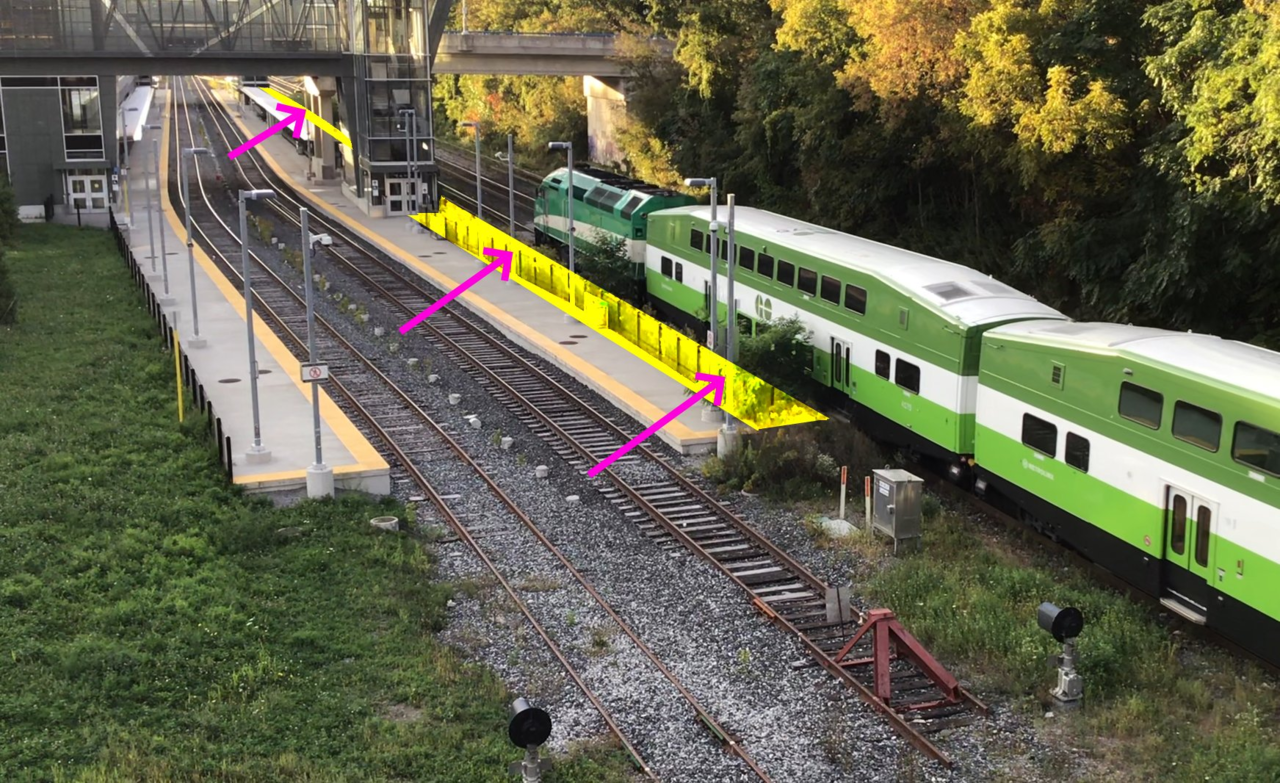

Certain things do go ahead of the 2041 RTP map, such as West Harbour all-day service was not originally part of the plan.
www.metrolinx.com/en/regionalplanning/rtp/
RTP is Metrolinx's once-a-decade 25-year masterplanning exercise, this is since the early works on 2041 RTP occured very early in James North GO planning long before 2015.
______________
Now my personal commentary:
I
predicted West Harbour All Day before Hamilton Downtown -- correctly way back in 2015 -- While the year was wrong, I correctly predicted all day 2-way service would occur with West Harbour first
before Downtown Hamilton.
So another prediction gone correct for me! Though my year (2016) was wrong ....
ob-vee-ous-ly .... (in a very slow, droll voice) -- but yay it happened. And in the sequence I, myself, predicted six years ago when I was reading the Metrolinx tea leaves of on-ground construction proofs...
The track Aldershot-Hamilton is owned by CN (to West Harbour) and by CP (to downtown Hamilton). Metrolinx successfully paid CN to build an extra track from the Bayview junction, over the Desjardin Canal, and through the railyard to West Harbour, enabling hourly service to be doable without interference with CN freight. Now, downtown Hamilton.
15-Minute Electric Service on CP Corridor
Path #1 Forward for CP corridor problem: Because of the catenary disallowance on freight corridors. I believe it will wait until
battery trains become practical (e.g. later in 2030s) for a GO-train-sized trainset. That way, catenary is only required to Burlington/Aldershot. Battery power to Hamilton, and recharge while under catenary to Union.
Path #2 Forward for CP Freight Corridor: The other path to this is the
Canada Carbon Neutral Pledge 2050 will force government to force CP and CN to electrify their railroads (through gee-nerous subsidies & more permissive freight rules). This conceivably could be the path since this is very close to the year 2041 of the master plan of 15-minute service to Hamilton.
Could it happen sooner? Probably yes, with the battery-backed locomotives or EMUs. Battery locomotive performance is now adequate to haul a large GO train, as they are
already developing battery-electric locomotives for freight trains. But they are designed to operate only as an "assist" mode for difficult uphill runs, as well as railyards, etc.
However, with today's technology, there is finally now enough room on a catenary electric locomotive for battery capacity sufficient for the Aldershot-Hamilton gap. Haul the existing Bombardier/Alstom BiLevels if need be.
With a safety margin for a stuck-on-rails-in-winter with winter heating needs. A catenary-electric locomotive with a battery backup is already feasible today at battery densities made possible by Tesla 4680 cells or similar tech; so by 2035-ish, mature options should already be available to Metrolinx for 15-minute electric Hamilton service over CP trackage.
Why battery-catenary dualmode electric locomotives instead of EMUs for Lakeshore? The apparent Metrolinx plan seems to be use EMUs on the Kitchener-Stoufville corridor (due to tighter station spacing) and electric locomotives on Lakeshore (due to wider station spacing). That is another one of my predictions, although Metrolinx may go all out and go fully EMU eventually, I think they will stick to the big locomotives initially for now.
Thus, my predictions forks to two:
- If 15-min electric happens far sooner than Metrolinx 2041 RTP,
....It will probably require battery+catenary dual mode electric locomotives. This is the fastest path to 15-minute electric, by combining the current electric GO Expansion plan, with a solution that goes beyond the EA studied area (catenary stops in Burlington).
- If 15-min happens only during 2041 or 2051
....The sheer force of Carbon Neutral 2050 will force CN/CP anyway, and the train tech any electric tech (regular catenary electric EMUs or locomotives, no battery needed).
Obviously, we need to wait for technological maturity, but mature non-experimental battery-catenary dual-mode-electric locomotives will be on the market well before 2041. It won't be experimental tech in 2041.
