I'm reviewing the Capital Budget as I type:

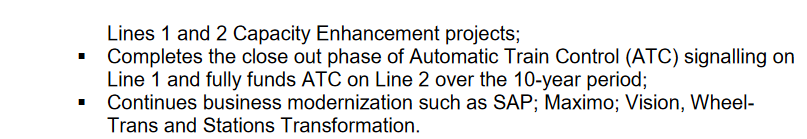

Of note so far: ATC on Line 2 now fully funded
***
- Somehow we are still paying for the TYSSE (beyond debt servicing)
- Waterfront Transit Design continues. This looks to me like their taking it to 100% design.......... hmmm
Additional Items:
8 new streetscars targeted for acceptance this year.
Platform Edge Doors now have a price tag and a line item but are 100% NOT funded. ~$2.8B
New TTC Bus Garage on Kipling has a timeline 2032-2038. ( 6 years to build a bus garage? )
Ha! My nagging got a project on to their list after years of trying; of course with a time horizon of 2039, should I be around to see it I will not be a young man!

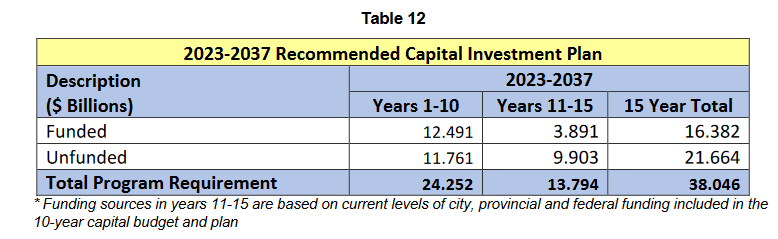

Here's something of note:
They years are Project Start, Project Finish. (in the case of the below, I believe this is merely real estate acquisition, as I don't think they are anywhere near ready to do Broadview )
Below, of note, a new siding on Line 1 in the Rosedale open-cut. Also interesting turn-of-phrase on the Line 2 West extension:
Next........is the TTC seriously contemplated starting the massive St. George Stn expansion project before they finish Bloor-Yonge?
Very interesting for UT'ers;
@interchange42 may wish to take note of TTC landholdings which will be in discussion for development opportunities with CreateTO in the years ahead.
****
Interesting to see the large amount of money devoted to second exits. Years below read from 2023 on the left:
